Regional Agencies Closely Monitor Water Quality in C-BT Reservoirs — @Northern_Water #ColoradoRiver #COriver #aridification

Willow Creek Reservoir algae bloom August 2021. Photo credit: Northern Water

From Northern Water:

Northern Water, the U.S. Forest Service, the U.S. Bureau of Reclamation, Grand County and additional regional health, water and recreation officials are closely monitoring a potentially harmful algal bloom that developed at Willow Creek Reservoir in July, a component of the Colorado-Big Thompson Project in Grand County.

In late July, monitoring teams found the presence of blue-green algae (cyanobacteria), which can sometimes produce toxins (cyanotoxins) that can be harmful to humans and animals. With this discovery, the U.S. Forest Service’s Arapaho National Forest placed restrictions on water contact recreation and posted signs informing the public of the issue.

Recent tests indicate the concentration of cyanotoxins in the two samples collected to be nearly negligible. However, because of evidence of algae in other parts of the reservoir where sampling has not occurred the reservoir remains under the existing restrictions for contact recreation.

Willow Creek Reservoir is part of the collections system for the Colorado-Big Thompson Project, which gathers water in the headwaters of the Colorado River for delivery to cities, farms and industries in northeast Colorado.

In the East Troublesome Fire of 2020, as much as 90 percent of the watershed that feeds into the reservoir sustained damage. This summer, the arrival of monsoonal moisture has increased the delivery of nutrients from the burn scar to the reservoir, and made these nutrients available to support increased growth of all kinds of algae. However, the vast majority of algae species are not harmful. Water recreation enthusiasts can learn more by viewing the Colorado Parks and Wildlife video and visiting the Colorado Department of Public Health and Environment links available from Grand County.

Water from Willow Creek Reservoir is pumped intermittently into Lake Granby to make room in Willow Creek Reservoir should future flooding occur. However, with a maximum capacity of 10,600 acre-feet, Willow Creek Reservoir is dwarfed by the 540,000 acre-foot Lake Granby, meaning the overall impact to the region’s water supply is negligible. In addition, water quality testing equipment installed in the aftermath of the East Troublesome Fire will be able to monitor key water quality metrics in the Colorado-Big Thompson Project. A monitoring program has been implemented to watch for algae blooms and potential toxins in the Three Lakes, as well as in Willow Creek Reservoir. Agencies will continue to review data and monitor the issue until the bloom disappears.

For information about water recreation opportunities on the Arapaho National Forest, visit http://www.fs.usda.gov/arp.

A joint press release among Northern Water, U.S. Forest Service, U.S. Bureau of Reclamation and Grand County.

#EstesPark: Town Board talks water resources — The Estes Park Trail-Gazette

Aerial view of Lake Estes and Olympus Dam looking west. Photo credit Northern Water.

From The Estes Park Trail-Gazette (Tim Mosier):

The one item on the agenda was Ordinance 11-21 (passed unanimously) which amends chapter 13.24 of the Estes Park Municipal Code (MC) regarding agreements to provide raw water.

According to a memo to the board from Utilities Director Rueben Bergsten and Water Superintendent Chris Eshelman, the amendment is to assure the responsible management of water resources by requiring Town Board approval for raw water agreements lasting more than a year.

“The responsible management of our raw water resources, I think we would all agree, is becoming more and more important,” [Rueben] Bergsten said at the meeting….

The question for the state as a whole, and Estes Park itself, is how many entities to allow access to our water resources and for how much?

“We do anticipate, as time goes by, more and more and more property owners are going to be coming to the Town of Estes Park asking for what’s called replacement water,” Bergsten told the board. “We do this for a lot of people. It’s a matter of keeping the local economy healthy.”

A typical client seeking replacement water is someone using well water, or river water for irrigation and have water needs that still outweigh their supply.

“The Town owns 300 acre-feet of Windy Gap water rights. Windy Gap water can fulfill augmentation plan requirements for replacement water,” the memo said. “The Town has occasionally entered into long-term agreements with entities to supply replacement water.”

The most recent agreements made were: Preuss in July 2020, Idlewild in April 2019, and Cheley Camp in May 2012.”

Bergsten and Eshelman believe these raw water lease agreements are beneficial to the local economy and the surrounding communities; however, they tie up the town’s water rights.

“Town Staff foresee an increase in the number of replacement water requests as the State Water Commissioner increases their effort to audit augmentation plans,” the memo said. “Their audits included private wells.”

While requiring Town Board approval for raw water agreements lasting more than a year does have advantages such as reducing the administrative workload required to account for water use and augmentation, and supporting the responsible management of the town’s water, Bergsten and Eshelman are mildly concerned they may appear to be over reaching.

“Requiring properties to connect to our system might appear heavy-handed; however, their alternative requires them to pay an engineering firm to develop an augmentation plan, hire a lawyer to process the augmentation through water court, and secure replacement water from the Town,” the memo explains.

Chimney Hollow Reservoir poised for construction — @Northern_Water #ColoradoRiver #COriver #SouthPlatteRiver #aridification

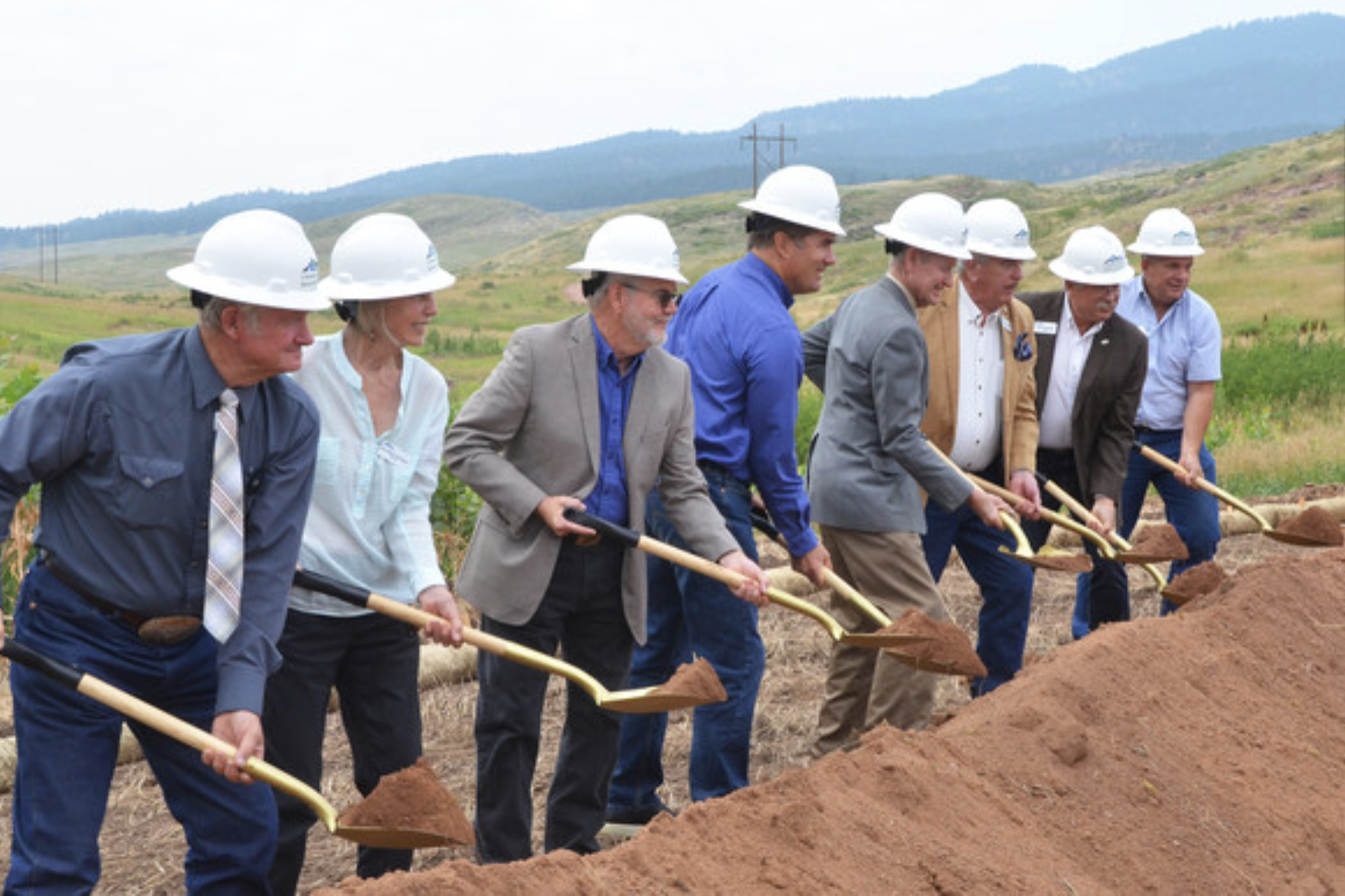

Members of the Northern Water Municipal Subdistrict Board of Directors turn ground at the site of Chimney Hollow Reservoir on Friday, Aug. 6. From left are directors Don Magnuson, Sue Ellen Harrison, David Nettles, Todd Williams, Vice President Bill Emslie, President Dennis Yanchunas, Mike Applegate and Dale Trowbridge. Photo credit: Northern Water

Here’s the release from Northern Water (Jeff Stahla):

Northern Water’s Municipal Subdistrict celebrated the groundbreaking for Chimney Hollow Reservoir on Friday, culminating a 20-year permitting process to add resilience to the water supply for more than 500,000 northeastern Colorado residents.

The groundbreaking also triggers a host of environmental efforts that will occur in the headwaters of the Colorado River on the West Slope. Those include construction of the Colorado River Connectivity Channel to reconnect portions of the river located above and below Windy Gap Reservoir, wastewater treatment plant upgrades in the Fraser River Valley, environmental improvement projects through the Learning By Doing coalition, and other work providing water and storage that can be used for environmental purposes.

“Today marks a long-awaited milestone that required years of hard work and cooperation among many groups with diverse interests to achieve a project that has benefits for everyone in Colorado,” said Northern Water General Manager Brad Wind.

The addition of water storage is a key component of the Colorado Water Plan. Our population continues to grow as climate change brings higher temperatures and greater precipitation variability to the Colorado River headwaters. Construction of Chimney Hollow Reservoir gives the regional Windy Gap Firming Project participants a reliable water supply during dry years.

Since the Windy Gap Project was envisioned, water managers have recognized the need for additional storage specifically dedicated to storing Windy Gap water. Currently the Windy Gap Project depends on Lake Granby to store water when the project’s water rights are in priority. However, Lake Granby’s first priority is to store Colorado-Big Thompson Project water.

Chimney Hollow Reservoir is a key component for these Windy Gap Firming participants: Broomfield, Platte River Power Authority, Loveland, Greeley, Longmont, Erie, Little Thompson Water District, Superior, Louisville, Fort Lupton, Lafayette and Central Weld County Water District. Each of the reservoir project participants that provide residential water service has committed to reduce per capita water supply through water conservation.

Northern Water’s Municipal Subdistrict and Larimer County cooperated to purchase the Chimney Hollow property in 2004 from Hewlett-Packard. Chimney Hollow Reservoir will provide a much-needed outdoor recreational opportunity that can be enjoyed by everyone in Northern Colorado.

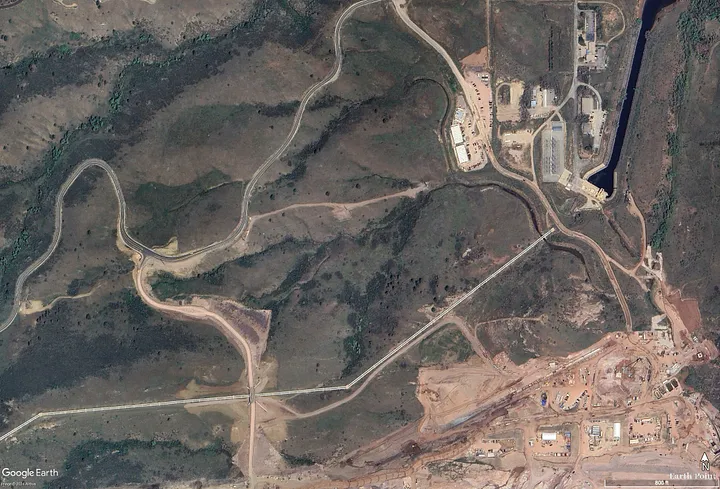

In recent weeks crews have been preparing the site for construction by bringing water and power to temporary administrative offices. In addition, the Western Area Power Administration relocated a high voltage power line from the footprint of the reservoir to a location up the hillside to the west.

Full dam construction activities are planned to begin Aug. 16. Barnard Construction Co. Inc. of Bozeman, Montana, is the general contractor for the four-year project. The cost of dam construction is estimated at $500 million, with the complete project including West Slope improvements at $650 million. The 12 project participants are paying its cost.

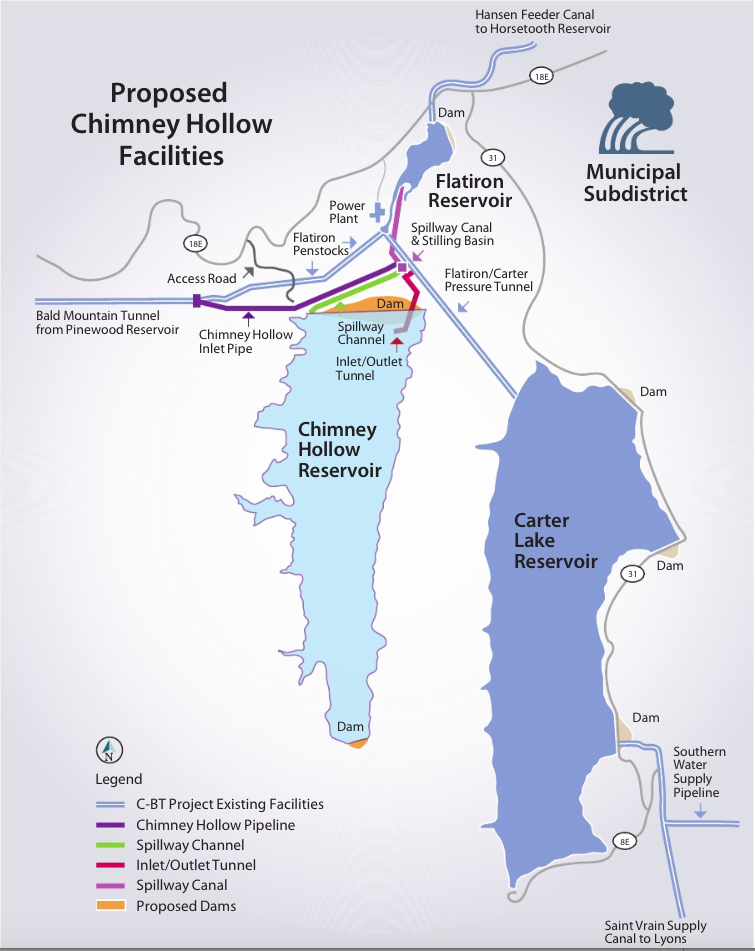

This graphic, provided by Northern Water, depicts Chimney Hollow Reservoir, located southwest of Loveland, after it is built.

When the dam is built, it will rise about 350 feet off the dry valley floor. The dam incorporates a technology common in Europe but less so in the United States. Its water-sealing core will consist of a ribbon of hydraulic asphalt instead of the clay that serves that purpose at the Carter Lake and Horsetooth Reservoir dams. Geologists discovered there wasn’t enough high-quality clay material within the footprint of Chimney Hollow Reservoir, and instead of bringing it in from elsewhere, the hydraulic asphalt core option was chosen. The dam’s rock-fill shoulders will use material mined from the reservoir footprint, which will reduce costs, pollution and increase storage capacity.

This new storage project allows us to supply clean water reliably, even in times of drought, to the people of northeastern Colorado from the existing Windy Gap Diversion. Starting construction on Chimney Hollow Reservoir is a major step to address water supply shortages for our growing population, much like our visionary predecessors did for us, while demonstrating that modern storage projects can also improve the environment.

For more information, go to http://www.chimneyhollow.org.

Site of Chimney Hollow Reservoir via Northern Water.

From The Greeley Tribune

More than 500,000 Coloradans across the Front Range can look forward to a more resilient water supply in the near future, after a groundbreaking Friday set in motion a $650 million project that will give water providers more reliable access to a vital resource that’s become increasingly scarce due to growing populations and climate change.

A crowd of about 200 gathered Friday morning for the groundbreaking of the Chimney Hollow Reservoir, a 90,000 acre-foot reservoir at least 20 years in the making. The reservoir will be located west of the Flatiron Reservoir in Larimer County.

A dozen municipalities, water providers and a power authority are participating in the Northern Water project, which boasts a price tag of $650 million, $500 million of which is for the dam construction. Other costs are going to environmental and water quality improvements in collaboration with affected communities. Adding in things like permitting costs, project manager Joe Donnelly said the total program costs were about $690 million.

Greeley is one of the participants, making up about 10% of the project. Other participants include Longmont, Fort Lupton, Central Weld County Water District, Broomfield and more. Greeley Water and Sewer director Sean Chambers said the city is putting about $57 million toward the construction…

The project had relied on Lake Granby to store water when the project’s water rights were in priority, but the lake’s first priority is to store Colorado-Big Thompson water. Over time, it became clear Front Range water providers would need a way to store Windy Gap water because the water wasn’t available when Front Range communities needed it the most…

Northern Water cooperated with Larimer County to purchase the Chimney Hollow property from Hewlett-Packard in 2004…

Drager and other speakers detailed numerous setbacks, including years of federal litigation after environmental groups filed a 2017 lawsuit. A judge in December dismissed the lawsuit, according to BizWest. The biggest setback, according to Drager, was needing to get a 1041 permit from Grand County. State officials also took issue when project officials hadn’t developed a mitigation plan with the state.

“We kind of argued a little bit, but we came to the conclusion that to really make this thing work, we would have to give something,” Drager said.

Restoring a river channel in the Upper Colorado Basin. Graphic credit: Northern Water

In a meeting with a Division of Wildlife official, they eventually settled on stream restoration for the Colorado River — one of many environmental considerations and concessions that helped pave the way for the partnerships that made the project possible…

Though some environmental work is being done at the site, most is at the headwaters of the Colorado River, according to Northern Water spokesman Jeff Stahla. The environmental mitigation and improvements will cost more than $90 million, including about $45 million to provide water for the river when it’s running low. Other improvements include helping the town of Fraser upgrade its wastewater treatment plant and stream restoration projects.

“These are things that wouldn’t have happened if this project doesn’t get built,” Stahla said. “By doing these things, it’s … mitigation and enhancement, because we’re not just mitigating for the effects of this project, but we’re enhancing what’s already there.”

The site will also serve as an outdoor recreational opportunity managed by Larimer County.

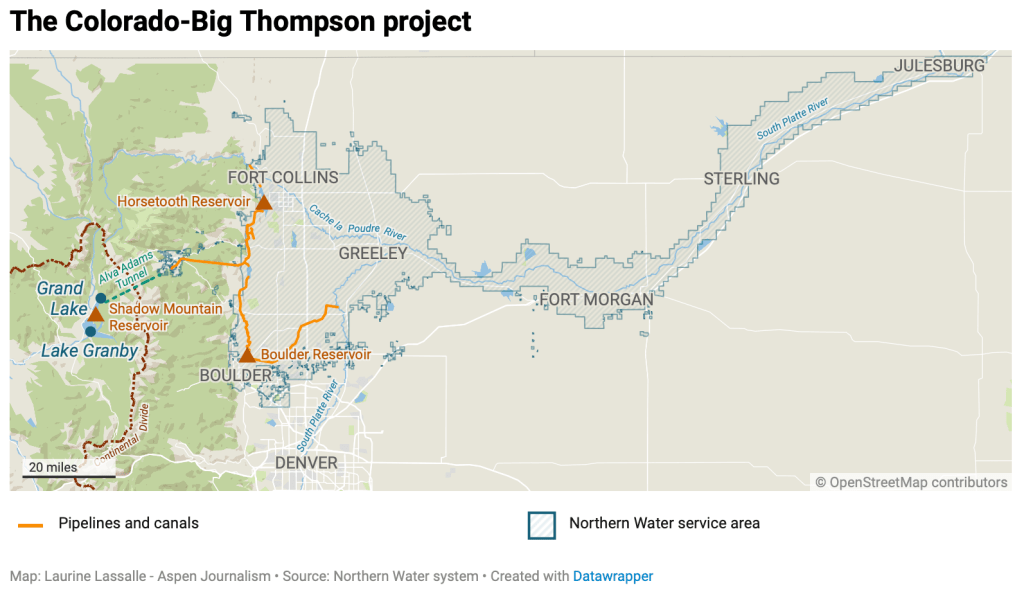

Map of the Colorado-Big Thompson Project via Northern Water

How a step forward is also a step back in headwaters of the #ColoradoRiver — Big Pivots #COriver #aridification

The confluence of the Fraser River and the Colorado River near Granby, Colorado. By Jeffrey Beall – Own work, CC BY 4.0, https://commons.wikimedia.org/w/index.php?curid=50012193

From Big Pivots (Allen Best):

Settlement involving Windy Gap yields $15 million for science-based work

In the early 1980s, when a dam on the Colorado River near its headwaters was proposed and Andrew Miller was a writer for the Winter Park Manifest, he wrote an editorial called “Requiem for a Cottonwood Grove.”

The headline was premature because the dam at Windy Gap, where the Fraser River flows into the Colorado, had not yet been constructed. But it soon was, causing the cottonwood trees to be felled and allowing water from the new reservoir to be pumped uphill to Grand Lake. From there the water flows into diversion under the Continental Divide called the Alva Adams Tunnel to be distributed among cities and some farms in the northern Front Range.

But that story almost 40 years later continues, as news of a settlement suggests. The Grand Foundation will soon receive $15 million remediation for work in Grand County, where the Colorado River originates. The money will be used to try to create strategies for preserving trout and other aquatic life in the warming but ever-more shallow waters.

The big story here is of incremental depletions of the Colorado River at its headwaters by growing Front Range cities now colliding with the impact of the warming climate, hotter and drier. The two, each powerful, leave in doubt how long cold water-loving trout can survive.
“Trout need water temperatures below 70 degrees, and we are regularly bumping up against 70 degrees in our rivers,” says Miller, now a contractor and president of the Upper Colorado River Watershed Group.

The $15 million will come from the municipal subdistrict of the Northern Colorado Water Conservancy District responsible for this incremental diversion. The district built Windy Gap to divert the waters to the northern Front Range. A subsequent project spurred by the distressing drought of 2002 and those of later years yielded an expansion of the diversions at Windy Gap.

This graphic, provided by Northern Water, depicts Chimney Hollow Reservoir, located southwest of Loveland, after it is built.

The additional water will be stored, in part, at a new reservoir snuggled among the foothills rising from the Great Plain southwest of Loveland. The dam to create that 90,000-acre-foot reservoir, called Chimney Hollow, has not yet been constructed.

The political subdivision responsible for the new diversion consists primarily of towns and cities, from Broomfield, Superior and Fort Lupton on the south to Loveland and Greeley on the north.

Save the Colorado and the Sierra Club, among other groups, in 2017 had sued Northern, arguing that the process used to review the impacts was deficient in failing to adequate address cumulative impacts. In December 2020 a federal court ruled in favor of Northern, but the environmental groups appealed.

In April, a compromise was announced. The environmental groups dropped the lawsuit and Northern agreed to the $15 million settlement in what Northern described as a productive alternative to costly litigation.

The financial documents of the settlement agreement are to be signed by directors of Northern on Aug. 6 and by the Grand Foundation on Aug. 10. Because of delays in signing, Northern will transfer the first payment totaling $5 million immediately after the Grand Foundation signs, says Gary Wockner, of Save the Colorado and an allied group, Save the Poudre.

Administering the $15 million grant will be the Grand Foundation, which is to consist of three members from Miller’s organization, the Upper Colorado River Watershed Group. In addition to Miller, Dave Troutman the treasurer, and Geoff Elliott, the staff scientist, will be on the committee responsible for overseeing allocation of the grant. Northern Water has authority to name the three other members.

“Our charge over the next 10 years is to spend $15 million in ways that improve Grand County’s watershed in a collaborative process,” explained Miller. “In some ways, we are on opposite sides of the fence,” he said, referring to the Northern District’s appointment members. “But in many of the important ways we are on the same side. We both depend upon high-quality water, Northern almost more than us.”

Other measures in the agreement address water quality and provide more water for Western Slope users.

Restoring a river channel in the Upper Colorado Basin

Separately, Northern plans to create a new channel around Windy Gap Dam, to allow the Colorado River to flow without impoundment. The channel is intended to allow fish, macroinvertebrates, nutrients and sediment in the river to bypass the dam and reservoir. The project is called the Colorado River Connectivity Channel. The bypass channel will be the result of a settlement negotiated by Trout Unlimited and others, says Wockner. No draft environmental assessment has been released. “It remains to be seen if the channel will be permitted, funded or built,” he says.

Because of its proximity to the northern Front Range farms and cities and its relative plentitude of water-producing snow, Grand County has been the go-to place for trans-mountain diversions since the late 1880s. The two most significant are those accomplished by the 6.2-mile pioneer bore of the Moffat Tunnel, which allowed diversions from the Winter Park and Fraser area to begin in 1936; and the 13.1-mile Adams Tunnel, which began delivering water to the Estes Park area in 1947.

Miller sees pressing task of the foundation set up to administer the settlement funds will be to lay down a baseline of existing conditions. The existing data, says Miller “really aren’t that good.”

Beyond that, the challenge will be more difficult, perhaps impossible.

“Basically we need to figure out how to run a watershed when we only have 30% of the natural water, which is about all we have left after the diversions by the Front Range.”

In addition to the stepped-up diversions by Northern Water, Denver Water also wants to take additional water through the Moffat Tunnel for impoundment in an expanded Gross Reservoir.

By at least some estimates, 70% of the native water of eastern Grand County currently gets exported to the Front Range. With these new diversions, exports will increase to 80%.

When these incremental diversions were first conceived not quite 20 years ago, the science of global warming was firming up but the effects were not yet evident, at least not like now. Even a decade ago, after significant drought had begun and temperatures had clearly started rising, the big picture was more tentative.

Miller’s group contends no water remains available from the Grand County headwaters of the Colorado River for additional diversion.

“I don’t think anybody realized how persistent this drought would be,” says Miller. “It could be a forever thing. We have created a new climate, and we will never see the rainfalls and snow we have in the past.”

Growing small towns along #Colorado’s Front Range plan for less #water — The Cronkite News #SouthPlatteRiver #ColoradoRiver #COriver #aridification

1st Street in Severance. By Jared Winkler – Own work, CC BY-SA 4.0, https://commons.wikimedia.org/w/index.php?curid=66581912

From KUNC (Jodi Petersen) via The Cronkite News:

Birdsong fills the air on a sunny May morning along Severance’s cottonwood-lined main street – but it’s soon drowned out by the roar of a backhoe.

The former farm town is replacing crumbling old water lines that serve a rapidly growing population. Severance, which is about an hour’s drive north of Denver, has seen its population double in the past five years, as home buyers thwarted by soaring prices in larger Front Range cities look for more affordable options.

“(We’re) a very quickly growing community in northern Colorado, I think a really good community, but definitely have seen a lot of growth,” said the town’s community development director, Mitch Nelson.

One of the biggest challenges Severance faces as its population climbs toward 8,000 is securing enough water for continued growth.

That wasn’t something Severance had to worry about just a decade ago. Now, as drought strains much of the state and tens of thousands of newcomers move to the bustling Front Range each year, places like Severance are thinking about growth – and water usage – in ways they never have before.

“In the past, the town’s future goals, from a land use standpoint, weren’t discussed alongside water conservation,” Nelson said. “That was the first step.”

As growing towns compare their existing water supplies to the needs of the new residents and businesses coming their way, they expect they’ll need more water. But figuring out where this new water will come from is the question. Large cities on the Front Range have senior water rights and long-established supplies, whereas small towns like Severance usually don’t.

Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

Severance gets its water from the Northern Weld County Water District, which in turn draws on the Colorado-Big Thompson project. The CBT, as it’s called, delivers water to more than 1 million Front Range residents each year. That water comes from the state’s Western Slope, where snowmelt in the headwaters of the Colorado River is diverted through a tunnel through the Continental Divide.

However, the cost of one unit of CBT water is approaching $65,000, double the cost just a few years ago, thanks to rapidly escalating demand and shrinking supplies due to a 20-year drought. A unit, which is enough to serve two average households in northern Colorado for one year, sold for $1,500 in 1990.

The burgeoning costs mean that towns have a financial incentive to conserve their existing water instead of simply trying to buy more. Lindsay Rogers, the Colorado Basin program manager for the WaterNow Alliance, says the choice is obvious…

Conserving water also is cheaper for homeowners; their rates don’t have to be increased to cover expensive new water sources. But conservation alone can’t meet all of a town’s future needs, Nelson said.

“You have to do both,” he said. “You have to acquire the potable water because that is what people use to drink, and reduce the usage of water for irrigation.”

That reduction in irrigation water is mostly going to happen in new developments, as Severance and similar towns work to integrate water planning into their land use planning.
Making growth water-smart from the start provides more bang for the buck…

Colorado towns can get help with planning from the state, and through such nonprofits as the Babbitt Center, the WaterNow Alliance and the Sonoran Institute. Severance participated in WaterNow’s training last winter and will get ongoing support from the group’s experts. In January, town officials approved an updated comprehensive plan.

The final plan, which will guide Severance’s land use code, incorporates water conservation throughout and is in line with state objectives for water planning. The plan identifies such opportunities as adopting water-efficient regulations for landscaping, requiring developers to secure their own water supplies for new subdivisions, and working with the Northern Weld County Water District to develop a fee structure that will encourage conservation…

Other small Front Range towns, such as Frederick, Johnstown and Evans, have created similar maps and plans. They’ve implemented water efficiency improvements and passed conservation ordinances. And they’ve bought out farms to use the water rights for more subdivisions.

Nelson said Severance is trying to avoid that.

“I think the goal is to maintain those historic uses and not dry this area up,” he said, “but allow for small scale farming all the way up to the standard agriculture operations we’ve seen historically.”

Chimney Hollow, Northern #Colorado’s biggest new reservoir, will likely be one of its last — The #FortCollins Coloradoan #ColoradoRiver #COriver #aridification

From The Fort Collins Coloradoan (Jacy Marmaduke):

Northern Colorado is getting its biggest new reservoir in about 70 years, at the cost of diminished Colorado River flows.

Construction of Chimney Hollow Reservoir will begin in August southwest of Loveland, just west of Carter Lake. An April legal settlement between project proponent Northern Water and environmental advocacy groups cleared the way for the project, which began the permitting process in 2003.

The 90,000-acre-foot reservoir is the main component of the Windy Gap Firming Project, a plan to increase the reliability of Colorado River water rights in the Windy Gap Project. The project’s 12 participants include Platte River Power Authority, Loveland, Broomfield, Longmont and Greeley. Construction is expected to take until August 2025, after which it will take about three years to fill the reservoir.

The reservoir’s water will come from the Colorado River, decreasing flows below Lake Granby by an annual average of 15%. Most diversions will take place in May and June.

The 18-year journey toward construction demonstrates the extensive maneuvering required to build new reservoirs in Colorado as rivers become increasingly stressed from climate change and heavy diversions as growing Front Range communities seek to shore up their water supplies. Northern Water won approval from key government agencies and some advocacy groups with a suite of mitigation measures and spending commitments for areas impacted by the project.

Map from Northern Water via the Fort Collins Coloradan.

Northern Water spokesman Jeff Stahla described Chimney Hollow as “in the right place at the right time.” The reservoir site has a few qualities that have helped Northern Water avoid some common setbacks for new water project construction: It’s near existing Colorado Big Thompson Project infrastructure, so Northern Water won’t have to build much new infrastructure for water deliveries, and there are no homes or businesses at the site, which Northern has owned since the 1990s.

“The one assumption you have to make is that water storage is part of the future way that we’re going to provide water,” Stahla said, and he thinks it is. “If you get past the ‘Do we need storage’ question, this ends up being an incredible site that will meet lots of needs, including the ancillary needs of recreation, into the future.”

[…]

Northern Water Engineering Director Jeff Drager acknowledged the new reservoir’s impact on Colorado River flows, but he said the project’s targeted mitigation efforts still offer a major value and are a key reason why it crossed the regulatory finish line.

Restoring a river channel in the Upper Colorado Basin

One of the most significant mitigation measures, known as the Colorado River connectivity channel, will involve shrinking the existing Windy Gap Reservoir in Grand County to about half its current size and building a new channel around it. The Windy Gap dam currently blocks the Colorado River, preventing movement of fish, silt and sediment.

The connectivity channel will allow the river below the reservoir to act more like “a stream without a reservoir on it” when Northern Water’s water rights aren’t in priority, Drager said. The mitigation measures will also open up a mile of stream to public fishing in an area where private landowners possess most of the land adjacent to riverbanks…

During wetter years, Lake Granby can overflow and the water that would’ve been delivered to Windy Gap users flows downstream. During drier years, Northern Water is often unable to divert the full extent of its water right because it is a junior right, meaning more senior water users get access to water first. During the 23-year period between 1985 and 2008, for example, no Windy Gap water was delivered for seven of those years.

A conversation with Brian Werner, recently retired from @Northern_Water — @WaterEdCO

Eric Wilkinson, left, and Brian Werner, on the job. Photo: Brent Gardner-Smith/Aspen Journalism

From Water Education Colorado (Jacob Tucker):

Although Brian Werner has served on the WEco Board of Trustees for just over a year, he was involved with helping found the organization nearly 20 years ago. Now retired from his 38-year career as the Communications Department Manager and Public Information Officer at Northern Water, and still a life-long water historian, Brian has written and given hundreds of presentations on the role of water in the settlement and development of Colorado and the West. We spoke with Brian about Northern Water’s storage, the impacts of fire on water storage, permitting, and more.

How long have you been on the WEco board?

I’ve been involved with WEco since WEco has been around. I was involved with the first couple incarnations of water education efforts in Colorado in the late 80’s and early 90’s, and then I helped when WEco came into being in 2002. I was never on the board, until a couple of years ago. It was something I wanted to do towards the end of my career and I retired just last year in January 2020. Luckily I was appointed to the board and I’ve truly enjoyed it.

What kind of experience do you bring to the group?

I think the fact that I had a 38-year career in the water business with Northern Water is an asset. At Northern Water, I’d established relations with people from all over the state and I also coordinated probably 150 to 200 different children’s water festivals, so clearly I was into education. I’m really a big believer in the trickle up theory of water knowledge. Where if you can educate the kids, that knowledge is going trickle up to mom and dad, and those kids will somebody be parents themselves. Ultimately, I’ve been trying to build that ethic in what I’ve been about for most of my career.

How would you describe your experience being on the board?

I’ve really enjoyed being on the board. I’ve watched it and been very much involved for a long time. Both Nicole Seltzer and Jayla Poppleton worked with me at Northern Water, so I have a personal vested interest in them succeeding, and they really have. Nicole moved the organization in a wonderful direction and Jayla has just been top-notch in where she has taken WEco. It has been really interesting because we have a diverse board, and I have enjoyed getting to know people who I didn’t know previously.

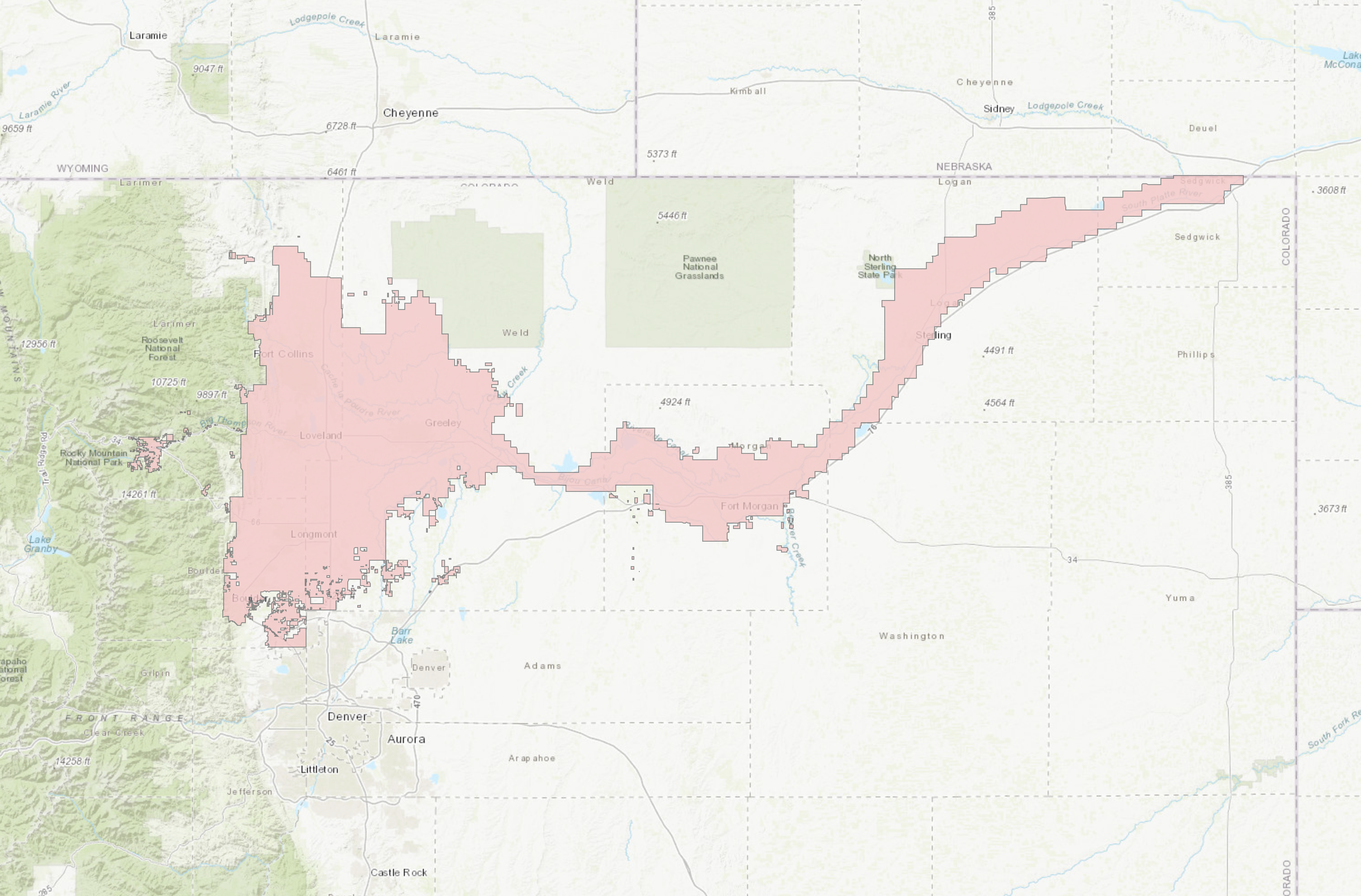

Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

I understand you recently retired from Northern Water, can you tell me what your role with them was and maybe what Northern Water does in a general sense?

Northern Water is the largest water conservancy district in the state of Colorado and operates a large Bureau of Reclamation project that is one of the largest in the entire western United States; the Colorado-Big Thompson project. It brings a quarter-million acre-feet a year from the West Slope into Northeastern Colorado to supplement both urban and rural supplies, meaning that it is both a municipal as well as an agricultural water supply. Now there are well over a million people that get a portion of their water supply from that project, but back in 1937, there were only 50,000 people living within Northern Water’s boundaries. So, nobody could have foreseen the growth that occurred since then. This growth has brought all sorts of issues and concerns, but Northern Water is one of the top water agencies in the state and I certainly had a wonderful career there and couldn’t have asked for anything better.

Personally, I was a public information officer for 35 of those 38 years. My role, in essence, was to be the public face of Northern Water and so I talked about Northern Water and its activities all the time. I was able to use my historical training, I have a master’s degree in history, to discuss the historical background of both water development and Northern Water. I focused very much on education, but ultimately, I spent my entire career talking all things water, which was a lot of fun.

I was also the manager of our communications department as we expanded and grew. As we grew, we brought on writers and pushed publications and annual reports, and then we got into the social media craze. So, for some time I managed that department. But really, it was about telling people what Northern Water was all about.

Perhaps a topical question, but how have the numerous forest fires affected the work that Northern Water does in trying to ensure water storage?

That is going to be Northern Water’s principal focus this coming year. Both of our major watersheds burned last year, the Upper Colorado with the East Troublesome wildfire, and then the Poudre watershed with the Cameron Peak wildfire. And both of these watersheds are where we get the vast majority of our water. Luckily, Northern Water had been looking at forest water management for years. Northern Water has been working with the U.S. Forest Service, the counties, the Bureau of Reclamation, and the National Parks Service. It wasn’t that these fires hit us and Northern Water had no idea what to do. We learned quite a lot from Denver Water after the Hayman Fire, with all of the issues that they had centering around water quality. Northern Water isn’t pleased, but we are certainly going to see some water quality impacts because of these fires.

We went in with our eyes open and with some plans in place for post-fire activities. We always said, ‘it’s not if, it’s when those fires hit.’

What do these fires mean for water supply and water quality now, as well as moving into the future?

One of the things that we see from these fires is a greater level of awareness in terms of forest management, not just if you have a house in a forest or nearby, but for those people living in major metropolitan areas, too. Those people in Denver, Fort Collins, and Colorado Springs are all paying attention now, because they saw the two largest fires in Colorado history and what it did to our environment. And I think now there will be a lot more attention focused on the post-fire impacts, which obviously include water. People will certainly be paying attention to the water piece of the post-fire mitigation and clean-up. Overall, I think moving into the future we will have a better awareness, which is always a good thing. There is no way around it, it is going to take money, and where we are at with COVID-19 that discussion is not easy, but the state is making a concerted effort to put monetary resources and people into handling the situation.

First water through the Adams Tunnel. Photo credit Northern Water.

How the present or future storage planning is different than what the state has done historically?

One thing I would point out is that the Federal government is no longer in the water storage building business. For years Reclamation, which had been established in 1902 helped jumpstart and build water projects, as they did the Colorado-Big Thompson Project in the 1930s, ’40s and ’50s. The Federal government neither has the resources nor are they paying for water storage anymore. Now, water storage is something that is having to be more or less self-funded. Meaning that the growing cities are trying to figure out how they can finance additional water for their future citizens.

We are also now looking at the multiple uses of water. Nowadays, water is being used for environmental purposes, which means that we are looking to make sure that there is enough to release into the rivers to help the aquatic habitat. This is a much larger part of the picture today. At a base level of awareness, we want people to understand why we need storage reservoirs. It is a dry year, and it sure looks like we are only getting drier, and when you have the drier years you better make sure that you store when you have the wetter periods to carry you through. I think we are going to have difficulties trying to match up the storage, which we are going to continue to need, with all the environmental issues and issues surrounding the development of water infrastructure.

Northern Integrated Supply Project (NISP) map July 27, 2016 via Northern Water.

In the past 20 years, Northern has been in permitting so can you talk about that process?

We say water project permitting works at a glacial pace. When I started working on the Northern Integrated Supply Project permitting at Northern Water, I told my wife that I thought we would have a permit in around 5 years … I’m now retired. Northern Water is going on 17 years later, and they still haven’t received that permit. That’s frustrating. This wasn’t for lack of energy; I mean we were really working hard to secure that permit. These things take much longer than you would probably expect. You have to have a lot of perseverance because the process can really drive you crazy, but my hope is that in the future this process will become much better for all parties involved.

@GreeleyWater: Dive into a look at the city’s water rights — The #Greeley Tribune

Seaman Reservoir upstream of confluence of the North Fork of the Cache la Poudre River. Photo credit Greg Hobbs.

From The Greeley Tribune (Trevor Reid):

In the past year, Greeley officials purchased about 1,000 acre-feet of water, equivalent to about 1,000 football fields covered in a foot of water. Adam Jokerst, deputy director of water resources for the city, said it’s more water than city had acquired in the past 10 years. Jokerst, who manages the water acquisition program, said the program has about a $9 million budget this year…

What is a water right?

Colorado’s waters are owned by the state and all its citizens, but water rights dictate the right to use the water. Water decrees, issued by water courts, confirm water users’ rights to that water.

Older water decrees were simple, Jokerst said, giving the example of a decree for the city’s senior direct rights, meaning the city has priority to divert water for direct application to beneficial use. Throughout the year, the city can use 12.5 cubic feet per second. That’s about it, he said.

Newer decrees can range from dozens to hundreds of pages, detailing how the water is to be diverted, measured and accounted for.

“Greeley owns a portfolio made up of many different water rights,” Jokerst said. “Some of those water rights are direct diversions from the Poudre River. Some are ownership in irrigation companies.”

Irrigation companies that historically provided irrigation water to farmers can issue shares of stock, basically selling a piece of the water rights held by those companies. The city converts that water from agricultural to municipal use to change the water right, though the city does rent some water rights to agricultural users, maintaining the historic use.

The city also owns water through the Colorado-Big Thompson and Windy Gap projects, as well as water diverted from the Laramie River. With a lot of variability across these different sources, the city’s water experts always plan for the worst case scenario: How much water could we provide to our customers in a drought situation?

Through the current plan, the city can provide about 40,000 acre-feet per year to its customers, well above the roughly 25,000 acre-feet of demand the city sees in a typical year. In a wet year, the city could potentially deliver up to 70,000 acre-feet, to give an idea of the impact of the planned drought.

When the city can, it rents a lot of that water to agricultural partners, renting about 20,000 acre-feet in the past year. In addition to maintaining historic use, this provides a source of revenue and supports Greeley’s agricultural economy, Jokerst said.

Jokerst said he’d consider the city’s “Big Three” sources to be:

  • Senior direct rights from the Poudre River
  • Ownership in the Greeley-Loveland Irrigation Company, which feeds the city’s Boyd Lake System
  • Colorado-Big Thompson (C-BT) and Windy Gap projects
  • Jen Petrzelka, water resources operations manager, added the direct and C-BT water is available year round, whereas a lot of the ditch directs only come in during irrigation season, which typically starts about now to early May and runs through the end of September or into October.

    Accounting for the city’s diverse portfolio

    The city must account for its water on a daily basis, submitting a monthly report to the state. Petrzelka said they manage about 10 different spreadsheets for all the city’s water right decrees…

    Petrzelka keeps an eye on the city’s water supply to help prevent the need for watering restrictions. In all, the city has four engineers and scientists who manage the various decrees and operations, plus three workers out in the field, according to Jokerst.

    The state ensures water users aren’t causing injury to other users’ water rights, with local river commissioners dedicated throughout the state. Jokerst compared the commissioners to a referee in a sports game.

    “Any time we change the way we’re operating, whether that be our releases or operating an exchange, we have to get their approval,” Petrzelka said.

    When agricultural water rights are changed, Jokerst said, some water is owed back to the river, just as the water historically returned to the river and groundwater after agricultural use.

    “A lot of what we do is add water back to the river to compensate for those irrigation rights that we changed,” he said.

    In addition to enforcement by river commissioners, everybody watches their neighbors, keeping track of what other users are doing on a day-to-day basis. Part of that monitoring happens in water court, where decisions about decrees are settled…

    Greeley has a steady stream of water court cases the city must defend in court, according to Jokerst, as well as cases involving other entities in which the city enters opposition to protect its water rights. As of this past week, the city was involved in 32 water court cases.

    “Water court cases are really just a structured negotiation where the applicant and the opposers reach agreement on whatever it is the applicant is trying to do,” Jokerst said. “All the parties involved negotiate an outcome that protects all their water and gets the applicant what they need.”

    Petrzelka and Jokerst estimated the city’s water court costs at about $500,000 this year, mostly covering the costs of outside attorneys and engineers. Internal legal counsel also helps guide the department, Jokerst said.

    @Northern_Water Increases Colorado-Big Thompson Quota to 70% #ColoradoRiver #COriver #aridification

    Moraine Park and the headwaters of the Big Thompson River in Rocky Mountain National Park. Moraine Park is on the east side of the park and of the continental divide, near the town of Estes Park. This region has a number of areas call “parks”, which refer to open, level areas in the mountains, usage which comes from the French word parque. The names of these areas predate the establishment of the national park and are unrelated to the use of the word “park” in that context. By The original uploader was Kbh3rd at English Wikipedia. – Transferred from en.wikipedia to Commons., CC SA 1.0, https://commons.wikimedia.org/w/index.php?curid=1009783

    From Northern Water:

    Adequate native water supplies coupled with improved Front Range soil moisture from March snowstorms prompted the Northern Water Board of Directors to increase its 2021 quota allocation for the Colorado-Big Thompson Project to 70 percent.

    The Board unanimously approved the allocation at its meeting Thursday, April 8, 2021, with several board members participating remotely because of the ongoing pandemic. The Board also directed Northern Water staff to update them in May and June to determine whether an additional allocation would be advisable during the peak demand season.

    Emily Carbone, an engineer in the Water Resources Department at Northern Water, outlined snowpack and forecasted streamflows, and the Board also heard about the available native water supplies in regional reservoirs. In addition, the Board heard a presentation about the potential water resources impacts caused by the 2020 East Troublesome Fire. Public input was also considered.

    The Board has been setting C-BT quota since 1957 and 70 percent is the most common quota declared. It was also the quota set for the 2019 water delivery season, while the 2020 quota was set at 80 percent. The quota reflects the amount of water to be delivered through the C-BT Project.

    The quota increases available C-BT Project water supplies by 62,000 acre-feet from the initial 50 percent quota made available in November. Water from the C-BT Project supplements other sources for 33 cities and towns, 120 agricultural irrigation companies, various industries and other water users within Northern Water’s 1.6 million-acre service area. According to recent census figures, more than 1 million residents now live inside Northern Water’s boundaries. To learn more about Northern Water and the C-BT quota, visit http://www.northernwater.org.

    @Northern_Water increases Colorado-Big Thompson quota to 70%

    Cache la Poudre River drop structure. Photo credit: Northern Water

    Here’s the release from Northern Water:

    Adequate native water supplies coupled with improved Front Range soil moisture from March snowstorms prompted the Northern Water Board of Directors to increase its 2021 quota allocation for the Colorado-Big Thompson Project to 70 percent.

    The Board unanimously approved the allocation at its meeting Thursday, April 8, 2021, with several board members participating remotely because of the ongoing pandemic. The Board also directed Northern Water staff to update them in May and June to determine whether an additional allocation would be advisable during the peak demand season.

    Emily Carbone, Water Resources Specialist at Northern Water, outlined snowpack and forecasted streamflows, and the Board also heard about the available native water supplies in regional reservoirs. In addition, the Board heard a presentation about the potential water resources impacts caused by the 2020 East Troublesome Fire. Public input was also considered.

    The Board has been setting C-BT quota since 1957 and 70 percent is the most common quota declared. It was also the quota set for the 2019 water delivery season, while the 2020 quota was set at 80 percent. The quota reflects the amount of water to be delivered through the C-BT Project.

    The quota increases available C-BT Project water supplies by 62,000 acre-feet from the initial 50 percent quota made available in November. Water from the C-BT Project supplements other sources for 33 cities and towns, 120 agricultural irrigation companies, various industries and other water users within Northern Water’s 1.6 million-acre service area. According to recent census figures, more than 1 million residents now live inside Northern Water’s boundaries. Learn more about the C-BT quota.

    @Northern_Water: Spring Water Users Meeting April 6, 2021 #ColoradoRiver #COriver #aridification

    Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

    Click here for all the inside skinny from Northern Water:

    Spring Water Users Meeting
    Tuesday, April 6, 2021, 8 a.m. to noon, virtual meeting via Zoom

    Each spring Northern Water meets with Colorado-Big Thompson Project allottees and water users to preview the upcoming water delivery and irrigation season, learn about current water and snowpack conditions, runoff and streamflow predictions, progress on future water projects and more. After a discussion of the region’s water outlook, attendees will be able to offer input about the 2021 C-BT quota. This year, attendees also will be able to learn about project updates, as well as Northern Water’s response to the East Troublesome fire in Grand County.

    A link to the Zoom meeting will be distributed in the days before the session to those who register.

    Click here to register.

    #Greeley irrigation company responds to ‘Fill the Love’ campaign to keep Lake Loveland — The Loveland Reporter-Herald

    Lake Loveland

    From The Loveland Reporter-Herald (Max Levy):

    ‘We have shareholders, and when there’s high demand, they’re entitled to use the water.’

    As a citizen campaign presses elected officials to intervene in the depletion of Lake Loveland, the Greeley Loveland Irrigation Co. this week responded to criticisms and concerns about the water level in the city’s central lake.

    Lake Loveland was transformed from a natural depression into a man-made reservoir around 1900. Today, GLIC operates the lake and owns the land it covers, which fills up in April and May. The company starts delivering water to clients around June, and drainage stops at the end of the irrigation season, around October.

    When the lake is drained, parts of the lake bed may become exposed, generating aesthetic complaints from residents as well as clouds of airborne dust.

    Greeley Loveland Irrigation Co. general manager Dan Kammerzell said Thursday that the lake was then 38% full, or about 20 feet deep at its deepest point (he said if the lake was filled enough to reach the edge of the landscaped area next to U.S. 34, it would be about 42 feet deep).

    He said he believes the frustrations fueling the recent Fill the Love campaign are due to a “misunderstanding” of the fact that the lake is a water storage resource. He added that water levels have always fluctuated with the piping of water to the company’s clients in Weld County…

    After a regular meeting of the company’s governing board on Wednesday, Kammerzell declined to answer additional questions about levels relative to past years but sent the newspaper a statement in which he said the lake is generally around 40% full when drainage stops in the fall.

    He added in the statement that one factor causing levels to drop in recent years was a 2018 decree by the Northern Water Conservancy District limiting how Colorado-Big Thompson water may be stored…

    In 2018, a rule introduced by the district ensured that project partners would only be able to store C-BT water if the water was released and used the same year, Kammerzell wrote. Greeley previously stored about 5,000 acre-feet of C-BT water in the Lake Loveland, a significant share of the lake’s 12,000-13,000 acre feet of storage capacity, but has since stopped…

    Loveland Water and Power director Joe Bernosky and City Manager Steve Adams sent a memo to the City Council last week laying out the city’s analysis the problem of “fugitive windborne sand” blowing off of the lake bed,

    Council members last held a closed-door meeting on Jan. 19 to talk about the water level of the lake as well as threats of lawsuits from nearby property owners because of the blowing dust. Loveland owns rights to less than 1% of the water and uses it to irrigate city parkland.

    The memo states that water levels were lower in 2018-19, when Greeley and GLIC were working on the hydraulic gates that allow filling and drainage of the lake.

    A 2020 analysis by Loveland Water and Power’s Water Quality Laboratory shows the dust is primarily comprised of quartz, making up about 60% of the material by weight on the north side of the lake and 56% to the south.

    The lab also tested the sediment for potentially toxic chemicals such as aluminum, arsenic, cadmium, copper, lead and iron, but “none were detected at concentrations of concern.” Further analysis showed that less than 5% of the lake bed dust was 10 micrometers in diameter or smaller — small enough to be breathable…

    Ultimately, the memo dismisses the possibility that the city could regulate the problem on its own or add its own water to the lake to cover more of the sand.

    It recommends that “the Lake Loveland Recreation Club Inc. and affected lakefront residents work with the GLIC to implement lake bed controls such as silt fences or roughening the surface through harrowing or chiseling” to stop the dust from becoming airborne.

    #EastTroublesomeFire could cause water-quality impacts for years — @AspenJournalism #ColoradoRiver #COriver #aridification

    Drivers between Granby and Walden will encounter many scenes of hillsides where only snags remain from the 193,000-acre East Troublesome Fire in October. Water managers say the worst impacts of the fire may be felt with summer rains. Photo credit: Aspen Journalism

    From Aspen Journalism (Allen Best):

    For some ranchers in Troublesome Valley, the worst impacts of the wildfire that began near there in October might not arrive until summer — or even summers beyond.

    Experts say the greatest danger of sedimentation from the East Troublesome Fire will occur during and after a hard rain, especially of an inch or more. That is when the severe soil damage from the fire will cause sediment to wash into the east fork of Troublesome Creek and into a diversion ditch used to irrigate 10,000 acres of hay.

    “It’s a real concern for us,” said Kent Whitmer, one of seven ranch owners who get water from the ditch owned by the East Troublesome Mutual Irrigation Co.

    Whitmer said he most fears sediment filling the ditch so badly that it overflows.

    “That would be disastrous,” he said.

    Agricultural and municipal water users will see broad, lingering effects of the 193,812-acre fire.

    The East Troublesome Fire, which had been burning east of Colorado Highway 125, exploded on the afternoon of Oct. 21, driven by 70 mph winds. In all, the fire grew 100,000 acres in 24 hours, eventually becoming the second-largest wildfire in the state’s recorded history. The fire was formally designated as contained Nov. 30, although small plumes of smoke could be seen in the golf course area as recently as Christmas Day. All but about 5,000 acres of the fire burned in Grand County.

    Denver Water may offer lessons useful to water managers, who will be dealing with impacts from the East Troublesome Fire for years, perhaps decades. Denver Water has struggled with sediment and debris clogging its two major reservoirs in the foothills southwest of Denver. The fires that caused problems for those reservoirs — Buffalo Creek in 1996 and Hayman in 2002 — fried soils, removing their ability to absorb moisture. Sediment has been washed up to 11 miles into Strontia Springs and Cheesman reservoirs, pushed by water during summer cloudbursts.

    Denver Water has spent $28 million in reservoir dredging, facilities repair and landscape-restoration projects. It discovered that debris and sediment can travel downstream to cause problems in critical water infrastructure. At Strontia Springs, Denver Water dredged for sediment as recently as five years ago but may need to do so again this year.

    “Dredging is very costly,” Denver Water watershed scientist Christina Burri said during the recent post-fire water impacts webinar. Retrieving sediment and debris can be challenging, and then there’s the issue of what to do with the debris. “Do you pile it? Do you burn it? Where can you take it?” Burri said.

    The East Troublesome Fire might produce fewer problems. A fire assessment called burned-area emergency response was conducted by U.S. Forest Service land managers and shows mostly low to moderate soil burn severity, suggesting lesser impacts to water quality.

    But water managers still expect significant challenges come spring, when melting snow produces debris and sediment that can clog bridges, culverts and reservoirs.

    This house north of Windy Gap Reservoir was among the 589 private structures burned in the East Troublesome Creek Fire. Water managers worry soil damage by the fire will cause sediment to clog irrigation ditches and municipal water infrastructure alike. Photo credit: Aspen Journalism

    Assessing the damage

    The fire came through in October “so quickly that it didn’t have a chance to do long-term scarring of the soil,” said Jeff Stahla, public information officer for the Northern Colorado Water Conservancy District. “However, this is still a sobering assessment because it really lays out the challenge we have going forward.”

    Northern Water operates the Colorado-Big Thompson diversion project, which employs Willow Creek, Granby and Shadow Mountain reservoirs as well as Grand Lake to deliver water to more than a million people and 615,000 irrigated acres along the northern Front Range and in northeastern Colorado.

    The district estimates the fire burned as much as 94% of the Willow Creek watershed, 90% of the area drained by Stillwater Creek, 29% of the Colorado River drainage above Shadow Mountain Reservoir and 42% of the North Inlet watershed. A more detailed assessment will be needed in the spring after snow has melted, Strahla said.

    “It’s not as bad as Hayman, but that doesn’t mean it’s not bad,” Stahla said, referring to the 138,000-acre fire in 2002 that was the largest forest fire in Colorado’s recorded history until last year. In size, Hayman was eclipsed by the three Colorado fires in 2020: East Troublesome, Cameron Peak and Pine Gulch.

    In assessing the damages caused by the East Troublesome Fire, resource specialists estimated 5% of the soil suffered high severity, 48% of it moderate severity and 37% of it low severity burns. Within the fire perimeter, 10% of the land was unburned.

    The mapping for the 22,668 acres of the East Troublesome Fire within Rocky Mountain National Park has not yet been released.

    Soil in severely burned areas has lost its structure, as the fire burned the forest litter and duff, weakening the roots of trees and other material that hold soil together.

    Areas of severe damage include the basin drained by the east fork of Troublesome Creek, where the fire was first reported Oct. 14. There, the fire hunkered down, moving slowly but burning most everything. Other notable severe burn areas are near Willow Creek Pass, between Granby and Walden, and a gulch immediately north of Windy Gap Reservoir. Some areas near Grand Lake burned with surprising severity.

    Erosion in high or moderate soil burn areas depends on the specific characteristics, such as the slope and soil texture, of each area, according to the burn report.

    Little that was live remained standing in this area along Colorado Highway 25, north of Windy Gap Reservoir, after the East Troublesome Fire. Agricultural and municipal water users will see broad, lingering effects of the fire. Photo credit: Aspen Journalism

    Watching the water

    Impacts to drinking water in Grand County will vary. Well owners generally should have no problems with the debris.

    “These folks will want to make sure that wellheads and components are not damaged, to test for coliform bacteria before drinking the water post-fire and to treat it if necessary,” said Katherine Morris, water-quality specialist for Grand County. “If a well is located in an area known to be down-gradient from an area where homes burned, it may be prudent to ensure that your water treatment is adequate.”

    At Grand Lake, the town draws water from 80-foot wells.

    “We have not seen anything yet,” said Dave Johnson, the water superintendent for Grand Lake. He said he doesn’t expect problems but that the water will continue to be monitored, as it has been.

    But Grand Lake’s microhydro plant could have problems. Located on Tonohutu Creek, the small plant constantly generates 5 kilowatts of electricity used in treating the town’s domestic water.

    “We can only filter out so much debris before we have to close the intake,” Johnson said.

    In that case, the water treatment plant will be operated solely by electricity from Mountain Parks Electric.

    Hot Sulphur Springs, which draws water from wells that tap the river aquifer, will be the only town in Grand County with municipal water supplies directly impacted by the fire. Kremmling also can tap the Colorado River, but it does so only in emergencies.

    Hot Sulphur Springs Mayor Bob McVay said his town expects challenges when the snow melts this spring, producing ash-laden water and debris. The town already has set out to take precautions, but it’s not yet clear what will be required.

    Upgrading of the filters in the town’s water treatment plant, a project that began a year ago, probably will be completed in January, providing duplicate filtering systems. But that might not be enough. Secondary wells in the groundwater along the river remain an option.

    In Troublesome Valley, Whitmer hopes to consult the expertise of the Natural Resources Conservation Service about how to mitigate effects of the fire on the irrigation ditch. He also wonders whether beaver dams in the East Fork will trap at least some sediment.

    For Northern Water, this was just one of several fires affecting its operations in 2020. It was impacted by fires on both sides of the Continental Divide, including the Cameron Peak Fire, the state’s largest wildfire, which affected the Poudre River and other creeks and drainages.

    Stahla said managers attempt to prepare for wildfire and other contingencies, but they did not prepare for such a severe wildfire season.

    “If you had come to us with a scenario that there is wildfire burning above Grand Lake, above Estes Park and throughout the Poudre River Basin, we probably would have pushed back, thinking that’s a little too over the top,” he said.

    Aspen Journalism covers water and rivers in collaboration with Swift Communications newspapers. Our water desk is funded in part by the Catena Foundation. This story ran in the Jan. 16 edition of the Summit Daily News and the Jan. 15 edition of Sky-Hi News.

    #CameronPeakFire’s threat to #PoudreRiver a concern for #FortCollins water supply — The Fort Collins Coloradoan

    From The Fort Collins Coloradoan (Miles Blumhardt):

    Mesmerized by miles of mountainsides of blackened trees and seared soil that hugs the banks of the upper Poudre River, it’s difficult not to reflect on the 2012 High Park Fire and 2013 flood.

    You can’t help but wonder, given the steepness of the slopes and the severity of the riverside scar left by the Cameron Peak Fire, if Northern Colorado is poised for a repeat of history regarding the Poudre River.

    Come spring, snowmelt, rainfall and potential flash floods are almost certain to wash large amounts of ash from Colorado’s largest wildfire, soil and even entire trees into the river that serves as a source of drinking water to hundreds of thousands of people in Fort Collins and the surrounding area…

    A recent Burned Area Emergency Response assessment for the Cameron Peak Fire indicated a 90% to 100% chance that water quality would be impacted by ash- and sediment-laden runoff, nutrient loading and potential debris flows within the first few years following the fire.

    And that’s only the half of it.

    Fort Collins receives half of its water from the Poudre River and the other half from Horsetooth Reservoir, whose water quality could be impacted by the East Troublesome Fire in Grand County.

    An assessment for the East Troublesome Fire estimated 53% of the burn area suffered moderate (48%) or high (5%) soil burn severity compared to 36% — 30% moderate and 6% high — for the Cameron Peak Fire. The Cameron Peak Fire assessment also showed more than half the soil tested to be repellent to water absorption…

    By the time the 112-day Cameron Peak Fire’s flames were finally extinguished on Dec. 2, a watershed recovery collaboration of area municipalities, Larimer County, federal and state agencies, water providers and organizations such as the coalition, was already meeting to start planning efforts to address the fire’s impact.

    This isn’t the first fire for many of those stakeholders, and lessons learned from the High Park Fire are helping the group quickly prepare for this spring’s impacts.

    That being said, the Cameron Peak Fire was more than twice the size of the High Park Fire and paired with the 193,812-acre East Troublesome Fire — the second-largest wildfire in state history — delivered a massive one-two punch to several watersheds, making recovery even more daunting…

    Mark Kempton, the city of Fort Collins’ interim deputy director of Water Resources and Treatment, said the city has implemented steps since the High Park Fire to better equip it to handle the after-effects of a major fire.

    He said the city has installed warning systems along the Poudre River that alert it several hours ahead of water turbidity issues so workers can turn off the water supply. When the city turns off the Poudre River supply, it can draw on Horsetooth Reservoir water. That was the case for 100 days during the High Park Fire.

    The High Park Fire taught recovery leaders to include the use of shredded tree mulch instead of straw mulch to better prevent the mulch from blowing away for soil and slope stabilization. Strategically increasing culvert size also reduced damage to roads.

    Kempton said another key component will be workers removing sediment by flushing the water treatment system more often and removing sediment from the river intake system and catch basins.

    Historic #Colorado Wildfire Season Could Impact Drinking #Water — CBS #Denver

    From CBS Denver (Dillon Thomas):

    The historic wildfire season of 2020 could impact drinking water for more than a million Colorado residents. Environmental researchers and natural resource specialists have conducted a BAER Survey, which stands for Burned Area Emergency Response.

    The survey evaluated how the record-breaking Cameron Peak and East Troublesome fires could impact Colorado’s snowpack and watershed.

    The Colorado Big Thompson Project, which Northern Water operates for the U.S. Bureau of Reclamation, lies between the Cameron Peak fire, shown at the top of the map, and the East Troublesome Fire, shown at the bottom left. Credit: U.S. Forest Service

    The Poudre and Upper Colorado River Basins provide drinking water for more than a million people in northern Colorado, and soon those in Thornton. The Colorado River also flows from Willow Creek Reservoir near Granby to Las Vegas and farther southwest.

    The months-long battle with both blazes charred the natural filters along rivers and creeks, which eventually provide drinking water for most of the northern front range.

    “Our concerns really are actually about the entire watershed,” said Jeff Stahla, spokesperson for the Northern Colorado Water Conservancy District.

    In an interview with CBS4’s Logan Smith, Stahla said the approach to preserving and protecting the watershed in the years to come was directly altered by the High Park Fire of 2012, where researchers learned what to do and what not to do.

    A helicopter drops water on the Cameron Peak Fire near CSU’s Mountain Campus. Photo credit: Colorado State University

    For example, pulling undersized culverts and digging water bars is more effective than reseeding or spreading hay bales.

    “This is something you won’t be able to resolve by dropping seeds from a helicopter, the scale is so large,” Stahla said. “The concern is that if there is a large weather event that occurs over that area, that you will have uncontrolled removal of debris and sediment that will go in to our reservoirs.”

    Ecologist Heidi Steltzer evaluates the site of a 2018 wildfire within 10 miles of her Colorado home. Changes in snow affect the disturbance regime of U.S. mountain regions. (Credit: Joel Dyar)

    During the fires of 2020, water conservation experts monitored how the burn scar could impact drinking water.

    “We recognized that it was no longer just a small localized event, but it was something that would effect the entire Upper Colorado River shed,” Stahla said.

    Due to the extended period the fires burned, especially the Cameron Peak Fire, not every area of the burn scars impact nearby rivers and streams equally. While some portions of the terrain were significantly burned with hot fire that “resided” in the same spot for an extended period, others were more fortunate.

    The East Troublesome fire as seen from Cottonwood Pass looking north on the evening of Wednesday, Oct 21, 2020. (Andrew Lussie via InciWeb via The Colorado Sun)

    Stahla said many local water districts are now teaming up to help protect the health of the watershed in the years to come. By unifying and prioritizing the health of the water system as a whole, Stahla said the strength of the landscape and watershed can bounce back quicker…

    Researchers hope to return to the burn scars in the spring once snow has melted to evaluate next steps. Local municipalities are working with the Bureau of Reclamation to expedite the process.

    Squeezed by two megafires: @Northern_Water’s race to save #Grand Lake — @WaterEdCO #ColoradoRiver #COriver #aridification

    The East Troublesome Fire in Grand County burned down to the shore of Willow Creek Reservoir, one of the lakes in Northern Water’s collection system in Grand County. Dec. 13, 2020. Credit: Jerd Smith

    From Water Education Colorado (Jerd Smith):

    Craig Friar and Steve Anderson had seen wildfires smolder and flare before. But they had never seen one run.

    Until Oct. 21 when Grand County’s East Troublesome fire sprinted 17 miles in less than three hours, threatening to engulf communities across the county and giving these Northern Water staffers and others just hours to decide how best to move the water agency’s operations center out of Grand County and over to Northern’s emergency operations center in Berthoud, on Colorado’s Front Range.

    It was unchartered territory. The backup center had never been used before.

    Northern Water is the largest exporter of water from Colorado’s West Slope to the Front Range, serving farms and dozens of cities from Broomfield and Lafayette to Boulder, Loveland and Greeley.

    As dark, fire-stained clouds billowed over the towns of Granby and Grand Lake that day, Northern’s West Slope team grabbed operation logs from the Farr pumping plant on the banks of Lake Granby. They tracked down the half dozen or so mechanics, electricians and operators who would need to make quick exits, and figured out how to ferry everyone to safety over the Continental Divide.

    The East Troublesome Fire burns in Grand County in October 2020. Credit: Northern Water

    Initially they hoped to keep most of their operators on the West Slope by moving the temporary command center farther West to another Northern operations site. But the East Troublesome Fire, already known for its cranky, unpredictable nature, changed direction, blocking access to the local site.

    “Those [plans] quickly went away,” said Friar, who oversees the utility’s collection system. “When things blew up on Tuesday, we said, ‘Scrap that.’ Wednesday we had a call and began moving everyone over to Berthoud.”

    Spare rooms and horse trailers

    Northern Water General Manager Brad Wind and Director of Administration Karen Rademacher offered their homes to dislocated staffers until hotel rooms could be found.

    West Slope staff who weren’t evacuated offered trailers to those who had been, hauling household goods and horses. They tracked down housing for co-workers who feared their homes had burned.

    They had dozens of calls with the U.S. Bureau of Reclamation, which owns Northern’s system, as well as emergency managers with the U.S. and Colorado State forest services and the Grand County fire and sheriff departments, and county emergency response teams.

    Hundreds of homes and structures in Grand County were threatened or destroyed, and the lakes and reservoirs there that comprise Northern’s water collection system faced the same fate. The agency serves more than 1 million people on the Front Range.

    Since mid-August, Northern’s team had watched the Cameron Peak Fire burning in Rocky Mountain National Park just to the north of Grand County, threatening some of Northern’s customers and watersheds, but not the heart of its collection system.

    When East Troublesome exploded eight weeks later, the water utility found itself suddenly squeezed between what have now become Colorado’s two largest wildfires in recorded history, with Cameron Peak consuming 209,000 acres and East Troublesome 194,000, before both were declared contained in November.

    The Colorado Big Thompson Project, which Northern Water operates for the U.S. Bureau of Reclamation, lies between the Cameron Peak fire, shown at the top of the map, and the East Troublesome Fire, shown at the bottom left. Credit: U.S. Forest Service

    Beyond bad

    “It was worse than any worst-case scenario we had,” said Northern’s Environmental Services Manager Esther Vincent during a debriefing with the utility’s customers and others post-fire.

    East Troublesome Fire. Photo credit: Brad White via The Mountain Town News

    Water infrastructure in the West is often built in high-altitude mountain ranges in order to collect the winter snows that fall and melt into streams.

    For years, Colorado and other Western States have planned for and dealt with wildfires and their aftermath: the scorched soils and trees that clog their delivery systems, fill their reservoirs with eroded soils, and cloud their once-pristine water supplies.

    But the situation now is much worse. As climate change and searing droughts have dried out the forests that blanket these watersheds, impossibly large, so-called megafires are becoming the dangerous new norm.

    These fires devastated California over the summer and the same phenomenon struck Colorado in the fall.

    That Northern Water found itself stranded between the two fires in hurricane-force winds was something no one had ever envisioned. There was a sense of awful wonder, amid all the emergency phone calls and late-night planning sessions, at the sheer size of the disaster.

    Powering down

    There was also plenty of worry. Early on, as the fire raged, Northern staffers knew power to the Farr Pump Plant would be cut off in order to keep firefighters safe from exploding transformers, falling power poles and downed electric lines.

    The East Troublesome Fire burns near the Farr Pump Plant on Lake Granby October 2020. Credit: Northern Water

    The pumping plant lies almost entirely below the surface of Lake Granby. Without power to run its dewatering system, the plant would flood.

    But there would be an even bigger problem once the electricity was cut. The Adams Tunnel takes water pumped from Lake Granby to Grand Lake and pipes it under the Continental Divide to the Front Range. If they couldn’t get the Adams Tunnel shut down before the power went off, it would continue to deliver water, dramatically lowering Grand Lake in violation of federal law, something that would trigger an environmental, legal and political firestorm.

    The prospect of such an event is unfathomable, Friar said. “I don’t know what would happen. And I don’t want to know. We don’t even go there.”

    They moved quickly to get to the controls that operate the tunnel, successfully closing it down.

    Ten minutes later, Friar said, the power went off.

    For days afterward, they would rotate the chore of going into the silent pumping plant, filling its generators with diesel fuel and checking to make sure the dewatering system was still working.

    In and out

    Roads in and out of the area remained closed and it took close coordination with the Grand County Fire Department and sheriff for Northern staffers to get past the fire barricades.

    “We had to make sure we could get in, get what we needed done, and get out of there,” Friar said.

    If there was any comfort during the tense, fast-changing days that the fires ruled Larimer and Grand counties, it was seeing local residents pulling out clothes and food for those in need, offering up spare rooms, spare trucks and trailers, and extra flash lights, snow plows and generators.

    “I don’t think anyone up here ever felt alone,” Friar said.

    December has delivered more elegant white snows to Grand and Larimer counties since October, when the first winter storm calmed the fires. The white slopes, covered with charred forests that are now stark and black, are a welcome respite from the gray smoke and flames that enveloped the area just a few weeks ago.

    Friar and others know they have four short months, the time until winter snows melt, to engineer and put into action a high-stakes rescue plan for the devastated watersheds and reservoirs.

    Roughly 30 percent to 80 percent of Northern’s four major watersheds have burned, they estimate. Cleaning them up and protecting the lakes from the debris that is sure to come after the snow melts next spring will take one to three years of “acute” work, fire officials said, and decades of additional treatment, a process so expensive that Northern hasn’t yet put a number to it.

    The East Troublesome fire as it tore through the Trail Creek Estates subdivision on Oct. 21, 2020. (Brian White, Grand Fire Protection District)

    A daunting future

    Denver Water, the only utility larger than Northern in Colorado, battled two smaller—but still epic—fires within the past three decades: the 1996 Buffalo Creek Fire and the 2002 Hayman Fire, which until this year had been the state’s largest. They spent $28 million cleaning up and restoring reservoirs in the first 10 post-fire years and continue to spend millions annually planting trees and doing erosion control, according to Christina Burri, a watershed scientist with Denver Water.

    Northern’s Greg Dewey will oversee the fire restoration work. The prospect, he said, is daunting.

    “For years we’ve planned for treatments [for the overgrown forests already decimated by pine beetles]. And the ultimate treatment is a wildfire, but I don’t think anyone could have gauged the extent of this,” he said.

    The Cameron Peak and East Troublesome megafires have blazed permanent images in the minds of people across Grand and Larimer counties.

    What Anderson remembers most now is returning to his Granby home when the evacuation orders were finally lifted. There, he and his family encountered a strange sight:

    The house was unharmed, but the front door stood wide open.

    As they walked warily up the front steps the first thing they heard was the fire alarm, issuing one piercing screech after another, providing a crazy, haunting reminder of those days in October, when two megafires ruled the skies, the forests and their lives.

    Jerd Smith is editor of Fresh Water News. She can be reached at 720-398-6474, via email at jerd@wateredco.org or @jerd_smith.

    Colorado River “Beginnings”. Photo: Brent Gardner-Smith/Aspen Journalism

    A US District Court judge has ruled in favor of the Windy Gap Firming Project, clearing the way for construction of Chimney Hollow Reservoir — @Northern_Water #ColoradoRiver #COriver #aridification

    Here’s the release from Northern Water (Jeff Stahla):

    A United States District Court judge has ruled in favor of the Windy Gap Firming Project, clearing the way for construction of Chimney Hollow Reservoir near Berthoud. This ruling should also make it possible to move forward with environmental mitigation and enhancements related to the project, including construction of the Colorado River Connectivity Channel near Granby.

    Judge Timothy M. Tymkovich dismissed a 2017 lawsuit filed by environmental groups led by Save the Colorado against the U.S. Bureau of Reclamation and the Army Corps of Engineers. The ruling holds that those federal agencies complied with federal law in issuing a Record of Decision that authorizes the Windy Gap Firming Project.

    The Windy Gap Firming Project includes the construction of Chimney Hollow Reservoir, which will be located in a dry valley just west of Carter Lake in southwest Larimer County. The reservoir will store 90,000 acre-feet of water from the Windy Gap Project for use by 12 participants, including Broomfield, Platte River Power Authority, Longmont, Loveland, Greeley, Erie, Little Thompson Water District, Superior, Louisville, Fort Lupton, Lafayette and the Central Weld County Water District. Chimney Hollow Reservoir will make the Windy Gap water supply serving those participants more reliable and help them meet a portion of their long-term water supply needs. Each participant has also enacted a water conservation plan to comply with the Record of Decision.

    Environmental measures related to the Project also include the Colorado River Connectivity Channel, a newly proposed channel around Windy Gap Reservoir to reconnect the Colorado River above and below the reservoir. The channel will restore the ability for fish, macroinvertebrates, nutrients and sediment in the river to bypass the reservoir.

    The Record of Decision also mandates many other environmental protections, including improving streamflow and aquatic habitat, addressing water quality issues, providing West Slope water supplies and more. Northern Water and its Municipal Subdistrict negotiated with Colorado River stakeholders to develop this package of environmental protections and received a permit from Grand County and approvals from others, including Trout Unlimited and the State of Colorado, to move forward with the Project.

    Water storage such as Chimney Hollow Reservoir was specifically identified in the Colorado Water Plan as a necessary component for Colorado’s long-term water future. It joins conservation, land use planning and other solutions to meet future water needs in the state.

    “This ruling marks an important milestone for the participants in the Windy Gap Firming Project,” said Northern Water General Manager Brad Wind. “Chimney Hollow Reservoir and the Colorado River Connectivity Channel will serve as examples of how statewide cooperation can produce water supply solutions and environmental improvements that benefit everyone.”

    Barnard Construction Co. Inc. has been chosen as the contractor to build Chimney Hollow Reservoir, and work will commence on the project in 2021. Design work is well under way for the Colorado River Connectivity Channel, and construction is anticipated to begin there in 2022.

    Shoshone power plant outages concern Glenwood Canyon #water users — @AspenJournalism #ColoradoRiver #COriver #aridification

    The Shoshone hydro plant in Glenwood Canyon, captured here in June 2018, uses water diverted from the Colorado River to make power, and it controls a key water right on the Western Slope. Photo credit: Brent Gardner-Smith/Aspen Journalism

    It has been a rough year for operations at the Shoshone hydropower plant in Glenwood Canyon.

    First, ice jammed the plant’s spillway in February, damaging equipment that required repair. The plant came back online in July but was able to generate electricity for only a few weeks before the Grizzly Peak Fire burned down its transmission lines.

    According to the plant’s owner, Xcel Energy, the electricity impacts of the outages at the 15-megawatt generating station have been minimal, and the utility expects the plant to go back online this week. But while the electric grid can manage without the plant, the outage presents a much bigger threat to the flows on the Colorado River because the plant has senior water rights dating to 1902.

    This means that any water users upstream with junior rights — which includes utilities such as Denver Water that divert water to the Front Range — have to leave enough water in the river to meet the plant’s water right of 1,250 cubic feet per second when the plant is running. When the Shoshone makes a call, the water makes its way through the plant’s turbines and goes downstream, filling what would otherwise often be a nearly dry section of river down toward Grand Junction.

    A Shoshone call keeps the river flowing past the point where it would otherwise be diverted, supporting downstream water uses that would otherwise be impossible on this stretch of river. But when the plant is down, as it has been for most of 2020, that call is not guaranteed.

    The Grand River Diversion Dam, also known as the “Roller Dam”, was built in 1913 to divert water from the Colorado River to the Government Highline Canal, which farmers use to irrigate their lands in the Grand Valley. Photo credit: Bethany Blitz/Aspen Journalism

    “Historically, what the Shoshone plant has done is kept a steady baseflow, which makes it easier for irrigators down here to be able to divert their own water right,” said Kirsten Kurath, a lawyer for the Grand Valley Water Users Association, which represents agricultural water users. “When the river goes up and down, it takes a lot of operational effort.”

    The Shoshone water right also supports important nonconsumptive water uses. It provides critical flows needed for fish habitat and supports a robust whitewater-rafting industry in Glenwood Canyon. When the river drops too much below 1,250 cfs, it can create for a slow and bumpy ride.

    Glenwood Canyon/Colorado River. Photo credit: Allen Best/The Mountain Town News

    “Customers get off and think, ‘Ugh, it would have been more fun to go to Disneyland,’ ” said David Costlow, the executive director of the Colorado River Outfitters Association. “Much lower and you are really scraping down that river and at some point you just pull the plug.”

    The nearly year-long outages at Shoshone have many on the river worried. When the plant is down for repairs or maintenance, it does not make its call on the river allowing users upstream — including those that pipe water to the Front Range — to begin diverting. The Shoshone call can be the difference between the water remaining on the Western Slope or being diverted to the Front Range. Long outages, such as this one, reveal the vulnerability of the water on which so many rely.

    “It’s a critically important component to the way that the Colorado main stem water regime has developed over more than a century now,” said Peter Fleming, the general counsel for the Colorado River Water Conservation District. “It’s sort of the linchpin or the bottom card.”

    Water interests on the Western Slope have made some headway in recent years to maintain the status quo on the river even when Shoshone is down. Most of the major junior water-rights holders upstream of the plant — including Denver Water, Aurora and the Colorado Big Thompson Project — have signed on to the Shoshone Outage Protocol (SHOP). When the protocol goes into effect, as it has this year, these diverters have agreed to manage their diversions as if the Shoshone Plant — and the call — was online.

    The agreement has been in operation for about a decade, helping to maintain flows during periods where the plant has undergone repairs or maintenance. The agreement was formalized in 2016 with a 40-year term. While the outage protocol has staved off major drops in the Colorado River flow over the years, the agreement is not as secure as water users that rely on Shoshone’s flows would prefer.

    “SHOP is the best alternative that we have right now, but it doesn’t completely restore the flows,” said Kurath. “And one of the other problems right now is that it’s not permanent.”

    For water users downstream of Shoshone, SHOP has three major issues. First, it is only guaranteed for 40 years, which for water planners is considered a short time frame. Second, the agreement does not include every upstream diverter, meaning that it doesn’t completely restore the flows to the levels where they would be if the Shoshone plant were on. Third, the agreement allows some of its signatories to ignore SHOP under certain water-shortage scenarios.

    Despite the drought this year, the conditions never reached a point where SHOP’s signatories were able to opt out of the protocol, so the agreement went into effect when river levels dropped. But even though SHOP worked this year, the long outages at the Shoshone plant highlight the uncertainty of the plant’s future.

    “We’ve always been nervous about it,” Fleming said. “It’s an aging facility, it doesn’t produce a ton of power, and we don’t know how long it’s going to be a priority to maintain and operate.”

    The River District has been working to negotiate a more permanent solution for the Shoshone water rights for years. They have considered everything — from trying to buy the Shoshone plant outright to negotiating with diverters on the river to make something such as SHOP permanent.

    The Shoshone outages have given these efforts renewed importance. In a recent board meeting of the River District, Fleming said that resuming talks with Denver Water that had stalled during the pandemic is a top priority.

    While Fleming would not elaborate on the specifics of the ongoing negotiations, all options have the potential to impact many water users on the river — even those who aren’t at the negotiating table.

    “We don’t approach this like we have water rights that we don’t have,” Costlow said. “But our business depends on water, and it depends on water levels that make water fun.”

    This story ran in the Nov. 13 edition of The Aspen Times.

    #FortCollins #water restrictions end Tuesday, with completion of work on the outlet at Soldier Canyon dam — The Rocky Mountain Collegian

    The Soldier Canyon Dam is located on the east shore of Horsetooth Reservoir, 3.5 miles west of Fort Collins, Colorado. The zoned earthfill dam has an outlet works consisting of a concrete conduit through the base of the dam, controlled by two 72-inch hollow-jet valves. The foundation is limey shales and sandstones overlain with silty, sandy clay. Photo credit Reclamation.

    From The Rocky Mountain Collegian (Nicole Taylor):

    The mandatory water restrictions in Fort Collins are scheduled to end Nov. 10. On Nov. 8, Darin Atteberry, Fort Collins city manager, signed a declaration to end the restrictions.

    The restrictions were put in place on Oct. 1 as a level IV restriction due to the Horsetooth Outlet Project. The repairs were successfully completed over the past month with the help of backup pumps and community efforts, according to the announcement…

    Recent concerns for the water supply with the recent drought conditions and the Cameron Peak fire also played a role in the water reduction.

    The residents managed to reduce water use by 35% within the first day of restrictions, according to the HOP page on the Fort Collins Utilities website. The community then stayed below the 15 million gallons a day request since Oct. 14 rather than the usual 35-40 million gallons.

    #Loveland council to study update to raw #water master plan, water fees, November 10, 2020 — The Loveland Reporter-Herald

    Looking east toward the Chimney Hollow Reservoir site, which is just this side of the red ridge. On the other side is Carter Lake Reservoir and beyond that, the Loveland area.

    From The Loveland Reporter-Herald (Max Levy):

    The plan was first approved in 2005 as a way of ensuring that the city has enough water without having to cut back, even in a once-in-a-century drought. It was updated by the council in 2012.

    Prepared by city staff members, the update includes several major recommendations. First, the city recommends using a model created by Spronk Water Engineers to continue prepping for a major drought, which was modeled based on the historic drought Colorado faced in 2002.

    While the plan encourages water conservation as a buffer and a way of ensuring water security in the event of an even more severe drought, the plan notes that it is not “a tool to directly reduce future demands in long-term planning.”

    A target of 30,000 acre-feet remains the city’s long-term goal for water demand. Currently, Loveland has access to a firm yield of about 25,210 acre-feet per year, which should increase by about 5,680 acre-feet by 2031, if the Chimney Hollow Reservoir west of Loveland and the Loveland Great Western Reservoir in east Loveland are completed as recommended.

    The master plan projects the resulting 30,890 acre-feet would be enough to support the city until 2056.

    Loveland customers used about 13,129 acre-feet of treated water last year, or about 0.166 acre-foot per person.

    Points of the recommended policy on developer contributions to the city’s raw water portfolio include:

  • Requiring at least half and allowing up to 100% of most contributions to be made in the form of Colorado-Big Thompson Project water, cash-in-lieu or cash credits in the Loveland Water Bank.
  • Decreasing the value of a C-BT credit from 1 acre-foot to 0.9 acre-foot.
  • Adjusting credits for ditch shares based on the content of the Spronk analysis.
  • Removing the 5% administrative cost on the cash-in-lieu fee and placing no limit on the amount of cash-in-lieu transactions, as long as they’re dedicated to a specific project.
  • Tying storage fees to the estimated cost of storage at Chimney Hollow Reservoir.
  • Including a fee of $482 per acre-foot in the native water storage fee to cover the engineering and legal costs of changing the use of native water in Colorado’s water courts.
  • Changing the name of the native water storage fee to the “storage fee.”
  • The plan also leaves open the possibility of the city exploring the use of untreated water for irrigation, taking into account “concerns of cross-contamination and the relatively high expense of building a new utility in already developed parts of the community.”

    Updates to water-related fees would go hand-in-hand with the plan and reflect the increasing costs of the Chimney Hollow project and C-BT water.

    For the cash-in-lieu fee, in addition to eliminating the 5% administrative add-on, the new calculation would divide the average annual C-BT price by 0.9. Previously, the fee was tied to the average price over the past three to six months.

    The native water storage fee would increase by between $15,132 per acre-foot of native water to $21,772 per acre-foot, depending on the source.

    Raw water impact fees would increase for commercial, irrigation and some residential taps and would be phased in over a period of two to 10 years.

    Loveland’s council will not vote on the items Tuesday, but members will give direction to the staff before the proposal comes back for a future vote.

    Northern Front Range water supply safe in spite of fires — for now — The #Greeley Tribune

    Colorado Rivers. Credit: Geology.com

    From The Greeley Tribune (Cuyler Meade):

    …while a significant portion of the water supply that is held and accessed by the project that serves the northern Front Range communities is impacted by the fires, the water supply itself is not in danger.

    According to Jeff Stahla, public information officer for the Northern Colorado Water Conservancy District — or simply Northern Water — the near-term supply is fine.

    The decision to close off a tunnel — which transports water pumped from Lake Granby to Shadow Mountain Reservoir before traveling by gravity through the tunnel through Rocky Mountain National Park to Lake Estes and elsewhere, before eventually settling in Horsetooth Reservoir and Carter Lake in Fort Collins and Loveland — will not impact the water supply that’s eventually drawn from those two reservoirs to supply much of Northern Water’s million-plus customers in Northern Colorado, including Greeley.

    That’s because, Stahla explained, the system is proactive. While new water will not be replenished quite according to the normal schedule in the Horsetooth and Carter Lake reservoirs, that water is, in essence, paying down a future withdrawal that won’t happen for a year or more…

    “The water coming out of your faucet now, if it’s this project’s water, was probably snow that fell in maybe 2018,” Stahla explained. “It ran off in spring of ’18 and filled up Lake Granby, and then around the end of 2018 into 2019, it would’ve been used to fill up reservoirs on the front range. That would’ve happened over winter of 2018-2019, and then it would’ve been in reservoirs all of 2019 and probably drawn out now in 2020. This project works on a multi-year cycle of gathering runoff, feeding reservoirs and serving the public.”

    The water is still in Lake Granby, but temporarily won’t be pumped up to Shadow Mountain because of concerns that the fire will impact the power supply to the pump at Lake Granby…

    However, that water is only a portion — a very sizable portion, close to half — of the water that is used by Greeley customers, according to city of Greeley water and sewer director Sean Chambers.

    And, truly incredibly, the other major sources of water, four in total, from which the city draws its 20,000 to 25,000 acre feet-per-year supply are also being impacted by these unfathomable wildfires.

    “We have water from four different river basins,” Chambers said. “We get water from the Poudre River Basin, that’s where the year-round treatment plan by Bellevue, northwest of For Collins is. The top of the Poudre is where the fire started. You go north and cross into Laramie River Basin — the Laramie flows north into Wyoming but we have a system of ditches and tunnels that brings water back into the Poudre. The fires burned a bit of the headwaters of the Laramie. We also get water from the Big Thompson Basin, and the Cameron Peak Fire spread southeast over the last ten days, blown over the ridge line and the divide into the Big Thompson Basin. And then the last basin is the Colorado River Basin, which is where the East Troublesome Fire comes from.”

    Chambers, marveling, called this phenomenon the first time “in recorded history” that this has happened, where all four major water sources are affected by fires at the same time…

    Further, while snow melt over burned land could well impact other water sources as well, there are plans in place, Chambers said.

    “When the High Park Fire happened, that fire had these post-precipitation water-quality events in the river, where Fort Collins and Greeley and others, who take water directly off the Poudre River for municipal treatment, we turned off our intakes and let the bad water go by, let the water quality improve. We can do that because of the beautiful supplemental supply in the Colorado Big Thompson project.”

    The flexibility requires planning, though, including, Chambers said, installing source-site filtration systems where snow runoff on its way the river systems are filtered prior to entering the water supply…

    In the immediate moment, though, the water supply even well into next year is in good shape, regardless of the fires Stahla said.

    “Not even just into early next year,” Stahla said. “Reservoirs are there for that kind of demand management that you can have some stocked away close to meet your needs. As of now, there’s no operational changes because of the wildfires to the water supply on the Northern Front Range. Those reservoirs will be refilled by next spring.”

    #FortCollins issues water restrictions to protect supply — 9News.com

    Mammatus clouds, associated with strong convection, grace a sunset over Fort Collins, Colorado, home of the NOAA Cooperative Institute for Research in the Atmosphere at Colorado State University. Photo credit: Steve Miller/CIRA

    From 9News.com (Janet Oravetz):

    Water restrictions will be implemented for residents of Fort Collins following extreme drought conditions and wildfires which have the area facing a potential water shortage, the city announced on its website.

    The water use restrictions will take effect Oct. 1 and will remain in effect until the order is lifted by the city manager…

    Ongoing drought conditions, the Cameron Peak Fire burning near Walden and an infrastructure repair project known as Horsetooth Outlet Project (HOP) have the city facing a projected water shortage unless action is taken, the city said.

    Typically, utilities receives about 50% of its water from Colorado-Big Thompson shares via Horsetooth Reservoir and 50% from the Cache la Poudre River. During HOP, utilities will have limited access to water supplies in Horsetooth and will rely more heavily on the Poudre River.

    If conditions during HOP – like continued drought or poor water quality due to the Cameron Peak Fire – prevent or limit the ability to deliver water from the Poudre River, a temporary backup pump system will convey water from a different Horsetooth Reservoir outlet to the Utilities Water Treatment Facility.

    The capacity of this backup system is expected to supply only average utilities winter water demands, which does not include irrigation or other seasonal outdoor uses.

    Lawn watering will not be allowed beginning Oct. 1. Trees, gardens for food production and other landscapes may be watered by hand or drip systems only. There are also restrictions on vehicle washing, power washing and street sweeping, among other things.

    Horsetooth Reservoir’s water level dropping rapidly but boating will continue — The Fort Collins Coloradoan

    Horsetooth Reservoir looking west from Soldier Dam. Photo credit: Norther Water.

    From The Fort Collins Coloradoan (Miles Blumhardt):

    Horsetooth Reservoir’s water level dropping around 4 feet per week in July and August certainly hasn’t go unnoticed by concerned boaters.

    The water level of the popular reservoir dropped from 97% full at the beginning of the season to around 60% last week. Despite the drop, all boat ramps will be usable through Labor Day weekend, but not so much come mid-September.

    Jeff Stahla, Northern Water spokesman, said an unusually dry and hot summer created an increase water demand by agriculture and municipalities, resulting in the sharp drop in water level. He said the rate of that drop is expected to lessen the rest of summer and early fall as water demand lessens…

    Mark Caughlan, Horsetooth Reservoir district manager, said he expects the South Bay boat ramp to remain usable throughout the fall but that by mid-September the Satanka and Inlet Bay ramps will be closed due to the low water level.

    Stahla said by late this week the reservoir’s water level will be at the lowest level since 2012, which was a historically dry year.

    He said lowering the water level will also help divers to safely replace a valve at Soldier Canyon Dam, which he said is routine maintenance and does not involve major construction. He said other work to the reservoir will be done at the same time by other entities…

    Stahla said Horsetooth Reservoir, which is the largest reservoir in the Colorado-Big Thompson Project East Slope distribution system, is expected to fill back up next year. He said CBT’s water storage in mountain reservoirs above Horsetooth Reservoir is in good shape with storage at more than 90% in some reservoirs.

    #Boulder reservoir to be drained starting sept. 1 for required maintenance work

    Here’s the release from the City of Boulder (Jeff Stahla, Denise White, Samantha Glavin):

    Beginning Sept. 1, 2020, until March 2021, access to Boulder Reservoir will be limited while the reservoir is drained to allow Northern Water, in coordination with the City of Boulder, to perform necessary maintenance on the reservoir and its dams.

    Boulder Reservoir. Photo credit: The City of Boulder

    This work will ensure visitor safety and effective water delivery to municipal and agricultural water users. Reservoir water levels will be significantly lower than normal during this time. This is routine, required maintenance work that will take place every 5-10 years.

    The reservoir basin will be closed to all water-based activities, including boating, watercraft, fishing, swimming, wading and other on-water recreation once the reservoir drawdown begins Sept. 1. Passive recreation opportunities (e.g., walking, cycling and running) will still be available during this time. The main trail along on the North Shore will remain open, but access to the shoreline will be restricted. Trails in the vicinity of the north and south dams may be periodically impacted during periods of construction in those areas. A map of affected areas is available on the project website at bouldercolorado.gov/water/boulder-reservoir-maintenance#.

    Performing the maintenance work this year when some recreation activities such as swimming and special events are already restricted due to COVID-19 will ensure that additional impacts will be avoided, and recreation can return to full service once the pandemic subsides. However, the city recognizes that this limitation on Boulder Reservoir use may be disappointing to impacted recreationists. The city is providing reservoir permit and pass holders with a partial refund or credit on their purchase, available through Aug. 23. Current permit and pass holders have been contacted directly with information on how to access this offer.

    Additionally, Boulder Reservoir has received approval to remain open on Friday, Aug. 7, which is designated as an unpaid city closure day to address financial challenges related to the coronavirus pandemic, and offer extended hours of operation from 7-9 p.m. on Aug. 10-16. The city is able to offer these additional hours due to cost savings as a result of the draining project’s impact in shortening the fall recreation season.

    The reservoir will be drained to remove sediment from the area around the reservoir outlet, which naturally builds up over time. Maintenance will also occur on dam outlet structures, and the on the land between the north and south dams known as Fisherman’s Point. Construction equipment access and activity will be in the vicinity of the north dam and Fisherman’s Point. 

    Northern Water is coordinating with Colorado Parks and Wildlife and city staff to mitigate environmental impacts of the project. The reservoir will be drained outside of nesting season, limiting effects on nesting and migrating species during the most critical point in their life cycle. The reservoir will be refilled prior to spring migration and nesting seasons. While there are currently no plans to relocate the fish in the reservoir as the water level is expected to support the fish, Northern Water will monitor their environment daily. If conditions appear problematic, fish relocation may be arranged. 

    The Boulder Reservoir is a key part of the city’s drinking water supply and provides water to other municipal and agricultural users. Water is delivered to the reservoir and its water treatment plant via the Southern Water Supply Project, completed in 2020, and the Boulder Feeder Canal. The City of Boulder owns Boulder Reservoir, but operations and maintenance related to water storage and dam safety are primarily managed by the Northern Colorado Water Conservancy District (Northern Water). 

    Additional information is available on the project webpage at https://bouldercolorado.gov/water/boulder-reservoir-maintenance#. General project questions can be directed to Water Resources Manager Kim Hutton at 303-441-3115 or huttonk@bouldercolorado.gov. For questions regarding recreation impacts, contact Boulder Reservoir Facilities Supervisor Stacy Cole at 303-441-3469 or coles@bouldercolorado.gov.

    Say hello to @Northern_Water’s new website

    Screen shot of the new Northern Water website. Click the image to go to the website.

    Click here to to the new website. Easy to navigate and find data:

    Northern Water is proud to announce the launch of a new organizational website. The website offers a user-friendly experience with improved navigation and functionality.

    With a modern, sleek design, the new website uses enhanced functionality, features and content to tell the story of Northern Water and its commitment to delivering water to more than 1 million people and 615,000 acres of irrigated farmland in Northeastern Colorado while protecting water quality on both sides of the Continental Divide.

    Key features of the new website include:

  • Improved navigation that makes content easy to find;
  • A search engine that captures targeted results for visitors seeking specific information;
  • Mobile responsive design that allows website access from any device;
  • A new data portal that provides real-time data, water quality data and more;
  • A new customized water accounting portal that empowers water users to manage their portfolio, order and transfer water, and view important documents; and
  • A news blog to inform the public about Northern Water’s projects, programs and activities. New weekly content will ensure the public is kept up to date on the latest happenings.
  • The new website has been more than a year in the making with a primary goal of creating a user-friendly platform accessible from any device. Specifically, the goal was to make it easier for visitors to learn about the organization and its rich history, receive project updates and discover ways to more efficiently use water in their landscapes and daily lives.

    #Colorado-Big Thompson operations update

    Olympus Dam photo via the US Bureau of Reclamation.

    From email from Reclamation (Elizabeth Jones):

    Olympus Dam near Estes Park, Colorado impounds Lake Estes. The lake is the afterbay for Estes Powerplant, a hydroelectric powerplant that can produce up to 45 MW each hour. Colorado-Big Thompson Project water from the west slope fuels the Estes Powerplant. Project water discharged from Estes Powerplant is diverted from Lake Estes, routed to additional hydroelectric powerplants on the Front Range and is then stored in Carter Lake or Horsetooth Reservoir. Project water is rarely released from Olympus Dam into the Big Thompson River.

    This is the season for snow-melt runoff into Lake Estes. In the past 10 days, natural inflow into Lake Estes has increased from a low of about 250 cubic feet per second (cfs) to a peak flow of about 1,020 cfs. Currently, natural inflow is decreasing (around 700 cfs); however, warmer or wetter days could result in natural inflow increasing again and the recent peak inflow could be surpassed.

    Olympus Dam is not an authorized flood control structure. As such, the natural snow-melt or precipitation runoff that flows into Lake Estes is released from Olymus Dam into the Big Thompson River. Under normal operations, Olympus Dam does provide the benefit of shaving off the peak inflow. One way it does so can be explained using recent operations. During two days this week when peak inflow into Lake Estes was about 1,000 cfs, maximum release from the dam was 880 cfs. This is because outflows are generally the day’s average. Outflow does not follow the within-day variation, which ranged from 714 cfs to 1,020 cfs within a 24-hour period. Releases from Olympus Dam in the near term will be driven by whatever Nature provides from the headwaters of the Big Thompson watershed.

    As the snow-melt runoff season progresses, Reclamation will provide information to the public regarding expected flows released from Olympus Dam.

    #Colorado-Big Thompson Project operations update #ColoradoRiver #COriver #aridification

    From email from Reclamation (Brittany Jones):

    The Bureau of Reclamation will increase diversion of Colorado River water to Horsetooth Reservoir at midnight tonight. The change will require a decrease in the Big Thompson River diverted for power generation at Olympus Dam.

    Reclamation is currently releasing 125 cfs to the Big Thompson River from Olympus Dam. The flow will increase to 265 cfs beginning tonight. Our current forecast indicates that runoff into Lake Estes will substantially increase over the next week. It is possible the Olympus Dam required release to the Big Thompson River will exceed 600 cfs.

    Aerial view of Lake Estes and Olympus Dam looking west. Photo credit Northern Water.

    @Northern_Water: Regional Pool Allocation Set at 15,000 Acre-feet

    Here’s the release from Northern Water:

    The Northern Water Board of Directors allocated 15,000 acre-feet of Regional Pool Program (RPP) water during its May 14, 2020, Board meeting. RPP water is available for lease by eligible Northern Colorado water users, with sealed bids due May 28, 2020. Bid prices per-acre-foot must be greater than or equal to $27.40, a floor price the Board selected based on the 2020 agricultural assessment rate.

    Due to the COVID-19 pandemic, interim procedures have been instituted for the May 2020 RPP allocation. The interim procedure and additional Regional Pool information are available at http://northernwater.org/regionalpool.

    The following forms are required to submit a bid:

  • Pre-Approval Form – To confirm eligibility, interested bidders must email or mail the Pre-Approval Form to Northern Water. In person delivery will not be accepted in 2020. A new Pre-Approval Form is required each year.
  • Carrier Consent Form – If the RPP water will be delivered by a carrier, such as a ditch or reservoir company, bidders and their carriers must complete the Carrier Consent Form or provide a signed agreement stating that the carrier will deliver the RPP water to the bidder. This form must also be emailed or mailed to Northern Water; in person delivery will not be accepted.
  • Bid Form – Sealed bids will be accepted at Northern Water’s headquarters through a “self-serve” process. Bidders will sign in at a kiosk in the lobby and print a bid label for their sealed bid envelope. The label will identify the bidder name, date and time stamp, and bid number. Secure the label to the bid envelope and place in the drop box. Sealed bids may also be mailed to Northern Water, but must be received before the deadline.
  • Sealed bids are due by 2 p.m. May 28 at Northern Water’s headquarters, 220 Water Ave., Berthoud, CO 80513. As described above, sealed bids can be mailed or hand delivered; email and fax bid forms will not be accepted. RPP leases will be awarded based on highest bids per acre-foot. Sealed bids will be opened during a 9 a.m., June 1 Zoom video conference. The link to the Zoom video conference will be available at http://northernwater.org/RegionalPool.

    Many staff are working remotely due to the COVID-19 pandemic and are not available to answer questions in person. Questions regarding the Regional Pool Program and bid submittal can be emailed to regionalpool@northernwater.org or by calling Sarah Smith at 970-622-2295 or Water Scheduling at 970-292-2500.

    Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

    @Northern_Water increases 2020 C-BT quota to 70 percent #ColoradoRiver #COriver #aridification

    Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

    Here’s the release from the Northern Colorado Water Conservancy District:

    Above average regional water storage coupled with above average snowpack prompted the Northern Water Board of Directors to increase its 2020 quota allocation for the Colorado-Big Thompson Project to 70 percent.

    The Board unanimously approved the allocation at its meeting Thursday, April 9, 2020, which was held via video to comply with state stay-at-home orders as part of the global coronavirus (COVID-19) outbreak.

    Luke Shawcross, manager of the Water Resources Department at Northern Water, outlined snowpack and forecasted streamflows and discussed the available water supplies in regional reservoirs.

    When setting the quota the Board considers current regional reservoir storage levels, forecasted snowpack runoff, availability of water within the C-BT system and public input.

    The Board has been setting C-BT quota since 1957 and 70 percent is the most common quota declared. It was also the quota set for the 2019 water delivery season.

    The quota increases available C-BT Project water supplies by 62,000 acre-feet from the initial 50 percent quota made available in November. Water from the C-BT Project supplements other sources for 33 cities and towns, 120 agricultural irrigation companies, various industries and other water users within Northern Water’s 1.6 million-acre service area. According to recent census figures, approximately 1 million residents now live inside Northern Water’s boundaries. To learn more about Northern Water and the C-BT quota, visit http://www.northernwater.org.

    Pearl Harbor altered Colorado’s path after 1941, and Covid-19 will also — The Mountain Town News #coronavirus #COVID19

    Boring of the Eisenhower Tunnel began in 1968 and was completed in 1973 at a cost of $117 million. The Colorado Department of Transportation estimated the cost early in the 21st century would have been $1 billion to $1.1 billion. Photo/ C-DOT.

    From The Mountain Town News (Allen Best):

    This pandemic has started feeling like something more than an extended snow day or having the mumps when you’re a child. Perhaps it’s now more like 1941, after Pearl Harbor.

    The potential for a pandemic has been amply reported over the years. People in the early 1940s knew we would inevitably go to war. When abstraction became reality on that December day, so much changed in the context of Colorado.

    In the late 1930s, ski areas were about to blossom. The Union Pacific’s Averell Harriman in 1936 opened Sun Valley in Idaho, and resorts were taking off in New England. Colorado had a few smaller ski areas, including Berthoud and Winter Park, plus town ski areas at Steamboat Springs and Gunnison.

    Others were thinking bigger. In Aspen, a boat-tow had been installed, primitive but effective in transporting people uphill. One of them was Elizabeth Paepcke, the wife of a wealthy Chicago industrialist. She wanted her husband to see Aspen, to see the potential she saw. Others saw a different resort, one on Mount Hayden, in the Castle Creek Valley southwest of Aspen. Colorado legislators gave the venture $650,000, which was backed by a federal fund.

    Closer to Denver, tunnel crews had begun boring an exploratory tunnel under Loveland Pass, with the idea of creating a highway under the Continental Divide. To the west, the state government had used federal New Deal funding to upgrade the horse trail across the Gore Range to a two-lane gravel road. They called it Vail, to honor Charlie Vail, then the boss of the Colorado Highway Department.

    In Washington, D.C., President Franklin Roosevelt had had engineers develop plans for a national system of highways with separated lanes.

    In Colorado, work had begun on Green Mountain Reservoir. The intent was to provide a service to the Western Slope as a result of the giant trans-mountain diversion planned at Grand Lake to benefit farmers in northeastern Colorado.

    And in northeastern Colorado, my father was working on a dryland farm near Fort Morgan and lopping off the tops of sugar beets in that quiet before the distant clouds of war arrived.

    Pearl Harbor changed everything.

    The war brought the 10th Mountain Division to Colorado, to a high valley along the Continental Divide between Leadville and Red Cliff called Eagle Park. The Army named it Camp Hale, and at the height of the training it was among the largest cities in Colorado, with 14,000 people, mostly men.

    After the war, in 1946, Elizabeth Paepcke’s husband, Walter, finally visited Aspen and saw what had so impressed her. But he put a new touch on it, the idea of invigorating the body and challenging the mind, a DNA that lingers to this day. 10th Mountain Division veterans returned in droves to Colorado to convert Aspen from a derelict mining town into an international resort. A resident, for a time, was Pete Seibert, who had grown up in New England dreaming of creating a ski resort. But he wanted his own resort. That dream in 1962 became Vail.

    In time, my father was inducted into the Army, leaving behind the dryland farm where he was reared and its house, which had neither indoor plumbing nor electricity, and took the train to California for basic training, then a posting at the Presidio, near the Golden Gate Bridge in San Francisco. Eventually he was shipped to India at the foot of the Himalaya Mountains.

    The bore under Loveland Pass was completed in 1943, but it revealed too much difficult geology for a highway tunnel. Later, a different alignment was chosen, and that tunneling work resulted in the first of two tunnels in 1973.

    The idea of superhighways that many people want to attribute with singularity to Dwight Eisenhower finally was given a federal sponsorship in 1956. Among the Senate sponsors was Albert Gore, father of the future vice president. But if not for the war, it might have happened sooner.

    First water through the Adams Tunnel. Photo credit Northern Water.

    As for that big New Deal-era water project, the Colorado-Big Thompson, it was finally completed in 1957.

    And my father returned to northeastern Colorado, married the girl he had met at a gathering of young Baptists in the 1930s and took up work as a carpenter. He never flew again, never traveled abroad, but he did have a taste for curry that was never satisfied. He died before the spread of Indian restaurants in Colorado.

    Vail probably would have happened eventually. The mountain itself and the proximity to Denver made it a natural. But World War II put Pete Seibert into Colorado. Aspen would have flourished, but perhaps in a different way. As for Mount Hayden, it came to nothing, in its own way perhaps a casualty of World War II.

    This pandemic is different than World War II, and we have to go back further to see precedent. In 1918, Gunnison quarantined itself and survived with little loss of life, while Silverton, as remote a town as there may be in Colorado, isolated in the icy fastness of the San Juan Mountains, lost 10% of its population.

    In this COVID-19 pandemic, the first case in Colorado was a visitor to Summit County who had recently been in Italy, then Australian visitors to Aspen-Snowmass. But then Eagle County flared, and as of early this week had 22 cases from the Vail area compared to 24 in Denver County, which has a population about 12 times as large. County officials on Thursday said they suspected hundreds, if not thousands, had contracted COVID-19.

    A century ago the influenza spread globally, but by rail instead of by air. The world has shrunk, with consequences both good and bad.

    We will survive this pandemic, but there will be changes. I sincerely doubt we’ll see the significant expansion at DIA that had been announced just a few months ago. That may actually be good.

    Can other good also result? Many of us hope that it will result in greater acceptance of facts, more acceptance of science. Ideology played a powerful role in the sluggish, or worse, acceptance of the virus by powerful people, most notably the president. That same ideology, the same denial, has shrugged off or rejected the power of accumulating greenhouse gases to produce costly changes in our climate.

    I hope we develop a greater sense of a global community. It could easily take us the other way, one exemplified by the run on guns and ammunition. What we see early on, the sniping between President Trump and his counterparts in China, is not encouraging.

    This was first posted by the Colorado Independent.

    The latest @Northern_Water E-Waternews is hot off the presses

    Southern Water Supply Project Map via Northern Water.

    Click here to read the newsletter. Here’s an excerpt:

    Final pipeline pieces get put into place for Southern Water Supply Project II

    The contractors for the Southern Water Supply Project II reached a significant milestone last month with the installation of the final portion of pipeline.

    The final piece was placed along the 20-mile route near Carter Lake in southern Larimer County. The pipeline, funded by the City of Boulder, Left Hand Water District, Longs Peak Water District and the Town of Berthoud, will bring water supplies to those communities year-round.

    While the installation of pipeline is complete, additional work remains. Northern Water technicians are installing and programming equipment for integration into its SCADA system, and testing of the pipeline segments for quality assurance is ongoing. Northern Water anticipates the pipeline will start carrying water to its destination at Boulder Reservoir in April.

    Beyond the pipeline, however, work will continue on another important aspect of construction: reclamation of disturbed ground. The pipeline runs through easements on a variety of public and private properties, and reclamation crews will be working with those entities to ensure lands are reclaimed to their owners’ satisfaction.

    Garney Construction was the lead contractor for the $44 million project.

    A video of the final pipeline is available here.

    To learn more, go to http://swsp2.org.

    Rising cost of water rights in Loveland squeezes local developers — the Loveland Reporter-Herald

    Lake Loveland

    From The Loveland Reporter-Herald (Carina Julig):

    Water in Loveland comes from the Colorado-Big Thompson Project, which diverts water over the Continental Divide to the Front Range. Over the past several years, units of water from the project have soared in price as Northern Colorado’s population has grown and development increases.

    From 2010 to 2019, the average price of C-BT units rose from $7,000 to $55,000. The amount of water in a C-BT unit is set yearly by the Northern Colorado Water Conservancy District — Northern Water — and fluctuates based on the amount of snowpack and forecast streamflows for that year. In 2019, it was set at 70 percent of an acre-foot…

    The city of Loveland requires developers to bring their own water rights to a project or to purchase water from the city. The city’s cash-in-lieu price for water rights is pegged to the market value and has steadily risen alongside it.

    At the Loveland Utilities Commission meeting Dec. 18, the city approved raising the cash-in-lieu price of C-BT units to $47,640. It last raised the price in July to $39,330.

    The city asks developers to pay their own way so that they don’t cut into the city’s water resources for the future, said Joe Bernosky, the director of Loveland Water and Power.

    “What we’re doing is we’re to trying to make them pay their own way so the existing citizens don’t have to pay or we don’t kick the can down the road,” Bernosky said. “And that’s not a good way to do business when you’re a utility.”

    Cash-in-lieu money the city receives from developers all goes toward firming up the city’s water portfolio, said Larry Howard, a senior civil engineer in the Water and Power utility.

    There’s no profit incentive to increasing the cash-in-lieu price, Howard stressed. The city is just reacting to market conditions and doesn’t have a lot of options.

    The rising cost of water is making it harder to build more affordable housing in Loveland, something the city badly needs. Jeff Feneis, director of the Loveland Housing Authority, said water rights are one of the organization’s biggest challenges.

    In order to help mitigate the increasing cost of water, the city recently recalculated the water rights necessary per building unit. The change, which went into effect this September, applies only to residential buildings.

    Due to more efficient building practices such as more efficient appliances, new houses require less water than older ones do. In light of this, the city reduced the required amount of water for a single-family dwelling from about one-quarter of an acre-foot to about one-tenth.

    @Northern_Water district’s fall symposium recap

    From The Loveland Reporter-Herald (Carina Julig):

    More than 300 people attended the Northern Colorado Water Conservancy District’s fall symposium [November 20, 2019] at the Embassy Suites in Loveland to discuss the region’s water future.

    Several city officials from Loveland attended, including City Council member Steve Olson…

    Map of the Colorado-Big Thompson Project via Northern Water

    The majority of Northern Colorado’s water comes from the Colorado River, over the Continental Divide. Water is diverted through Rocky Mountains by the Colorado-Big Thompson Project, and stored in reservoirs.

    As water flows become more unpredictable, with droughts some years and heavy snowfalls in other, having the infrastructure to store larger quantities of water is becoming increasingly important…

    The city has rights to water from the Colorado-Big Thompson Project and the Windy Gap Project as well as rights to water from the Eastern Slope.

    Green Ridge Glade Reservoir

    Most of Loveland’s water comes from the Green Ridge Glade Reservoir, which stores water from the Colorado-Big Thompson Project.

    Water & Power is currently updating its raw water master plan, which details how the city will provide water to customers for several decades, Bernosky said.

    As Loveland’s population has grown, water usage has remained relatively flat, due to more efficient home and building construction. The city has been on a 20-year trend of reducing its gallons per capita per day, said Larry Howard, a senior civil engineer in the city of Loveland’s water resources division.

    Map from Northern Water via the Fort Collins Coloradan.

    If the Chimney Hollow Reservoir project goes through, Loveland will have adequate water supply through 2060, Howard said. The city has rights to 10.5% of the water in the proposed reservoir, which is currently being held up by a lawsuit.

    Brian Werner 38 Years With Northern Water, A Celebration at the Source and Heart of Western Water Education! — Greg Hobbs

    Eric Wilkinson, left, and Brian Werner, on the job. Photo: Brent Gardner-Smith/Aspen Journalism

    Brian Werner 38 Years With Northern Water,
    A Celebration at the Source and Heart
    of Western Water Education!

    When we look to the future
    it’s no more fortuitous

    than finding each other
    on the journey of the great

    surveys of our lives.

    This slideshow requires JavaScript.

    @Northern_Water Symposium, November 20, 2019

    Map of the Colorado-Big Thompson Project via Northern Water

    Click here for all the inside skinny:

    Video: The Colorado-Big Thompson Project — @Northern_Water

    First water through the Adams Tunnel. Photo credit Northern Water.

    Reservoir agreement helps trout by borrowing endangered fish water — The Grand Junction Daily Sentinel

    From The Grand Junction Daily Sentinel (Dennis Webb):

    Some rejiggering of reservoir operations in the upper Colorado River watershed is taking the heat off trout in Grand County through the early release of water that had been set aside for endangered fish in Mesa County.

    The approach is being made possible by storing water elsewhere so it can be released for the endangered fish when they need it later.

    Under the agreement involving the U.S. Fish and Wildlife Service, the U.S. Bureau of Reclamation and Colorado River District, an additional 35 cubic feet per second of water started being released last week from Lake Granby, also known as Granby Reservoir, in the Colorado River headwaters. That nearly doubled Colorado River flows immediately downstream.

    The increased flows help reduce daytime temperatures in the river, which had begun topping 60 degrees and threatening the health of trout. The releases involve water normally stored in Granby for use in boosting flows in the river near Grand Junction for endangered fish such as the humpback chub and razorback sucker.

    The endangered fish still will get water under the deal, however. In exchange for the additional water coming out of Granby, the river district is withholding 35 cfs of water from Wolford Mountain Reservoir, which sits above Kremmling on Muddy Creek, a Colorado River tributary. That’s below the problem stretch of the Colorado River, thanks to inflows to the river coming from Muddy Creek and other tributaries, so the Wolford water that’s being withheld doesn’t hold the importance to the trout that the released Granby water does.

    “There’s plenty of water in the river except for in that stretch below Granby,” said Jim Pokrandt, a river district spokesman.

    Pokrandt said the Colorado River is currently a “free river” right now in Colorado. There are no calls on it to meet the needs of senior water rights holders when flows are more limited. But the upper stretch in Grand County in the Hot Sulphur Springs area is depleted due to transmountain diversions to the Front Range.

    Withholding the Wolford water means it will be available for the endangered fish during lower-flow periods on the Colorado River in Mesa County, in lieu of the water that is being released from Granby.

    Firestone: Fred Sekich Farm to be auctioned off August 28, 2019, split into smaller parcels, and the water rights sold separately

    Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

    From The Denver Post (Mark Samuelson):

    …the game of selling farm property has changed — particularly the auction game — as information technology makes offerings much more attractive for sellers and widens the opportunities for buyers and investors.

    “Today’s farm auction is structured to create better potential for the buyer,” says Scott Shuman, partner in Hall and Hall, brokers and auctioneers who have been selling western real estate since the 1940s. In 2010, Hall and Hall made a move into auctioning — and have been pioneers in structuring auctions to get better returns for farm sellers.

    When the Fred Sekich Farm, east of I-25, north of Firestone, is auctioned at The Ranch/Larimer County Event Complex on Aug. 28, its 546 acres will be cut into 58 offerings — one as small as 4 acres, one as large as 141 acres, with the parceled surface water rights (176 Colorado-Big Thompson Units and 18.75 ditch shares) auctioned separately.

    Those water rights may be as valuable as the land, maybe more.

    “Water is gold,” says Rick Sekich, who along with his mom and two brothers are the sellers…

    Grandpa Nick Sekich would have had little idea the value that surface water would hold as Colorado grows.

    “It’s really gone up,” says Sherri Rasmussen, contract manager for Northern Water, administering the CB-T’s vast distribution all the way east to Sedgwick County. When the project began in the 1930s, an acre-foot sold for $1.50; by 2013, it was 10,000 times that…

    All of this could stay agricultural — selling to an owner with holdings nearby. But either way, Shuman adds, sellers make out better in these auction sales, where buyers have an opportunity to customize a purchase…

    Hall and Hall, with 15 offices across the West, is in Eaton, Colo., 800-829-8747. The complete sale catalog is at HallandHall.com.

    The latest “E-WaterNews” is hot off the presses from @Northern_Water:

    A “rooster tail” is formed by the water descending the Granby Dam spillway on July 19. Photo credit: Northern Water

    Click here to read the newsletter. Here’s an excerpt:

    Cool spring, late storms fill C-BT Project

    A cool and wet spring in Northern Colorado coupled by unusual late snowstorms combined to top off the Colorado-Big Thompson Project in 2019.

    At Lake Granby, water reached the spillway over the weekend of July 13-14. In the days before that, managers had been releasing additional water into the Colorado River to make room for incoming snowmelt.

    Because of a storm that dumped snow on the headwaters of the Colorado River on June 21, the inflow into Lake Granby climbed significantly. While earlier models had indicated Lake Granby wouldn’t fill, that storm boosted streamflows considerably.

    Northern Water was not the only organization surprised by the late snowmelt and heavy late-season storms. Denver Water, which manages Lake Dillon and collects water at the headwaters of the Fraser River, reported the snowpack that feeds its system was also far above normal this year.

    Lower South Platte Water Conservancy District board meeting recap

    Screenshot of the Colorado-Big Thompson Project boundaries via Northern Water’s interactive mapping tool , June 5, 2019.

    From The Sterling Journal-Advocate (Jeff Rice):

    Brad Wind, general manager of the Northern Colorado Water Conservancy District based in Berthoud, and Jim Hall, Northern Water’s senior water resources engineer, briefed the LSPWCD’s board of directors on Northern’s efforts to keep Colorado-Big Thompson water from leaving the Northern District…

    Wind told the Lower board that Northern is working to enforce Article 19 of the 1938 contract between Northern Water and the federal government, known as the Project Repayment Contract. That article, one of 27 contained in the contract, specifies that all seepage and return flows from the use of Colorado-Big Thompson project water are reserved to Northern Water and are not to be taken outside the district’s boundaries.

    On May 9, Northern adopted a resolution saying it would “take appropriate actions to enforce Article 19 consistent its interpretation of Article 19.”

    Wind said the heavy lifting in that effort will be tracking how C-BT water, and resulting seepage and return flow, are used. He used the phrase “colors of water,” which is a concept that holds that, through close monitoring and accounting, mixed waters from various sources actually can be tracked through multiple uses. For instance, water that is native to the South Platte Basin can be accounted differently from C-BT water, which is diverted from the Colorado River into Grand Lake and piped through the Adams Tunnel to Estes Park and held in Horsetooth Reservoir and Carter Lake for distribution to C-BT members.

    Return flows are water that has been diverted from the river, used to irrigate crops or for municipal use, and either seeps back to the river through the ground or is discharged after treatment. Much of the river’s flow in the lower reaches in late summer and through the winter is from return flows from upstream use. Return flows are crucial to irrigators in Weld, Morgan, Washington, Logan and Sedgwick counties.

    “To protect return flows, we have to know what they are,” Wind said. “We have to be able to quantify what return flows are coming from C-BT use and what’s from native water. It’s complicated.”

    Hall told the Lower board that there is the danger that “change of use” cases going through Colorado water courts could result in return flows from C-BT water being shipped out of the Northern district in violation of Article 19.

    “We’re starting to see change cases on irrigation ditches moving water outside the district boundaries,” Hall said. “That’s why it’s important to track this stuff. It’s easier to track municipal water because we can look at their (wastewater treatment facility) discharges, but it’s harder to prove agricultural return flows.”

    Hall said return flows from native water are not subject to Article 19, only C-BT return flows.

    Wind said Northern will be watching closely all change of use cases that go through Colorado’s water courts and will continue monitoring water usage in the district to make sure C-BT water doesn’t leave the district.

    #Snowpack/#Runoff news: @Northern_Water declares a 70% quota for the 2019 season #ColoradoRiver #COriver

    Lake Granby spill June 2011 via USBR. Granby Dam was retrofitted with a hydroelectric component and began producing electricity earlier this year as water is released in the Colorado River.

    From The Loveland Reporter-Herald (Sam Lounsberry):

    Unit owners of the Colorado-Big Thompson project, which delivers Colorado River water from the wet Western Slope to the dryer Front Range, will get 70% of their quota this year, according to a Northern Water news release.

    The 70% allocation means that a farmer who owns 10 acre-feet of Colorado-Big Thompson water will get seven in a year, with the remaining three kept in storage for use in dry years…

    In wet years like this one, Northern sometimes downsizes the quota of Colorado-Big Thompson water distributed, since native streams can be full enough to provide farmers late-season growing supply, which provides Northern a storage opportunity for use in dry years.

    But the move to boost the Colorado-Big Thompson quota from 50% — the level normally set at the start of Northern’s water year in November just to get users through the winter so snowfall can inform spring allocation rates — ensures farmers will have a more flexible late growing season.

    The quota increases available Colorado-Big Thompson water supplies by 62,000 acre-feet from the initial 50% quota made available in November…

    The snow-water equivalent mark for the Upper Colorado Basin is 120% of the normal median as of Thursday, according to the U.S. Bureau of Reclamation, with snowpack levels in other river basins across the southwest at even higher marks. But KUNC and The Aspen Times reported this year that despite the good snowfall this winter, officials predict spring runoff won’t be enough to replenish reservoirs across the southwest, because years of drought have left dry soil that sucks up extra drops.

    “Modeled soil moisture conditions as of November 15th were below average over most of the Upper Colorado River Basin and Great Basin,” the Colorado Basin River Forecast Center stated in its April 1 report. “In the Upper Colorado River Mainstem River Basin, soil moisture conditions were below average in headwater basins along the Continental Divide, and closer to average downstream.”

    Water from the Colorado-Big Thompson project supplements other sources for 33 cities and towns, 120 agricultural irrigation companies, various industries and other water users within Northern Water’s 1.6 million-acre service area, across parts of eight counties, the Northern release said.

    Westwide SNOTEL basin-filled map April 11, 2019 via the NRCS.

    Loveland: @Northern_Water Spring Water Users Meeting Tuesday, April 9, 2019

    Click here to read the agenda.

    Map of the Colorado-Big Thompson Project via Northern Water

    Colorado-Big Thompson water units increasingly packaged for lease to N. #Colorado farmers #ColoradoRiver #COriver

    Boulder. By Gtj82 at English Wikipedia – Transferred from en.wikipedia to Commons by Patriot8790., Public Domain, https://commons.wikimedia.org/w/index.php?curid=11297782

    From The Longmont Times-Call (Sam Lounsberry):

    As ownership of Colorado-Big Thompson water units shifts from agricultural interests to municipal control, farmers in the Longmont and Boulder areas are becoming dependent on the cities’ water rental programs.

    And with more municipal control of the Colorado-Big Thompson system, the market has changed in focus from acquisitions to leasing programs for farmers.

    Colorado-Big Thompson units can be bought, sold and transferred between water users anywhere within its manager Northern Water’s eight-county region without new uses having to be approved by a state water court, even when a deal involves users in different native stream basins. For that reason, the units have been attractive to those looking to buy in the water market — especially real estate developers needing to dedicate raw water to a municipality or water district to annex in new structures for utility service.

    Farmers own less, but still get half

    When the Colorado-Big Thompson project made its first deliveries in 1957, more than 85 percent of its water was owned by agricultural users.

    In 2018, though, municipal and industrial ownership of the 310,000 Colorado-Big Thompson water units…crept to 70 percent, leaving just 30 percent owned by agricultural users.

    But more than half of the system’s water still has been delivered to farmers in recent years, according to Northern Water data.

    That discrepancy reflects how much Colorado-Big Thompson water — originally intended to be a supplemental supply late in the growing season — farmers are renting from cities such as Boulder and Longmont.

    ‘Nearly out of range’

    Boulder last year leased 7,690 acre-feet of water, including 6,950 acre-feet of Colorado-Big Thompson water, and has leased an average of 3,410 acre-feet per year since 2000; Longmont last year leased 612 acre-feet of Colorado-Big Thompson water, along with some city shares of supply ditches that deliver water from native sources such as the St. Vrain River and Left Hand Creek, figures provided by the cities show.

    Longmont revenues generated by its water rental program over the last four years total nearly $3.9 million; Boulder has generated $861,850. The reason for the discrepancy in revenue despite Boulder renting more Colorado-Big Thompson water than Longmont is Longmont rents more of its native water, and its rates for much of its Colorado-Big Thompson water are higher than Boulder’s.

    But the rental market for water also is sliding out of reach for local farmers as outright purchases of Colorado-Big Thompson water have skyrocketed in price — units were sold for $36,000 apiece in an October auction. The water issue has been compounded by a weak commodity market for Front Range crops…

    Northern Water in years wet enough to lease excess Colorado-Big Thompson water does so through a bidding system known as its regional pool, and how those bids shake out in the spring influences the overall rental market for water each year.

    The minimum successful bid on an acre-foot of water in the spring 2010 regional pool was $22, but last year it was $132, Northern Water spokesman Brian Werner said, a six-fold increase over the decade.

    No longer a ‘go-to’ supply

    Developers aiming to annex housing into municipalities or water districts that don’t accept cash in lieu of dedicating new raw water units might be forced to look into acquiring shares of ditch companies delivering water from streams native to a city’s or district’s service area.

    “We have 10 percent of that ag (Colorado-Big Thompson) supply yet to be transferred” to municipal or industrial control, Werner said, predicting about 20 percent of the system will likely stay under agricultural ownership for the foreseeable future.

    “It’s slowed down. About 1 percent a year” is being transferred from ag to municipal and industrial control, Werner said. “Inside the next decade or so, (that system) goes off the table as a go-to water supply.”

    Storage may preserve agriculture

    With more interest in water markets individualized to native stream basins — as opposed to the trans-basin Colorado-Big Thompson market — applications to state water courts to change ownerships and uses of those native basin shares could pick up, as developers continue trying to satisfy their obligations to give new water to Northern Colorado’s growing municipalities.

    Windsor is looking at buying into the Windy Gap Firming Project

    Windsor Lake/Mummy Range

    From The Greeley Tribune (Sara Knuth):

    But as the [town board] looks at other plans to add water, it could introduce higher rate increases, higher fees for developers — or a combination of both. It just depends on the projects Windsor participates in.

    As the town grows, it’s looking at ways to prepare for an increase in water use. Among the recommendations Windsor Water Resource Manager John Thornhill presented to the board is to look at joining Windy Gap Firming Project and maintain participation the Northern Integrated Supply Project — both massive water supply projects managed by the Northern Colorado Water Conservancy District.

    Windsor is one of 15 northern Colorado communities already planning participating in NISP, which is also managed by Northern Water.

    The project, which would also impact Evans, would provide 40,000 acre-feet of raw water to all of the participants — enough for 80,000 families. Of that, Windsor would get 3,300 acre-feet of water, 8.25 percent of the total project.

    Still, town officials project that Windsor will need to supply 15,803 acre-feet of water in the future. That leaves the town with an 8,731 acre-foot gap in the total amount of water the town is currently has plans for — including NISP — and what officials know they will need in the future.

    In addition to participating in the Northern Water projects, Thornhill recommended budgeting money for water conservation, as well as acquiring new water from other providers in the region, such as the North Weld County Water District.

    As it stands now, Windsor’s treatable water supply comes from the Colorado-Big Thompson Project, a Northern Water project that delivers more than 200,000 acre feet of water each year to 960,000 people in the eight counties it serves.

    @USBR revises release forecasts for Olympus and Ruedi dams

    Map of the Colorado-Big Thompson Project via Northern Water

    From email from Reclamation (James Bishop):

    Due to revised demands, releases from Olympus Dam to the Big Thompson River are scheduled to rise from 83 to 101 cubic feet per second (cfs) tonight at midnight (cusp between Thursday and Friday), 21 September. Earlier this week I announced releases from Olympus Dam were planned to rise to 225 cfs and that figure has since changed significantly.

    At this point in our forecast, we do not anticipate releases to the Big Thompson River rising above 150 cfs as we use the river to deliver C-BT Project water. On that subject, use of the Big Thompson to make project water deliveries is slated to run through October 12, and those deliveries vary frequently. I will of course continue to provide updates while keeping in mind the old adage: “Plans are disposable. Planning is indispensable.”

    A map of the Fry-Ark system. Aspen, and Hunter Creek, are shown in the lower left. Fryingpan-Arkansas Project western and upper eastern slope facilities.

    From email from Reclamation (James Bishop):

    Yesterday, I messaged you that we at Reclamation no longer planned to increase releases to 400 cubic feet per second (cfs) from Ruedi Dam to the Fryingpan River but would instead be maintaining releases at 355 cfs. That change holds, but I wanted to further explain this.

    Due to the persistence of very low river flow conditions in the Colorado River, the U.S. Fish and Wildlife Service, in coordination with Reclamation engineers and other Program partners, has decided to reduce the rate of release of Endangered Fish Recovery Program water stored in Ruedi Reservoir to allow these releases to be extended further into October. The reduced rate of release will enable a longer duration of “fish water” to be delivered to the 15-Mile Reach over the upcoming weeks, optimizing its benefits to the endangered fish.

    #Colorado-Big Thompson Project operations update: @USBR expects releases to the Big Thompson River to increase significantly

    Olympus Dam releases June 2011.

    Here’s the release from Reclamation (James Bishop):

    The Bureau of Reclamation is forecasting a notable increase in releases from Olympus Dam to the Big Thompson River beginning on September 20, 2018.

    As of today, September 18, releases from Olympus Dam into the Big Thompson River are at 26 cubic feet per second (cfs). Between September 20th and October 12, releases are expected to rise to approximately 225 cfs.

    This forecast assumes native inflows into Lake Estes as well as irrigation demands will not change significantly from our current projections, but both are subject to unexpected fluctuations.

    @Northern_Water turns dirt on Southern Water Supply Project

    Southern Water Supply Project

    From The Longmont Times-Call (Sam Lounsberry):

    Work on the pipeline, known as phase two of the Southern Water Supply Project, is being overseen by Northern Water, which manages Carter Lake as part of the Colorado Big-Thompson Project.

    Once complete, the pipeline will improve water quality and delivery reliability compared to the open, above-ground Boulder Feeder Canal that currently brings water from Carter Lake to Boulder Reservoir.

    The new pipeline will pump 50 cubic feet per second of Colorado-Big Thompson and Windy Gap Project water, with Boulder receiving the bulk of the water among participants at the Boulder Reservoir Water Treatment plant, the pipeline’s terminus.

    Boulder will receive 32 cubic feet per second and bear $32 million of the cost, according to city spokeswoman Gretchen King, while Left Hand Water District — which serves a 130-square-mile area between Longmont and Boulder — will receive 12 cubic feet per second and pay about $8 million for its share of the project…

    Left Hand will have another $2 million of cost from the district’s addition of a hydroelectric generator at the intersection of the new Southern Water Supply pipeline and the entrance to the district’s Dodd Water Treatment Plant. The generator will produce enough power to satisfy about a third of the plant’s electricity need, according to district Manager Christopher Smith…

    Berthoud and Longs Peak Water District — which serves Boulder and Weld County residents in an area north of Longmont — will each receive 3 cubic feet per second, but on Thursday officials from the town and district could not to provide their share of the costs of the remaining $4 million for the project.

    Smith noted the pipeline, which has an estimated completion date of March 2020, will not only further protect water quality, but also will allow year-round water delivery to Left Hand Water District’s Dodd Water Treatment Plant…

    “During some portions of the year the pipeline will act as the primary source of raw water for the participants in the project,” the Northern Water release states.

    Currently, the Boulder Feeder Canal is offline from Oct. 31 to April 1 annually, Smith said. When the canal is down, so, too, is the Dodd Water Treatment Plant…

    When the pipeline is complete, the Dodd Plant will be open year-round.

    The first 12 miles of new pipeline, from Carter Lake to St. Vrain Road in Longmont, will parallel the existing Southern Water Supply Project pipeline, which was runs to Broomfield and was completed in 1999.

    From St. Vrain Road, the new pipeline will continue south to the Boulder Reservoir Treatment Plant.

    Front Range water group pushes back project that would pull from #ColoradoRiver, citing lawsuit — @AspenJournalism #COriver

    A view of the location of the proposed Chimney Hollow dam and reservoir site in the foothills between Loveland and Longmont. The 90,000 acre-foot reservoir would store water for nine Front Range cities, two water districts and a utility, and is being held up a lawsuit challenging federal environmental reviews. Graphic credit: Brent Gardner-Smith

    From Aspen Journalism (Brent Gardner-Smith):

    The Front Range water district that wants to build the Chimney Hollow Reservoir and pull more water from the Colorado River is delaying construction bids and issuing revenue bonds, citing a lawsuit by Save the Colorado, the Sierra Club and other environmental groups challenging federal approvals for the project.

    The Northern Colorado Water Conservancy District had hoped to have the project, now estimated at $570 million, under construction by early 2019 and completed by 2023, but now it is uncertain when construction will begin because of the lawsuit filed in U.S. District Court in Denver late last year.

    “Our original schedule was to be out to bid about right now and we would be selling bonds right now,” Jeff Drager, Northern’s director of engineering, said earlier this month.

    Chimney Hollow Reservoir is at the core of what’s known as the Windy Gap Firming Project. Northern, through its affiliated municipal subdistrict, plans to build the 90,000 acre-foot reservoir to provide a “firm annual yield” of 30,000 acre-feet of water from the Colorado River to nine Front Range cities, two water districts and a utility.

    About 9,000 acre-feet a year of additional water is expected to be diverted from the headwaters of the Colorado River as a result of the project.

    The 346-foot-tall dam, which would be the third tallest in Colorado, is located between Loveland and Longmont in Larimer County next to an existing reservoir, Carter Lake.

    Drager said since the litigation was filed last year Northern has taken the opportunity to do more engineering and design work on the dam, including the upcoming drilling of 40 holes to further explore softer rock found at the location of the left abutment of the dam.

    “We’re now scheduled to be at a point where we could go out to bid for construction and issue bonds probably in February or March,” he said.

    But at that point Drager said Northern would have to see what progress has been made in the lawsuit.

    “If I had to guess,” he said, “I’d say we’ll be slowed down.”

    The parties in the lawsuit are waiting for the judge in the case to rule on if the voluminous administrative record in the case is complete, including on a motion to add a recent report commissioned by Save the Colorado on actual water use, and if motions to intervene in the case by Northern, the Colorado Department of Natural Resources and the city of Broomfield will be accepted…

    The lawsuit contends that a review of the proposed project by the Bureau of Reclamation and the Army Corps of Engineers under the National Environmental Policy Act was flawed and that the resulting approvals should be overturned.

    The federal review of the project began 2003. Reclamation issued its approval in 2014 and the Corps issued its approval in May 2017.

    Five nonprofit environmental groups filed a lawsuit in October, including Save the Colorado, Save the Poudre, Living Rivers, the Waterkeeper Alliance and WildEarth Guardians. The Colorado chapter of the Sierra Club joined the lawsuit in November.

    “The Windy Gap Firming Project is an apt example of inadequate analysis and poor decision-making that will ultimately result in significant new diversions from the Colorado River to provide the Front Range with unneeded water supply,” the environmental groups told the court in a recent brief.

    The delay in issuing bonds means that the 12 entities paying for the project will have to contribute $10 million in cash to allow Northern to keep the project moving forward, instead of using money expected to be available after selling municipal bonds. The 12 entities have put in $34 million to date toward the project.

    “We had hoped that our funding for 2019 was going to come from sale of the bonds and starting construction, but because of the litigation that we have, that’s delayed a little bit,” Drager told Northern’s board of directors at a meeting in Berthoud on August 9. “That $10 million will be provided by the participants in early 2019 and that should carry us through, we hope, until we are ready to put the project out to bid and sell the bonds to pay the rest of the cost.”

    Northern owns and operates the Colorado-Big Thompson Project, which includes the huge Lake Granby Reservoir and the Adams Tunnel that sends over 200,000 acre-feet of water of Colorado River each year under Rocky Mountain National Park to the east slope.

    The C-BT Project also diverts water pumped up from the relatively small 445-acre-foot Windy Gap Reservoir, built in the early 1980s to serve as a pumping forebay on the Colorado River, just below its confluence with the Fraser River in Grand County.

    But Windy Gap is limited in how much water it can deliver because of its junior water rights and instream-flow obligations below the dam.

    Northern says Chimney Hollow Reservoir will allow it to pump water from Windy Gap in wetter years and store the water until needed in drier years by the 12 participating entities, which include Broomfield, Greeley, Longmont and Loveland.

    But the environmental groups say the federal agencies reviewed the proposed project with an overly narrow focus on how to fix the Windy Gap project and not on other potential ways to meet Front Range water demands.

    “Reclamation did not seriously consider reasonable alternatives to provide water to Windy Gap participants and allowed (Northern) to plow ahead with its original choice — the firming project — and double down on its busted bet,” the lawsuit states.

    Reclamation and the Corps told the court in May that the agencies conducted “an independent evaluation” and concluded the project “is needed to meet a portion of the existing and future water needs of the growing east slope municipalities.”

    Northern, on its website, points out “the project has been approved by the U. S. Bureau of Reclamation, U.S. Army Corps of Engineers, Grand County, Colorado Parks and Wildlife and endorsed by Gov. John Hickenlooper. It also has support from several environmental groups such as Trout Unlimited.”

    The support from some environmental organizations, including Trout Unlimited, stems from the mitigation measures designed to reduce its impact on the Colorado River headwaters, including a new bypass, or connectivity, channel that will allow more of the river to flow past the Windy Gap Reservoir.

    Lurline Underbrink Curran, the former county manager for Grand County, has also appealed to Robert Kennedy, Jr., of Waterkeeper Alliance, to drop the lawsuit.

    “Any lawsuit that delays or stops this work is a detriment to the Colorado River,” Currant wrote in Oct. 2017. “If the Windy Gap Project does not go forward, the hard-won concessions evaporate, and the Colorado River will continue to degrade.”

    Editor’s note: Aspen Journalism is covering the Roaring Fork and Colorado River basins for The Aspen Times. The Times published this story on its website on Tuesday, Aug. 21, 2018, as did the Glenwood Springs Post Independent.

    Loveland tries to unravel the knot of future water supply

    Green Ridge Glade Reservoir

    From The Loveland Reporter-Herald (Julia Rentsch):

    Forecasting a future in flux

    By 2042, the city of Loveland is projected to demand 30,000 acre-feet of water a year, according to projections calculated by Loveland Water and Power staff. Comparatively, the city currently needs about 18,000 acre-feet annually, and the city’s diverse portfolio of water sources yields a firm 22,400 acre-feet each year.

    One acre-foot is enough water to cover one acre of land, one foot deep. It’s about enough water to supply two homes for a year, said Larry Howard, a senior civil engineer in the city of Loveland’s water resources division.

    Meanwhile, both the city’s population and acreage is growing.

    Loveland’s 2017 data and assumptions report states the city now has a population of 74,385 within a 35 square mile area, and at ultimate buildout will cover 66 square miles. By 2042, Loveland’s population is estimated to hit 110,000 people, according to the same report.

    But, simultaneously, per-capita water consumption has been steadily falling nationwide over the past 20 years due to efficient fixtures and conservation initiatives, Bernosky said. Additionally, the introduction of metered water rates has played a role in reducing use compared to the previous flat monthly fee, Greene said.

    Luckily for the city, one variable is already locked in: The city of Loveland’s water district is surrounded on all sides by other districts, so the area it will serve is finite.

    Nevertheless, Bernosky said it is very difficult to take these trends and accurately predict the city’s water needs. There are a lot of pitfalls in forecasting the future as development patterns shift or decline, technology advances, natural events like droughts take place, economic factors play in and unexpected events occur, he said.

    “It’s very, very confusing right now,” he said. “A lot of it is very much in flux.”

    The latest E-Waternews is hot off the presses from @Northern_Water

    Looking east toward the Chimney Hollow Reservoir site, which is just this side of the red ridge. On the other side is Carter Lake Reservoir and beyond that, the Loveland area.

    Click here to read the newsletter. Here’s an excerpt:

    New website offers better access to Windy Gap Firming Project info

    Northern Water and the Municipal Subdistrict have launched a revamped website to provide easy-to-find data regarding the Windy Gap Firming Project and its chief component, Chimney Hollow Reservoir.

    The site, http://chimneyhollow.org, offers answers to frequently asked questions, information for potential contractors and download-ready fact sheets. In addition, it offers a video from Gov. John Hickenlooper that discusses his endorsement of the project as well as its place in the the Colorado Water Plan.

    As the project moves forward, the site will also present information related to the construction of Chimney Hollow Reservoir as well as the mitigation and enhancement efforts being conducted by Northern Water’s Municipal Subdistrict.

    The project also has a presence on Facebook, found here.
