Fast-growing Douglas County communities need more #water. Is a controversial San Luis Valley export plan the answer? — @WaterEdCO #Water22 #RioGrande

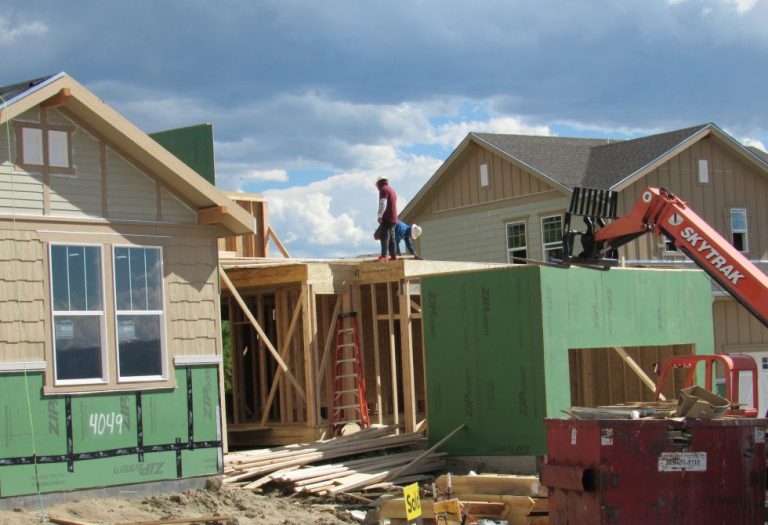

Construction workers build a single family home in Castle Rock. The community needs new surface water supplies to reduce its reliance on non-renewable groundwater. Credit: Jerd Smith

Click the link to read the article on the Water Education Colorado website (Jerd Smith:

Castle Rock’s building boom has barely slowed over the past 20 years and its appetite for growth and need for water hasn’t slowed much either.

The city, which ranks No. 1 in the state for water conservation, will still need to at least double its water supplies in the next 40 years to cope with that growth. It uses roughly 9,800 acre-feet of water now and may need as much as 24,000 acre-feet when it reaches buildout.

With an eye on that growth and the ongoing need for more water, Douglas County commissioners are debating whether to spend $10 million in federal American Rescue Plan Act funding to help finance a controversial San Luis Valley farm water export proposal.

Thirteen Douglas County and South Metro regional water suppliers say they have no need or desire for that farm water, according to Lisa Darling, executive director of the South Metro Water Supply Authority. [Editor’s note: Lisa Darling is president of the board of Water Education Colorado, which is a sponsor of Fresh Water News]

“It is not part of our plan and it is not something we are interested in,” said Mark Marlowe, director of Castle Rock Water. “We have invested hundreds of millions of dollars in our long-term plan and we are pursuing the projects that are in that plan. The San Luis Valley is not in the plan.”

Renewable Water Resources, a development firm backed by former Colorado Gov. Bill Owens and Sean Tonner, has spent years acquiring agricultural water rights in the San Luis Valley. It hopes to sell that water to users in the south metro area, delivering it via a new pipeline. In December, RWR asked the Douglas County commissioners for $10 million to help finance the $400 million plus project.

Tonner did not respond to a request for comment for this article, but he has said previously that the water demands in south metro Denver will be so intense in the coming decades, that the San Luis Valley export proposal makes sense.

Opposition to the export plan stems in part from concern in the drought-strapped San Luis Valley about losing even a small amount of its water to the Front Range. But RWR has said the impact to local water supplies could be mitigated, and that the proposed pipeline could help fund new economic development initiatives in the valley.

Stakes for new water in Douglas County and the south metro area are high. In addition to demand fueled by growth, the region’s reliance on shrinking, non-renewable aquifers is putting additional pressure on the drive to develop new water sources.

Denver Basin Aquifer System graphic credit USGS.

Marlowe and other water utility directors in the region have been working for 20 years to wean themselves from the deep aquifers that once provided clean water, cheaply, to any developer who could drill a well. But once growth took off, and Douglas County communities super-charged their pumping, the aquifers began declining. Because these underground reservoirs are so deep, and because of the rock formations that lie over them, they don’t recharge from rain and snowfall, as some aquifers do.

At one point in the early 2000s the aquifers were declining at roughly 30 feet a year. Cities responded by drilling more, deeper wells and using costly electricity to pull water up from the deep rock formations.

Since then, thanks to a comprehensive effort to build recycled water plants and develop renewable supplies in nearby creeks and rivers, they’ve been able to take pressure off the aquifers, which are now declining at roughly 5 feet per year, according to the South Metro Water Supply Authority.

The goal among Douglas County communities is to wean themselves from the aquifers, using them only in times of severe drought.

Ron Redd is director of Parker Water and Sanitation District, which serves Parker and several other communities as well as some unincorporated parts of Douglas County.

Like Castle Rock, Parker needs to nearly double its water supplies in the coming decades. It now uses about 10,000 acre-feet annually and will likely need 20,000 acre-feet at buildout to keep up with growth.

Parker is developing a large-scale pipeline project that will bring renewable South Platte River water from the northeastern corner of the state and pipe it down to the south metro area. Castle Rock is also a partner in that project along with the Lower South Platte Water Conservancy District in Sterling.

Redd said the San Luis Valley export plan isn’t needed because of water projects, such as the South Platte Water Partnership, that are already in the works.

“For me to walk away from a project in which we already have water, and hope a third party can deliver the water, just doesn’t make sense,” Redd said.

The costs of building two major pipelines would also likely be prohibitive for Douglas County residents, Redd said.

“We would have to choose one. We could not do both.”

Steve Koster is Douglas County’s assistant planning director and oversees new developments, which must demonstrate an adequate supply of water to enter the county’s planning approval process.

Koster said small communities in unincorporated parts of the county reach out to his department routinely, looking for help in establishing sustainable water supplies.

He said the county provides grants for engineering and cost studies to small developments hoping to partner with an established water provider.

“All of them are working to diversify and strengthen their water systems so they are sustainable. Having a system that encourages those partnerships is what we’re looking at,” Koster said.

Potential Water Delivery Routes. Since this water will be exported from the San Luis Valley, the water will be fully reusable. In addition to being a renewable water supply, this is an important component of the RWR water supply and delivery plan. Reuse allows first-use water to be used to extinction, which means that this water, after first use, can be reused multiple times. Graphic credit: Renewable Water Resources

Whether an RWR pipeline will play a role in the water future of Douglas County and the south metro area isn’t clear yet.

Douglas County spokeswoman Wendy Holmes said commissioners are evaluating more than a dozen proposals from water districts, including RWR, and that the commission has not set a deadline for when it will decide who to fund.

Jerd Smith is editor of Fresh Water News. She can be reached at 720-398-6474, via email at jerd@wateredco.org or @jerd_smith.

How thirsty is Douglas County? #Water providers work to transition to renewable sources — #Colorado Community Media #RioGrande #SouthPlatteRiver

Rueter-Hess Dam before first fill. Photo credit: Parker Water & Sanitation

Click the link to read the article on the Colorado Community Media website (Elliot Wenzler):

On an average day, 25 people move to Douglas County. Each one needs to drink, shower, water their lawn and wash their dishes. The full impact of that growth is difficult to see, but it’s easy to understand: more people need more water. And in a county where thousands of homes rely on a limited supply of underground aquifers, water providers are constantly working to shift to more sustainable resources before they run out.

Denver Basin Aquifer System graphic credit USGS.

Some aquifers buried under Douglas County have lost two to six feet in depth of water. Local water providers have noticed their supply wells aren’t producing like they once did.

“It’s like sucking water out of the bathtub with a straw,” said Rick McLoud, water resources manager for Centennial Water & Sanitation. “There’s only so much water in the bathtub and the sooner you suck it out with a straw, the sooner it will be gone.”

[…]

To meet those demands, water providers are planning a mix of conservation efforts, wastewater projects and new infrastructure for renewable resources of water. The county government is also looking at how to bring in more water and is considering spending a portion of their $68 million in federal funds from the American Rescue Plan Act on the issue.

‘Overreliance on groundwater’

As Douglas County’s development has surged since the 1990s, many of the largest communities such as Parker and Castle Rock have relied on groundwater to fill residents’ bathtubs and sinks, said State Engineer Kevin Rein…Groundwater from aquifers makes up about 65% of the water used by Parker Water and Sanitation, which is the provider for Parker and parts of Lone Tree and Castle Pines, and by Castle Rock Water. Centennial Water uses about 20% groundwater. Those ratios can change depending on drought conditions…

Douglas County sits on a layer of several aquifers, including the Arapahoe, Denver, Dawson and the Laramie-Fox Hills aquifers. Most major water providers use the water in the Arapahoe and Denver aquifers, which reach depths of 1,700 and 600 feet beneath the ground, respectively…

Under Douglas County’s guidelines for development in unincorporated areas, only the western part of the county is not allowed to rely on their groundwater for development, said Steve Koster, assistant director of planning services for the county. Those communities must provide either a renewable water source or use groundwater from the eastern part of the county. Koster said the county is not actively looking at requiring or incentivizing developers to instead look for renewable resources of water…

Parker Water and Sanitation is working on a project that will partner with a water conservancy district in Sterling, a town in eastern Colorado, to capture unused water during high runoff years from the South Platte River there and store it to pipe back to the town. The project won’t impact existing water rights and won’t allow buy-and-dry of nearby agriculture, Redd said. In order to meet Parker’s projected water demands, the project will need to be complete by 2040, Redd said. That project would get Parker Water to 75% renewable water and would provide water for more than 300,000 people in Douglas County, including in Parker, Castle Rock and portions of Castle Pines and Lone Tree, according to a project proposal. Castle Rock Water is a partner on that project.

Over the next 20 to 30 years, Castle Rock plans to invest about $500 million in renewable water projects including new pipelines, additional storage and water rights. Marlowe said the reason they spread out those projects over time is to keep rates for their customers down. By 2050, Castle Rock plans to move to 75% renewable and by 2065 have a 100% renewable system for wet or average years.

Dominion Water and Sanitation, which serves about 1,200 homes in Sterling Ranch, plans to be 90% renewable by 2040. Sterling Ranch is slated to add about 11,000 more homes to their community in that same time period at a rate of 450 homes per year. Dominion also plans to include about 700 other existing homes from smaller communities to their service area soon. Right now, Dominion is 100% renewable but is set to drill wells in the Cherokee Ranch area to blend some groundwater into their system, making it more drought-resistant, Cole said. They are also planning to build a river intake on the South Platte River and a wastewater treatment facility, which will provide at least 1,600 acre-feet of water per year to Sterling Ranch…

Castle Rock plans to incorporate programs in the coming years that encourage more efficient utilities and lawns that don’t require heavy irrigation. At the statewide level, a bill being considered by the legislature this session would pay residents up to $2 per square foot to rip out their irrigated turf and replace it with less thirsty alternatives. Sterling Ranch has focused on a program they call “demand management” that allows residents to have a live look at their water usage and bills…Their community also has banned the use of bluegrass, a type of turf that demands lots of water. Instead they offer a variety of drought-resistant plants for landscaping…

A view of public lands around the Sangre de Cristo Mountains and just south from the area Renewable Water Resources has proposed a wellfield for water exportation. Photo credit: Alamosa Citizen

As the commissioners consider how to approach the issue, $68 million in federal funds has the potential to aid in addressing the water demands of a growing community. One proposal for the money, which the commissioners have dedicated six two-hour meetings to discussing, would pump about 22,000 acre-feet of water per year to Douglas County from the San Luis Valley. Renewable Water Resources, the private company proposing the project, says that’s enough for 70,000 houses. The project has been met with ire from many in the valley, though, as multiple water conservation districts and elected officials there have said they don’t have enough water to spare and it would damage their agriculture-based economy…So far, all the major water providers in Douglas County have said they are not interested in using the water from the RWR proposal. Darling says that’s in part because many providers have already heavily invested in other projects…

Commissioners have also heard presentations from Parker Water, who asked them to consider using about $20 million of the federal funds to help their South Platte River project, and Dominion, who asked for help funding their regional wastewater plant in partnership with Castle Rock Water and the Plum Creek Reclamation Authority.

Livestock controversies, water issues top ag stories of 2021: Logan County Fair back on track, but conservation easement issues derailed again — The #Sterling Journal-Advocate

South Platte River at Goodrich, Colorado, Sunday, November 15, 2020. Photo credit: Allen Best

From The Sterling Journal-Advocate (Jeff Rice):

Colorado’s agriculture industry saw COVID-19 in the rear-view mirror in 2021 and focused on securing a future for farmers and ranchers. As if low commodity prices and rising input costs weren’t enough, ag folks – especially in the livestock sector – saw themselves beset by even more challenges.

Colorado’s livestock industry staged a statewide celebration in March as thousands of Coloradans feasted on beef at an estimated 100 events across the state.

The events were held as a protest against Gov. Jared Polis’ proclamation recognizing the national MeatOut observance on March 21. MeatOut is a national movement to reduce or eliminate animal protein from Americans’ diet.

Sterling’s Meat-In event was conceived by Jason Santomaso, hosted by Sterling Livestock Commission Co. and the Santomaso family, and drew approximately 2,400 people to dine on all-beef hamburgers and bratwursts. They also bid on a wide range of items to raise funds for the Santas of Sterling Miracle Letter program. The event raised in the neighborhood of $130,000, some of which the Santas turned back to help a family in need.

At the time, Gov. Polis was already trying to mend fences after backlash from his MeatOut proclamation. On March 12 the Colorado Livestock Association was notified that Polis had signed a proclamation naming March 22 Colorado Livestock Proud Day.

The governor had another opportunity to support the livestock industry in Colorado, and didn’t hesitate to grab it. At the end of March, as if to nail down his credibility among stockmen, Polis issued a strongly-worded statement opposing the proposed Protect Animals from Unnecessary Suffering and Exploitation initiative, nicknamed PAUSE, saying it would destroy the state’s livestock industry and devastate Colorado’s economy.

Livestock producers claimed that, if passed, PAUSE would criminalize many widely accepted animal husbandry practices necessary for successful livestock production. The question, officially known as Initiative 16, passed muster with the state’s Title Board, but that decision was appealed by a coalition of agricultural organizations. In June, the Colorado Supreme Court unanimously struck down the initiative, saying it didn’t meet statutory requirements.

Landowners suffered another setback at the hands of the Colorado General Assembly when Colorado’s conservation easement fix bill failed get needed support.

Senate Bill 21-033, Sponsored by Sterling’s Sen. Jerry Sonnenberg, would have created a new state income tax credit for certain taxpayers who were denied state income tax credits for conservation easements donated between 2000 and 2013 if the IRS allowed a federal income tax deduction for the same donation.

The bill would have helped landowners who donated development rights on their properties by setting aside $149 million from the state treasury to pay for the conservation easement tax credits rejected by the Colorado Department of Revenue more than a decade ago.

Sonnenberg and his allies had shepherded the bill, seen by many as the last chance to correct a gross injustice, through six committee hearings and a Senate floor vote before it arrived in the House Appropriations Committee to be referred to the House floor for final vote. On the last day of the legislative session, however, Democrats on the committee killed the bill with a 7-4 party line vote…

Water continued to be an issue of contention in 2021 with two steps forward and one step backward. The forward steps were in the formation of a partnership between the Parker Water and Sanitation District and the Lower South Platte Water Conservancy District to develop a new water right in the lower South Platte. But a lawsuit filed against the LSPWCD, if successful, would probably end that partnership.

In September, LSPWCD and PW&SD issued a joint press release announcing the formation of the Platte Valley Water Partnership, a joint water supply project to use a new water right that the two entities own along the South Platte River near Sterling.

The project will make use of new and existing infrastructure to store and transport water for agricultural use in northeastern Colorado and municipal use along the Front Range. The partnership involves the phased development of the water right. The early phases would involve a pipeline from Prewitt Reservoir in Logan and Washington counties to Parker Reservoir, which supplies the City of Parker. Later developments would see a 4,000 acre-foot reservoir near Iliff on land owned by Parker, and a 72,000 acre-foot reservoir near Fremont Butte north of Akron. A pipeline, pump stations, and treatment facility will also be built as part of the project.

Two months later, however, a Colorado taxpayer group filed a class action lawsuit in the 13th Judicial District Court in Logan County to try to overturn a mill levy increase by the Lower South Platte Water Conservancy District. The increase was primarily to help pay the District’s share of the cost of developing a new water right and building infrastructure for the Platte Valley Water Partnership project.

The Public Trust Institute, a Colorado-based public interest law firm, and the National Taxpayers Union Foundation of Washington, D.C., filed the lawsuit on behalf of an ad hoc group of taxpayers in Logan, Morgan, Sedgwick and Washington counties. Jim Aranci of Crook, Charles Miller, Jack Darnell and William Lauck of Morgan County and Curtis Werner of Merino are listed as plaintiffs in the lawsuit. Besides the water district, the defendants include the county treasurers of the four counties, who collected the taxes and handed the funds over to the district.

The suit was filed, the plaintiffs said, because although LSPWCD voters relieved the district of the requirements of the so-called Taxpayer Bill of Rights, or TABOR, the district still promised to go to the public for a vote to raise taxes. They maintain that raising the district mill levy from 0.5 mill to 1 mill violates that promise.

The district argues that it was authorized to levy up to 1 mill when it was created in the 1960s, but had never done so because it wasn’t needed. Now that it’s needed, the district says, the 1964 statute forming the district supersedes TABOR and levying the full mill without a vote is legal.

The South Platte River Basin is shaded in yellow. Source: Tom Cech, One World One Water Center, Metropolitan State University of Denver.

Two big — and controversial — #Colorado #water projects want to tap into #DouglasCounty stimulus slosh-funds: With the county asking for ideas on how to spend $68 million from the American Rescue Plan, every dam, pipeline and diversion rushes in — The Colorado Sun

The South Platte River Basin is shaded in yellow. Source: Tom Cech, One World One Water Center, Metropolitan State University of Denver.

From The Colorado Sun (Michael Booth):

Big Colorado water diversion projects itching to get going on long-sought dam and pipeline dreams are rushing to get first in line for thirsty Douglas County’s $68.2 million in federal stimulus money.

Drinking water dams and pipelines have joined smaller-scale local water treatment and sewage projects, for totaling $247 million of the $280 million in overall stimulus requests in Douglas County so far, a county spokeswoman said. The other categories making up the remainder of the $280 million in proposals include broadband, economic recovery and mental health delivery.

Some of the biggest requests for Douglas County’s share of American Rescue Plan Act spending come from drinking water developers looking to jumpstart projects that can take decades to complete.

An $828 million, two-reservoir, 125-miles-of-pipeline project led by Parker’s water department wants $20 to 30 million of Douglas County’s stimulus to jumpstart the engineering and environmental work. The project would pull junior water rights off the South Platte River near Sterling in high runoff years, fill the new reservoirs, and pipe drinking water down to high-growth cities such as Parker, Castle Rock and others…

A second big request on Douglas County’s plate is a $20 million bid from Renewable Water Resources, which has raised near-unanimous opposition to its proposal to buy up San Luis Valley groundwater, pipe it over the Front Range, and sell it to drinking water providers in Douglas County and other growing communities…

Douglas County held the first of a planned series of live and streamed town halls discussing the American Rescue Plan requests [December 9, 2021], with staff providing information on each of the $280 million in proposals so far. More town halls are planned for early 2022, county spokeswoman Wendy Manitta Holmes said. County commissioners have months of deliberations to go before they allocate the $68.2 million.

The ambitious, multi-county water projects could be in for disappointment. County officials are not sure yet what restrictions the U.S. Treasury could put on stimulus spending, Holmes said. County staff has asked the Treasury department to provide more guidance on, for example, whether DougCo’s share of the stimulus could be spent in other counties for sprawling projects like the water diversions.

Other, simpler water projects making up the bulk of the $247 million in category requests include water treatment, reservoir and pipeline capacity, and sewage disposal, from Highlands Ranch to Sedalia. Seeking citizen input on the biggest priorities is exactly the reason for the extended town halls, Holmes said…

Parker’s proposal, a joint project with the Lower South Platte Water Conservancy District and Castle Rock’s water department, notes that population growth in Parker alone will balloon the city from 60,000 residents to 160,000 in coming years. The South Platte diversions would fill two new reservoirs to be built in farm and ranch country straddling Interstate 76, one called Iliff and the other, in a Phase 2, called Fremont Butte…

As for competition from the San Luis Valley pipeline, Redd said, “We’re not real fans of the project.” There are too many political hurdles to the proposal, and the valley is already suffering from water depletion, Redd said.

#Parker Water & Sanitation District and Lower South Platte Water Conservancy District announce pioneering water partnership #SouthPlatteRiver

The South Platte River Basin is shaded in yellow. Source: Tom Cech, One World One Water Center, Metropolitan State University of Denver.

Here’s the release from the two entities (Deirdre Mueller):

Parker Water & Sanitation District (PWSD) and the
project to use a new water right that the two entities own along the South Platte River near Sterling, Colo. The announcement kicks off a unique collaboration between a Colorado conservancy district and a municipal water provider.

Known as the Platte Valley Water Partnership, the project will make use of new and existing infrastructure to store and transport water for agricultural use in northeastern Colorado and municipal use along the Front Range. The project will increase the renewable water supply for PWSD’s existing and expanding customer base while preserving and supporting agricultural uses in the South Platte River Basin. This renewable water supply is predominately available during spring runoff and major storm events, and would otherwise leave Colorado.

LSPWCD General Manager Joe Frank said of the agreement, “It’s critical for our community to avoid the buy-and-dry issues that have become commonplace. By working together with Parker Water & Sanitation District on an agreement that meets both of our needs, we’ve found a solution that addresses both agricultural and municipal water shortages without further drying up irrigated agriculture.”

“We look forward to working together with Lower South Platte Water Conservancy District,” said PWSD District Manager Ron Redd. “We’ve been guided by the principles laid out in the Colorado Water Plan; by opening up a dialog we discovered we had many shared values and were able to create a regional solution that benefits us all.”

More information about the Platte Valley Water Partnership and the project agreement can be found at https://www.pwsd.org/PVWP.

From The Sterling Journal-Advocate (Jeff Rice):

According to Thursday’s announcement, the project will make use of new and existing infrastructure to store and transport water for agricultural use in northeastern Colorado and municipal use along the Front Range…

The partnership involves the phased development of the water right. The early phases would involve a pipeline from Prewitt Reservoir in Logan and Washington counties to Parker Reservoir, which supplies the City of Parker. Later developments would see a 4,000 acre-foot reservoir near Iliff on land owned by Parker, and a 72,000 acre-foot reservoir near Fremont Butte north of Akron. A pipeline, pump stations, and treatment facility will also be built as part of the project,

The LSPWCD and PWSD have been in talks with each other and with landowners for several years. Lower South Platte general manager Joe Frank publicly briefed his board of directors in December 2019 about progress on the project and negotiations have been ongoing since then.

The project will be used to capture excess water that would otherwise leave Colorado, primarily during spring runoff and storms. Colorado and Nebraska have an interstate compact that requires a certain amount of water to leave the state for downriver users, but in some cases millions of gallons of water in excess of that escape across the state line.

Frank said Thursday the Platte Valley Water Partnership is a win-win for urban and rural water users…

Forecasts show water supplies will not keep pace with demand by 2050 for agricultural (Ag) or municipal and industrial (M & I) needs if Colorado does not find new approaches. Source: 2019 Analysis and Technical Update to the Colorado Water Plan.

PWSD District Manager Ron Redd said the project is in line with Colorado’s Water Plan, a 2015 document that provides guidelines for providing an adequate water supply for the state’s growth through 2050.

Lower South Platte & Parker: Working with Farmers — @WaterEdCO

Hunter in fog at Prewitt Reservoir via Colorado Open Lands

From Water Education Colorado (Jason Plautz):

For the Parker Water and Sanitation District, collaboration is a guiding principle when it comes to water storage. To add supply for its 50,000-person Douglas County district and surrounding agricultural users, Parker acquired land that had water rights in Prewitt Reservoir, the 32,000 acre-foot reservoir south of Sterling, which it could pump more than 100 miles south to store in its own reservoirs. The Prewitt Reservoir was built for sugar beet farmers in northeastern Colorado, where North Sterling Irrigation District manager Jim Yahn says he worries that having municipalities draw from it could end up taking storage from agricultural users. Yahn encouraged Parker to consider a way to serve all users, including farmers.

“Buy and dry is the old way, and on the one hand, it’s probably easier to do it that old way. But it’s not the right way,” says Ron Redd, executive director for Parker Water. “Farmers have knowledge and they’ve helped us out on what we can and can’t do. When multiple stakeholders benefit, it’s a win all around.”

Parker is now looking at two new reservoirs, both on the Eastern Plains: a 6,000-7,000 acre-foot site near Iliff, northeast of Sterling, and, eventually, a 72,000 acre-foot site near Fremont Butte, southwest of Sterling and still some 100 miles from Parker’s Rueter-Hess Reservoir. Not only will they serve Parker, but through a partnership with the Lower South Platte Water Conservancy District, local agricultural users could draw from the reservoirs as well. The project will efficiently convey water through existing and improved Prewitt infrastructure.

Project partners are still working out how to share the water, but Yahn says the partnership represents a new way of thinking. “Even if agriculture can’t afford a new storage project, a new storage project can incorporate agriculture.” Parker will offset some maintenance costs for Prewitt when it draws from the reservoir as part of a deal Yahn describes as “a little like a toll road.”

Redd says the deal is just the start of work that could continue with the collaborative South Platte Regional Opportunities Water Group.

“Partnerships are hard and that’s why most people used to go it alone,” Redd says. “But our customers pay us to do the hard work and we’re seeing a lot more benefits when we partner with other districts.”

Jim Yahn: Photo by Havey Productions via TheDenverChannel.com

Parker and the Lower South Platte Water Conservancy District hope to build storage for Ag and municipal and send 20,000 acre-feet S.

The South Platte River runs near a farm in Henderson, Colorado, northeast of Denver. Henderson is the site of one of the possible reservoirs for the regional water project proposed by SPROWG. Photo credit: Lindsay Fendt/Aspen Journalism

From Water Education Colorado (Jerd Smith):

A fast-growing Douglas County city has filed a new claim for water on the South Platte River, a move that could allow it to boost its future water supplies by some 60 percent.

But the action could also undermine SPROWG, an innovative, collaborative effort by more than a dozen Front Range communities to capture and reuse water on the South Platte River near the Nebraska state line and return it to Eastern Plains farm communities, northern Front Range cities, and the metro area.

Parker’s legal move to claim water rights in the same region, in partnership with the Sterling-based Lower South Platte Water Conservancy District, is unfolding just as SPROWG completed a major feasibility study indicating its project could be built for roughly $3.2 billion to $4.2 billion.

Parker’s project, slated to be done in about 10 years, would add 20,000 acre-feet to the city’s current supply of 34,400 acre-feet…

Rhode Island Hotel 1908 Parker via Best of Parker

Though SPROWG’s feasibility study has been completed, years of planning lie ahead before the cooperative effort is ready to deliver water, with a completion date yet to be set.

“We are light years ahead of them,” said Ron Redd, manager of the Parker Water and Sanitation District. “We’ve offered to partner on anything they want to do. I hope, especially when it comes to storage, they will want to partner. But we are just way ahead of them.”

The Berthoud-based Northern Colorado Water Conservancy District, whose boundary encompasses much of the northern Front Range and extends out to the Nebraska border, is alarmed by Parker’s $500 million proposal, saying it violates the spirit of collaborative water planning embodied in SPROWG and that it could dramatically shrink the amount of water available for others at the table.

“It’s disappointing to me,” said Brad Wind, general manager of Northern Water. “SPROWG was initiated as a community effort. We were going to share the good, the bad and the ugly. When one entity files, it’s a much different process to look at community involvement and decide how to share the yield.”

Parker and the Lower South Platte district plan to develop at least 20,000 acre-feet of water for urban use, a number that rises to 30,000 acre-feet when the agriculture component is added in, according to Joe Frank, manager of the Lower South Platte district.

Frank also said Parker’s project is important to northeastern Colorado because it won’t result in a permanent dry-up of farmland and will give farmers in his district a more reliable source of water, helping stabilize farm communities that are already struggling.

Parker’s Redd said he’s hopeful, given the similarities between the two proposals, that a partnership can be developed with the existing SPROWG collaboration.

“I like the idea of controlling our own destiny,” he said. “And right now we’re assuming we’re going it alone. But my hope is they will join us.”

Jerd Smith is editor of Fresh Water News. She can be reached at 720-398-6474, via email at jerd@wateredco.org or @jerd_smith.

Rueter-Hess Dam before first fill. Photo credit: Parker Water & Sanitation

Parker Water schedules 2016 election

Rhode Island Hotel 1908 Parker via Best of Parker
Rhode Island Hotel 1908 Parker via Best of Parker

From Parker Water via The Parker Chronicle:

The Parker Water & Sanitation District is putting out a call for candidates to fill three vacancies on its board of directors.

The May 3 mail-ballot election will enable district customers to vote on candidates to assume seats held by Kelly McCurry, Bill Wasserman and Dale Reiman, whose terms expire this year. Prospective candidates must file “affidavits of intent” to the Parker Water & Sanitation District by Feb. 29, according to a resolution passed by the current board on Jan. 14.

If there are “not more candidates than offices to be filled,” district manager Ron Redd, who is serving as the designated election official, will cancel the election and declare the candidates elected, the resolution said.

For more information, go to http://www.pwsd.org, email rredd@pwsd.org or call 303-841-4627.

Rueter-Hess dam and reservoir offer hope for thirsty Colorado communities — The Denver Post

From The Denver Post (Bruce Finley):

Colorado water planners facing a projected 163 billion-gallon statewide annual shortfall by 2050 now are aiming to emulate water-stressed Parker (population 50,000), which labored for three decades to build its 185-foot-high Frank Jaeger dam, reservoir and plant. Parker’s leaders were driven by a desire to enable population growth up to 120,000 people without pumping more from dwindling underground aquifers.

Parker officials began their project in 1985 after anticipating a water shortfall as suburban development exploded. Longtime Parker Water employee Frank Jaeger scouted sites, filed for permits and obtained rights to divert water. Town leaders initially planned a reservoir to hold 16,200 acre-feet of water.

At first they focused on flooding Castlewood Canyon State Park. Courts rejected this.

Jaeger then negotiated with landowners for the current site, between Parker and Castle Rock. Environmental studies started in 1997. Designs were done in 2002. Construction began in 2004. In 2008, Jaeger and other suburban officials decided to make it a bigger reservoir, holding 75,000 acre-feet.

The reservoir was completed in 2012. And an adjacent water-cleaning plant last summer began operating — bringing reservoir water to residents who long have relied on declining underground water.

Any state push to build reservoirs will require determination and patience, said Jaeger, now retired. “You’ll need state sponsorship,” he said. “And you’ll need somebody who is going to stay around for the whole deal. They’re going to take a lot of heat.”

More dams and reservoirs likely would cost hundreds of millions and, if off the main stem of a river, require huge amounts of electrical power to pump water.

Parker installed five grid-powered motors — three 1,250 horsepower, two 500 horsepower. These move water from headwaters of Cherry Creek, at a diversion point near Stroh Road, through a 3-mile, 48-inch-diameter steel pipe that runs up a 250-foot-high hill before it reaches Rueter-Hess.

Then there’s the matter of obtaining enough water to fill Rueter-Hess, factoring in annual evaporation losses of about 3 percent.

Parker secured limited junior rights to surface water and, in May 2011, began diverting to fill the reservoir. When senior rights holders call for water in dry times, Parker’s diversions must stop. Today, Rueter-Hess holds 21,000 acre-feet.

The water treatment plant uses state-of-the-art filtering and chemical treatments to remove algae and minerals such as phosphorus so that the reservoir water is safe.

As Parker Water’s team formally opened the plant last month, [Ron] Redd said state planners will need to get started soon.

“It took Parker Water 25 years,” he said. “They’ll probably need more storage than what they are indicating. … You’re never disappointed with more storage.”

Rueter-Hess Water Purification Facility celebrates grand opening in Parker, CO — WaterWorld

The Colorado Department of Public Health and Environment provided regulatory approval for the first-time use of ceramic membrane filters for a drinking water system in the U.S. (Photo courtesy of Dewberry)
The Colorado Department of Public Health and Environment provided regulatory approval for the first-time use of ceramic membrane filters for a drinking water system in the U.S. (Photo courtesy of Dewberry)

From WaterWorld:

On Wednesday, Oct. 21, the Rueter-Hess Water Purification Facility (RHWPF) — located in the town of Parker, Colo., southeast of Denver — officially celebrated the grand opening of tours for the facility.

The water treatment plant, which serves a community of approximately 50,000 residents, uses new technologies that have enabled the Parker Water and Sanitation District (PWSD) to convert from rapidly declining groundwater sources to a renewable water supply, including surface water, groundwater, alluvial well water, and reclaimed wastewater.

Designed by Dewberry, the RHWPF is the first plant in the world to incorporate a trio of cutting-edge technologies to meet Environmental Protection Agency (EPA) drinking water standards. The process includes three key stages:

A coagulation, flocculation and sedimentation chamber using microsand to enhance particle sedimentation while reducing the chamber’s surface area requirements.

A recirculating powdered activated carbon (PAC) chamber cutting costs by sending used PAC back through the system, increasing the amount of contact time between PAC particles and dissolved organic compounds for a more aggressive and efficient treatment.

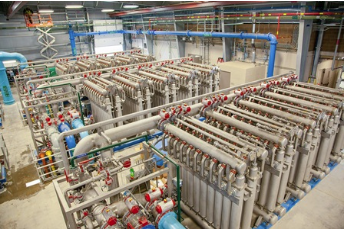

The treated water being pumped through ceramic membrane filters to remove remaining particles larger than 0.1 microns in size and any remaining microsand or PAC.

In the first such application in a drinking water system in the U.S., the 600 ceramic membrane modules were specifically chosen for their ability to withstand impacts from the abrasive sand and PAC particles used in upstream processes and then be cleaned back to like-new condition. The ceramic membrane filtration system is anticipated to last much longer than conventional polymeric membranes.

“The ceramic membranes are very durable and can withstand impacts from sand and powdered activated carbon, which is very abrasive,” said Alan Pratt, PE, Dewberry project manager for the design of the RHWPF. “The ceramic membranes can be cleaned back to a new condition, whereas polymeric membranes typically deteriorate over a life of six to 10 years and need to be replaced.”

The completion of the 10-MGD RHWPF (expandable to 40 MGD) is part of a visionary, multi-phase plan for the water district, where district leaders had long recognized groundwater as a diminishing resource within the rapidly developing area. The new network features a 50-CFS pump station that brings surface water from nearby Cherry Creek and Cherry Creek alluvial wells into the 75,000-acre-foot Rueter-Hess Reservoir, completed in 2012.

Water stored in the reservoir flows by gravity into the RHWPF. After moving through the two ballasted sedimentation chambers and the ceramic membrane filters, the disinfected water is pumped into the PWSD’s distribution piping network for use by customers. Wastewater is returned to nearby reclamation facilities and then to Cherry Creek for reuse.

In addition to Dewberry, the project team included Western Summit Constructors, Inc. as the primary contractor, Garney-Weaver for construction management, and Kruger, Inc. for the ballasted sedimentation and ceramic membrane filter technologies. “The ability for us to turn many different water qualities into a high-quality potable water supply has been made possible only with the combined effort of many different companies coming together,” said PWSD District Manager Ron Redd. “Dewberry, Western Summit and Kruger have all worked very hard to make this plant a reality.”

Parker opens new water treatment plant

The water treatment process
The water treatment process

From the Parker Chronicle (Chris Michlewicz):

Roughly 10 percent of Parker’s water is now going through a state-of-the-art treatment plant near Rueter-Hess Reservoir.

After a few initial hiccups, including the failure of a pump and issues with the feeding of chemicals used to rid the water of impurities, the $50.7 million treatment plant opened in mid-July following three weeks of testing.

Soon after, a handful of Parker Water and Sanitation District officials took their first drink of water processed through the sophisticated system of pumps, pipes and filters.

“We wanted to make sure everything was solid before we sent it out through the system,” said Ron Redd, district manager for Parker Water. “It tasted good!”

Construction began in 2012 on the treatment plant, which has been billed as an integral part of shifting from a reliance on nonrenewable groundwater in aquifers to renewable surface water. It incorporates many of the newest technologies and eventually will be able to process 40 million gallons per day. The first phase of construction spawned a facility that can churn out about 10 million gallons of treated water per day.

The new treatment plant processes 1.5 million gallons of the 12-million-gallon average needed to satisfy daily summertime demands, Redd said…

Four employees are based out of the treatment plant…

Approximately 20 percent of the total construction costs went toward ceramic filters that are more durable than traditional plastic filters and expected to last from 20-25 years.

“What’s different about this plant is it’s a fairly state-of-the-art facility,” Redd said. “It’s gathering a lot of attention from across the country and the world because of the technology we’re using. We’re anticipating lots of phone calls and (requests for) tours.”

Robbing our groundwater savings accounts for today’s needs — The Mountain Town News

From The Mountain Town News (Allen Best):

Dick Wolfe, Colorado’s state water engineer, recently defined “sustainable groundwater supply” as one that is managed so that recharge matches withdrawals in a way to avoid long-term depletion of the aquifer.

By that definition, Colorado is not, for the most part, using its aquifers sustainably. Nor, for that matter, is most of the nation or world.

That much was made clear at a conference on Dec. 4 that was conducted by the American Ground Water Trust. Andrew Stone, the organization’s executive director, said 14 percent of all water used to irrigate crops in the United States comes from mining groundwater aquifers. This started slowly, but picked up as pumps and cheap energy became available around the end of World War II. The extraction by farmers and cities of water above the rate of recharge is now close to 400 cubic kilometers.

“We are robbing our savings account,” he said.

Driven by population growth and the uncertain effects of climate change, pressures on these subterranean savings accounts will only worsen, he said. This is not inevitable. He cited Los Angeles, which after World War II turned to groundwater exploitation to satisfy growth. “In the 1960s, it was pretty clear that the LA Basin was cruising for big trouble,” he said. But unsustainable exploitation has ended.

Problems of groundwater exploitation are common in many areas of the country, but solutions must be forged locally, “aquifer by aquifer, region by region,” said Stone.

Sobering statistics

The day was littered with fascinating statistics. Jeff Lukas, of the Western Water Assessment, explained that of the 95 million acre-feet that falls on Colorado, only 14 million acre-feet end up as runoff in our streams and rivers. The remainder, 80 million acre-feet, evaporates or gets drawn back into the atmospheric through transpiration. Together, the two are called evapotranspiration, or ET.

This rate of ET will almost certainly rise as the atmosphere warms. In the last 30 years, temperatures have ratcheted up 2 degrees Fahrenheit. Climate models forecast another increase of between 2.5 to 5 degrees by mid-century in Colorado. By mid-century, the hottest summers of the last 50 to 100 years will become the norm.

Too, everything from corn to urban lawns will need 5 to 30 percent more moisture during the longer, hotter summers—assuming precipitation does not increase.

How much precipitation will change as the result of elevated greenhouse gases in the atmosphere remains a mystery. Unlike temperatures, average precipitation in Colorado has not changed appreciably in the last three decades. Climate models have been clear about increasing temperatures, but precipitation remains a flip of the coin.

However, warming alone will drive changes, “pushing both the supply and demand in the wrong direction,” said Lukas. Increased evapotranspiration will reduce runoff and the amount of moisture available to percolate into soils and down into aquifers. Spring runoff has already accelerated and will come one to three weeks earlier.

Bottom line: Hotter temperatures will drive farmers to suck up more subterranean water. If anything, aquifers will recharge more slowly.

Wolfe, in his turn at the microphone, had even more statistics: Of Colorado’s 16 million acre-feet, 10 million acre-feet flow out of state, mostly as a result of compacts governing the Colorado and other rivers.

“That leaves us about 6 million acre-feet in Colorado to use,” he said. This surface water provides about 83 percent of water used in Colorado, and the other 17 percent comes from aquifers, which are tapped by 270,000 wells.

Of this groundwater, 85 percent goes to agriculture, for more than 2 million acres, but there’s also a strong urban component. One in five Coloradans get their water from wells. Most prominent are Denver’s southern suburbs in Douglas County.

Denver’s South Metro

South Metro has been a poster child for living in the moment. It’s affluent and rapidly growing. Served almost exclusively by wells, the residents of Castle Park, Parker and adjoining areas comprise about 6 percent of Colorado’s population but command 30 percent of income. Today’s population of 300,000 residents is projected to grow to 550,000 by mid-century.

Wells have been dropping rapidly, five feet in just one year in Dawson, one of the aquifers.

Eric Hecox, executive director of the South Metro Water Supply Authority, explained that it was always understood that wells would not last forever. The area had hoped to benefit from Denver’s Two Forks Dam, which was to have been filled primarily by expanded diversions from the Western Slope.

Two Forks was sunk by environmental concerns in the early 1990s. Inconveniently, Douglas County surged in population, routinely landing in the top 10 of the nation’s fastest-growing counties, a distinction that only lately has abated.

Other projects have also nudged the South Metro area off its exclusive dependence on groundwater, but even collectively they do not provide the answer. Hecox called for continued efforts to pinpoint needs while creating a new generation of partnerships and infrastructure.

Can South Metro’s needs for sustainable water supplies be answered by building a giant pipeline from Flaming Gorge Reservoir, on the Utah-Wyomng border? That idea was proposed in 2006 by entrepreneur Aaron Million, and then echoed by Frank Jaeger, the now-retired director of Parker Water and Sanitation District.

Hecox said the Bureau of Reclamation study about water availability from Flaming Gorge has not been completed. That study will provide the 14 members in Hecox’s South Metro coalition “base information on which to decide whether we want to pursue it any further,” he said.

Two key agriculture areas

Two agriculture areas in Colorado that rely upon aquifers are in arguably worse shape. The San Luis Valley has an area called the Closed Basin. With the arrival of electricity to farms in the 1950s, large-scale pumping began and, for a number of years, all went well, said Steve Vandiver, general manager of the Rio Grande Water Conservation District.

Despite earlier hints of problems, the magnitude of over-pumping started becoming apparent in 1998. One million acre-feet had been pumped from the aquifer above the amount of recharge. Figuring out what to do took time and negotiation. “There have been rocks thrown from every quarter,” he said.

The plan now in place has cut pumping by 30 percent during the last three years. The amount of irrigated acreage has declined from 175,00 to 150,000 acres. Water use on those remaining acres has been reduced in some cases by planting different, less water-intensive crops and also by using different irrigation methods.

Up to 300,000 cubic feet per second of water continues to be pumped on the fields in the Closed Basin on hot summer days.

And the Ogallala….

The Ogallala Aquifer is perhaps America’s best-known story of groundwater depletion. It extends over parts of eight states, from Texas to South Dakota, and the aquifer has declined at a shocking rate in several of those states, but more slowly or not at all in places, especially the Nebraska Sand Hills.

The Republican River Basin of northeastern Colorado is emblematic of many. Farmers working with local districts and the state government have been shifting the paradigm. Whether they’re shifting rapidly enough is an open question.

The river and its tributaries originate on the high plains, gaining no benefit from mountain snowpack. Yet this region had 480,000 irrigated acres in an area where annual precipitation is only 17 inches a year.

The key: mining the Ogallala. In the late 1970s, Colorado began taking action to slow the unsustainable over-pumping, but more radical measures were triggered by the need to comply with the interstate compact governing the river shared with Nebraska and Kansas. Colorado was forced to release more water downstream.

It did this partly by abandoning Bonny Reservoir, eliminating the evaporative losses. At greater expense, the district constructed an expensive pipeline and now pumps water—ironically from wells—to release into the Republican River at the state line. The total cost of the pipeline and the purchase of water rights was $48 million.

Much is being done to steer the Titanic away from the iceberg of exhausted aquifer water, but Deb Daniel, general manager of the Republican River Water Conservation District, suggested the magnitude of the challenge when she said: “Sustainable, that’s a scary word where I come from.”

(For a story I recently wrote about the Ogallala in Colorado, see the Headwaters Magazine website).

Wells along the South Platte

Unlike everything else said in the day, several speakers argued that not enough pumping has been occurring along the South Platte River. Their solution: more reservoirs and also more acreage returned to production.

Robert A. Longenbaugh, a consulting water engineer, pointed to 400,000 acre-feet average annually flowing into Nebraska above the compact requirement. “I call that a waste of water,” he said. At the same time, he and others pointed to reports of basements in Weld County getting flooded because of rising groundwater levels.

Even in the 1960s, a Colorado law was adopted that formally recognized that aquifers and surface streamflows comingled waters . In other words, if you have a well a quarter-mile from the South Platte River at Greeley and pump it, that might mean less water in the river as it flows toward Fort Morgan.

The drought of 2002 forced the issue, and in 2006 the state put well irrigators into the priority system. In 2012, a hot and dry year, many wells had to be shut down and corn and other corps left to dry up. Longenbaugh called for changes.

“Strict priority administration of ground and surface rights does not maximize the beneficial use,” he declared. Instead, he wants to se a “real-time management of the South Platte, to monitor surface and ground water and “make short-term decisions” looking out six months ahead while still maintaining the priority-appropriation doctrine that is the bedrock of Colorado water law.

A panel of state legislators later in the day acknowledged varying degrees of agreement with Longenbaugh’s statement. Sen. Mary Hodge, a Democrat from Brighton, described a pendulum that went from “too lax” to now one of being “too stringent.”

Sen. Vicki Marble, a Republican from Fort Collins, described the situation as deserving of an “emergency measure.” She later added: “We should let people self-regulate,” while suggesting that the wells should be allowed to pump. “It’s their right,” she said.

More groundwater coverage here.

The Special District Association of Colorado recognizes Parker Water and Sanitation for collaboration

Rhode Island Hotel 1908 Parker via Best of Parker
Rhode Island Hotel 1908 Parker via Best of Parker

From the Parker Chronicle:

The Parker Water and Sanitation District is one of three special districts to be given a collaboration award this year.

The award was given by the Special District Association of Colorado during an annual conference Sept. 10-12 in Keystone. The collaboration award is given to districts “that have effectively and efficiently partnered with other entities and local governments” to benefit water users, according to a news release.

The PWSD joined with the Rampart Range and Sierra Ridge metro districts on a sewer system for the RidgeGate development in Lone Tree, which is served by Parker Water. The joint effort resulted in reduced infrastructure costs for citizens and an award for all three districts.

Ann Terry, the executive director of the Special District Association, said the project is a “true testament to the success that can be achieved through partnerships.”

More Parker coverage here and here.

“…we have a lot of communities on a diminishing aquifer” — Eric Hecox

rueter-hessplans

From The Denver Post (Steve Raabe):

The shimmering surface of Rueter-Hess reservoir seems out of place in arid Douglas County, where almost all of the water resources are in aquifers a quarter-mile under ground.

Yet the $195 million body of water, southwest of Parker, is poised to play a crucial role in providing water to one of the fastest-growing metropolitan areas in the U.S.

As recently as a few years ago, developers were content to tap the seemingly abundant Denver Basin aquifer to serve the thousands of new homes built each year along the southern edge of metro Denver.

But a problem arose. As homebuilding in Douglas County exploded, the groundwater that once seemed abundant turned out to be finite. Land developers and utilities found that the more wells they drilled into the aquifer, the more grudgingly it surrendered water.

“Now we have a lot of communities on a diminishing aquifer,” said Eric Hecox, executive director of the South Metro Water Supply Authority, a consortium of 14 water suppliers that serve 300,000 residents.

As water pressure in the Denver Basin steadily declines, developers and water utilities that rely on the aquifer are being forced to drill more wells and pump harder from existing wells.

Enter Rueter-Hess. The massive storage facility — 50 percent larger in surface area than Cherry Creek reservoir — aims to help developers wean themselves from groundwater by shifting to other sources.

The reservoir anchors a multifaceted water plan for the south metro area that includes the purchase of costly but replenishable surface water, reuse of wastewater and a greater emphasis on conservation.

Douglas County, long a magnet for builders enticed by easy access to Denver Basin aquifers, is taking the water issue seriously.

A new proposal floated by the county government would give developers density bonuses — up to 20 percent more buildout — for communities that reduce typical water consumption and commit to using renewable sources for at least half of their water.

“In the past, the county had not taken an active role in water supplies because groundwater was sufficient,” said Douglas County Commissioner Jill Repella. “But we understand that we cannot continue to be solely reliant on our aquifers. What we’re doing today will help us plan for the next 25 years.”

Parker Water and Sanitation District launched construction of Rueter-Hess in 2006 and began gradually filling the reservoir in 2011, fed by excess surface and alluvial well flows in Cherry Creek.

Partners in the project include Castle Rock, Stonegate and the Castle Pines North metropolitan district. Parker Water and Sanitation district manager Ron Redd said he expects more water utilities to sign on for storage as they begin acquiring rights to surface water.

The chief source of new supplies will be the Water Infrastructure and Supply Efficiency partnership, or WISE, in which Denver Water and Aurora Water will sell an average of 7,250 acre-feet a year to 10 south-metro water suppliers beginning in 2016. Most of them are expected to purchase storage for the new water in Rueter-Hess. An acre-foot is generally believed to be enough to serve the needs of two families of four for a year

Parker Water and Sanitation also is exploring ways to develop recreational uses at the dam — including hiking, camping, fishing and nonmotorized boating — through an intergovernmental agreement with other Douglas County entities.

Even three years after opening, the reservoir’s stored water has reached just 13 percent of its 75,000-acre-foot capacity. Yet Rueter-Hess is the most visible icon in Douglas County’s search for water solutions.

At stake is the ability to provide water for a county that in the 1990s and early 2000s perennially ranked among the fastest-growing in the nation. The number of homes in Douglas County has soared from 7,789 in 1980 to more than 110,000 today, an astounding increase of more than 1,300 percent.

The building boom slowed after the 18-month recession that ended in June 2009. Growth rates that had reached as high as 10 percent to 15 percent a year during the 1990s ratcheted down to about 1 percent to 2 percent.

But as the economy has begun recovering, Douglas County is once again “seeing high levels of demand” for new residential development, said assistant director of planning services Steve Koster.

One of the biggest Douglas County projects in decades is Sterling Ranch, a proposed community of 12,000 homes south of Chatfield State Park.

The 3,400-acre ranch sits on the outer fringes of the Denver Basin aquifer, making it a poor candidate for reliance on the basin’s groundwater.

As a result, the project developer will employ a mixed-bag of water resources, including an aggressive conservation and efficiency plan; surface-water purchases from the WISE program; well water from rights owned by Denver billionaire Philip Anschutz; and a precedent-setting rainwater-collection program.

Sterling Ranch managing director Harold Smethills described the Rueter-Hess concept as “brilliant,” even though his development has not yet purchased any of the reservoir’s capacity.

“You just can’t have enough storage,” he said.

More Rueter-Hess Reservoir coverage here and here. More Denver Basin Aquifer System coverage here.

Communities Protecting the Green is keeping a watchful eye on the Colorado-Wyoming Coalition #ColoradoRiver

Conceptual route for the Flaming Gorge Pipeline -- Graphic via Earth Justice
Conceptual route for the Flaming Gorge Pipeline — Graphic via Earth Justice

From The Green River Star (David Martin):

According to Don Hartley, a member of [Communities Protecting the Green], an organization known as the Colorado Wyoming Coalition is finishing a feasibility study involving the transfer of water from the Flaming Gorge. The coalition was originally known as the Parker Group, after the community in Colorado initially proposing the project, before it rebranded itself. According to a 2011 document titled “Flaming Gorge Investigation Status Report,” the municipal governments in Cheyenne and Torrington, along with the Laramie County government, are involved the coalition’s study to move water from the gorge to eastern Wyoming and northern Colorado.

The document states more than half a million people living in both states would be served by the project.

“It’s kind of slow right now, but things could get interesting once that study is completed,” Hartley said.

Hartley believes the study could be completed within a matter of weeks and said they need to be vigilant with the group because they pose the biggest threat to the river.

Hartley said the second issue on the horizon involves a state water plan under construction within the Colorado state government. One of the key issues Hartley and others at Communities Protecting the Green are watching involves the augmentation of the river to provide water to communities in Colorado.

More Flaming Gorge Pipeline coverage here and here.

Reuse: The WISE Partnership gets approval from the Denver Water Board


From the Denver Business Journal:

Denver Water last week approved the WISE partnership agreement that clears the way for the utility to delivery treated water to the area’s southern suburbs.

Approval of WISE, which stands for Water Infrastructure and Supply Efficiency, formalizes the regional cooperative water project. The agreement calls for the permanent delivery of 72,250 acre-feet of treated water from Denver and Aurora to members of the South Metro Water Supply Authority (SMWSA).

SMWSA was formed in 2004 from the banding together of smaller water utilities in south Denver.
With the agreement now in place, some of the water that currently flows down the South Platte River and out of the state would be recaptured by Aurora’s 34-mile Prairie Waters Pipeline and pumped back to the Peter D. Binney Water Purification Facility near the Aurora Reservoir. There, the water would be treated and piped to the southern suburbs.

The water delivery will begin in 2016. Members of the SMWSA must have infrastructure in place to move the water from the purification facility. The cost of the water and infrastructure for its delivery is estimated at $250 million over the next 10 years. Each member will independently determine how to finance their share of the project.

The participating members of SMWSA are the town of Castle Rock, Dominion Water & Sanitation District, Stonegate Village Metropolitan District, Cottonwood Water & Sanitation District, Pinery Water and Wastewater District, Centennial Water & Sanitation District, Rangeview Metropolitan District, Parker Water & Sanitation District, Meridian Metropolitan District and Inverness Water & Sanitation District.

More WISE Partnership coverage here.

Parker signs on to the WISE project for future supplies


From the Parker Chronicle (Chris Michlewicz):

Parker Water joins nine other members of the South Metro Water Supply Authority that have signed on to WISE, or the Water Infrastructure and Supply Efficiency agreement. The June 13 approval by the PWSD board of directors adds another source of water for the area’s long-term needs, said district manager Ron Redd.

Parker Water pulls much of its water supply from the Denver Basin Aquifer, but it also captures an average of 5,000 acre-feet annually off Cherry Creek. The WISE agreement will have Parker piping 12,000 acre-feet of recycled water from Aurora and Denver every 10 years for an indefinite period of time.

Water rates will likely go up 1 percent to 2 percent incrementally because of WISE, although any increases will not occur until a thorough rate analysis is conducted, Redd said. The results of the analysis will be released in mid-2014.

The PWSD will start receiving the first trickles of water in 2016 and get full delivery of 1,200 acre-feet starting in 2021. The district hopes to use an existing pipeline along the E-470 corridor to transport the water and is in the process of negotiating with the East Cherry Creek Valley Water and Sanitation District. If an agreement is not reached, the district would have to build its own infrastructure at a steep cost…

The supply coming from Denver and Aurora is water that has been used and treated. The district will again reclaim the water, meaning the average of 1,200 acre-feet coming in each year will actually measure close to 2,400 acre-feet, Redd said, adding there is a possibility that Parker Water might purchase more WISE water in the future…

Rueter-Hess Reservoir, which the PWSD built for storage, contains around 6,000 acre-feet. By the time the new water treatment plant off Hess Road opens in 2015, the reservoir will contain 15,000 to 20,000 acre-feet. It has the capacity for 72,000 acre-feet.

More Parker coverage here and here.

Parker Water and Sanitation District board is evaluating joining with Aurora and Denver in the WISE project


From the Parker Chronicle (Chris Michlewicz):

The Parker Water and Sanitation District board of directors will hear a presentation later this month from new manager Ron Redd, who will recommend that the district enter into WISE, the Water, Infrastructure and Supply Efficiency project. Six members of the South Metro Water Supply Authority, including Pinery Water and Wastewater, the Cottonwood Water and Sanitation District and Stonegate Village Metropolitan District, committed to WISE by signing intergovernmental agreements in late March. The agreements will bring nearly 7,000 acre-feet of recycled water to the south metro area…

The Parker Water and Sanitation District board asked Redd to examine the possibility of buying 500, 1,000 or 1,500 acre-feet through the WISE project. He was expecting to receive the results of a cost analysis on April 5 to determine the possible financial impacts. Any rate hikes on customers would likely be implemented incrementally and equate to about 2.5 percent to 3 percent per year, Redd said, cautioning that those figures are preliminary. The cost of WISE water increases annually over an eight-year period.

It would be relatively easy, Redd said, to move the reclaimed WISE water from Aurora to Parker if the district can come to an agreement to use a pipeline along E-470 owned by East Cherry Creek Valley Water and Sanitation District. If the board gives approval, the intergovernmental agreement would be signed by late May…

Rueter-Hess Reservoir, which contains 5,700 acre-feet of water and was built to store 70,000 acre-feet, will be paid off by the time the Parker Water and Sanitation District takes on more debt to build pipelines to transport the water that will be needed for the future.

Meanwhile, Centennial has inked an IGA with the WISE Partnership. Here’s a report from Ryan Boldrey writing for the Highlands Ranch Herald. Here’s an excerpt:

Centennial Water and Sanitation District was one of six members of the South Metro Water Supply Authority to sign an IGA this past week committing to more renewable water by way of the Water Infrastructure and Supply Efficiency Partnership. Through the agreement, Aurora Water and Denver Water will provide roughly 7,000 acre-feet of fully treated water annually to participating SMWSA members and deliver it in phases, starting in 2016. As part of the IGA, the participating South Metro WISE entities have agreed to fund new infrastructure that will move the water from Aurora’s Binney Water Purification Facility to its end locations. “A region-wide water solution makes more sense than having each water entity fending for themselves to source, treat and deliver renewable water to customers,” said Eric Hecox, executive director of SMWSA. “We’re excited about the progress we’re making through WISE towards transitioning the region from nonrenewable groundwater to renewable water.”

Hecox said that the agreement helps provide SMWSA with about a third of the necessary water that participating entities will need long-term. From here, work will continue on the Chatfield Reallocation Project as well as of other options and alternatives to bring more water to the region…

For Centennial Water specifically, it’s another step toward cementing a long-term supply and not relying as much on groundwater or leased water. “We’ve got many years of full supply, but some of that full supply comes from leases that are not long-term,” said Centennial Water and Sanitation District General Manager John Hendrick. “We want to add to our portfolio with long-term or near-permanent surface water sources…

Other SMWSA members committing to the project at this time are Cottonwood Water, Meridian Metropolitan District, Pinery Water, Rangeview Metropolitan District and Stonegate Village Metropolitan District. Hecox said he expects Dominion, Inverness, Castle Rock and Parker water districts to sign the IGA by the end of April. SMWSA members not expected to take part in the IGA include: Castle Pines Metro, Castle Pines North, East Cherry Creek Valley, and Arapahoe.

More WISE coverage here.

Flaming Gorge Task Force: ‘I felt we set the groundwork to move forward’ — Reed Dils


From The Pueblo Chieftain (Chris Woodka):

Colorado still needs to look at projects to bring in new water supplies despite a state water board’s decision last month to put the Flaming Gorge pipeline task force on ice. The Arkansas Basin Roundtable, the main proponent of the task force, still supports dialogue with other state roundtables on the subject and getting the statewide Interbasin Compact Committee to tackle the issue head­-on.

“It’s time we start looking at issues,” said Jeris Danielson, who represents the roundtable on the IBCC. The IBCC has adopted a “four­legged stool” that includes new supply along with identified projects, conservation and agricultural transfers.

The Colorado Water Conservation Board in January voted to suspend funding for the task force, saying the committee was duplicating work assigned to the IBCC. The group began its work in 2011 to determine issues surrounding two proposals to build water pipelines from southwestern Wyoming to Colorado’s Front Range.

“All of us thought the task force made good progress and had some good discussions on tough issues,” said Alan Hamel, who represents the Arkansas River basin on the CWCB. “Their thoughts will be folded into other work the CWCB is doing to move forward new­supply discussions.”

“I think the most important thing we did was establish a list of attributes for what constitutes a good project,” said Betty Konarski, a member of the task force.

“I felt we set the groundwork to move forward,” said Reed Dils, a task force member and former CWCB representative. “If we’re ever going to see another large project in the state, it will take the cooperation of all the roundtables.”

Roundtable Chairman Gary Barber, who also sat on the task force, said the group identified an immediate gap in agricultural water needs, and a municipal gap by 2020. It made no recommendation on whether or not to build a Flaming Gorge pipeline.

Danielson and Jay Winner, the other basin representative on the IBCC, vowed to press the IBCC to more action at its meeting in March.

More Flaming Gorge Task Force coverage here.

The CWCB plans to roll Flaming Gorge Pipeline analysis in with other IBCC reviews for transmountain diversions #coriver


Here’s an article from last week that deals with the demise of the Flaming Gorge Task Force. It ran in the Grand Junction Daily Sentinel and was written by Gary Harmon.

From The River Blog (Jessie Thomas-Blate):

Last year, American Rivers listed the Green River as #2 on our annual list of America’s Most Endangered Rivers®, due to the potential impact of this pipeline on the river, the recreation economy, and the water supply for the lower Colorado River Basin…

Recently, a coalition of 700 business owners called Protect the Flows commissioned a poll that found 84% of West Slope residents and 52% of metro Denver-area residents oppose building additional water pipelines across the mountains. In fact, 76% of Colorado residents think that the solution lies in using water in smarter and more efficient ways, with less waste…

The Green River is a paddler’s paradise. In May 2012, Steve Markle with O.A.R.S. told us why paddlers love the Green River so much. Then in August, Matt Rice, our Director of Colorado Conservation, told us about his trip fishing the Green, and the big trout, beautiful scenery, and solitude he found there. Finally, Scott Willoughby with the Denver Post gives a description of the river that makes you jealous if you don’t have easy access to this trout oasis (even if you aren’t an avid fisherman!).

It is no wonder so many people care about preserving adequate water flows in the Green River. It not only provides essential water and cash flow for West Slope towns, but also a great adventure for the citizens of Colorado and beyond.

More Flaming Gorge Pipeline coverage here and here.

CWCB: ‘Zombie Pipeline’ Takes Critical Wound in Vote — Jason Bane


From email from Western Resource Advocates (Jason Bane):

The Colorado Water Conservation Board (CWCB) today voted overwhelmingly to end funding for the ‘Flaming Gorge Task Force,’ which had been considering future large-scale water diversion projects such as the ‘Flaming Gorge Pipeline.’ The decision is in line with public opinion; a recent Colorado water poll found that four-in-five Colorado voters favor focusing on water conservation efforts rather than water diversions.

In response to today’s decision, Drew Beckwith, Water Policy Manager at Western Resource Advocates, issued the following statement:

“The Flaming Gorge Pipeline has been called the ‘zombie pipeline’ from years of lumbering around trying to latch onto anything that might keep it alive. Today’s CWCB vote sends a strong message that it’s time to move on to other water demand solutions. No amount of discussion is going to make the pipeline less expensive or more realistic, and we applaud the CWCB for recognizing the need to move forward.”

The ‘Flaming Gorge Pipeline’ (FGP) is a proposal to pump 81 million gallons of water a year across more than five hundred (500) miles from the Green River in Wyoming to the Front Range of Colorado—all at a projected cost of $9 billion dollars (according to CWCB calculations). Western Resource Advocates has consistently opposed the idea as unreasonable and unnecessary.

More coverage from Bob Berwyn writing for the Summit County Citizens Voice. Here’s an excerpt:

The task force funding drew criticism from conservation groups, who said the money would be better spent studying realistic conservation and reuse options for water. By some state estimates, the pipeline could have cost as much as $9 billion. The CWCB denied a request for $100,000 of state water money for continued study…

We applaud Governor Hickenlooper and the Colorado Water Conservation Board for their decision to turn down spending additional money to examine new water diversions as a solution to meet Colorado’s water challenges, said Protect Our Flows director Molly Mugglestone. “It’s the right decision for what Coloradans want as reflected overwhelmingly in a recent bipartisan poll commissioned by Protect the Flows.

The poll showed that more than 80 percent of Colorado voters would tell state officials to spend their time and resources focusing on conservation efforts, rather than water diversions; a majority of voters across political and geographic lines oppose building additional pipelines; and almost all express strong regard for Colorado rivers and a desire to protect them.

[Aaron Million] has said the pipeline could actually help protect flows in over-used sections of the Colorado, especially in years like this, with abundant moisture in Wyoming, but well below average snowpack in Colorado.

More Flaming Gorge Pipeline coverage here and here.

Flaming Gorge Task Force: ‘I guess neutral is a big win for us’ — Aaron Million


From The Pueblo Chieftain (Chris Woodka):

More state discussions are needed on how to develop Colorado’s share of Colorado River water, a task force that met for more than a year on the Flaming Gorge water project reported Wednesday. The task force did not recommend either building or denying the Flaming Gorge pipeline idea, and wasn’t expected to. Instead, it worked to create a framework that would bring competing interests to the table to evaluate any project proposing development of a new supply from the Colorado River. Its conclusions will be submitted to the Colorado Water Conservation Board, which funded the task force. “I guess neutral is a big win for us,” said Aaron Million, who was one of two sponsors of a Flaming Gorge pipeline who met with the task force last year.

More engineering work is being completed so that the Flaming Gorge project can be resubmitted to a federal agency for environmental evaluation. Million said it would be submitted to the Federal Energy Regulatory Commission, which rejected an application last year, saying more information was needed. If FERC does not accept the new proposal, either the Army Corps of Engineers or Bureau of Land Management would be approached.

The task force recommended the CWCB and Interbasin Compact Committee, an umbrella organization that represents the interests of basin roundtables and the state, develop a way to evaluate if a project meets certain criteria. The top priorities are developing Colorado’s share of the water under the 1922 Colorado River Compact and protecting the state from a call on the river that could diminish Colorado’s water supply.

The group recommended forming a committee that would continue to discuss issues relating to water and is asking the CWCB for up to $100,000 for phase 2 of the study. The first phase was funded at $72,000 in September 2011, over the objections of environmental groups who tried to kill any consideration of a Flaming Gorge plan.

More coverage from the Associated Press via the Laramie Boomerang. Here’s an excerpt:

In a report to be presented to the Colorado Water Conservation Board, the Basin Roundtable Exploration Committee said questions that should be addressed include not only financing and how Colorado can maximize its entitlements to Colorado River water without overdeveloping the river, but also alternatives to new water supply projects.

The committee said state leaders and each of the basin roundtables in Colorado should participate in the conversation, which it called a “key threshold step” needed to move beyond the status quo in developing significant new water supply solutions. The roundtables represent each major river basin in the state, plus the Denver area.

The report, released Wednesday, described an urgent need for action, citing the gap between the demand for water on the populated Front Range and the supply.

“The municipal gap on the Front Range is immediate, the dry-up of agriculture is real and certain, and the environmental and economic concerns are serious and numerous,” the report said.

The report also listed several characteristics of “good” water supply projects. For instance, they should have funding and minimize the need for new infrastructure, and they shouldn’t reduce supplies to existing water users, the report said.

Colorado’s river basin roundtables agreed to form the committee after entrepreneur Aaron Million announced a $3 billion pipeline proposal to carry Flaming Gorge Reservoir water to Colorado, and a separate coalition of water providers said it was exploring its own plan. The committee didn’t set out to endorse any proposal but wanted to answer questions about cost, feasibility, water rights and legalities, along with the environmental, socioeconomics, agricultural and recreational impacts of any Flaming Gorge project, among other issues.

Million has yet to gain permits for his project. He said Thursday his team is doing more engineering work after the Federal Energy Regulatory Commission last year dismissed his permit application over a lack of specifics.

More coverage from the Wyoming Business Journal (MJ Clark):

The committee is aware of protests by environmentalists and issues raised by their own constituency.

“Rather than focusing on a Flaming Gorge project, the committee is exploring what the attributes would be of any successful new transmountain diversion,” the group wrote. “And foremost to that discussion is dealing with the uncertainties of water availability under the Colorado River Compact.”

Noting that the staff could not reach an agreement of whether or not to endorse the project, the group concluded that, “At this point, we don’t see the benefit of having the Flaming Gorge Committee continue … unless the board directs otherwise, this will be the direction staff takes.”

More Flaming Gorge Task Force coverage here.

Flaming Gorge Task Force’s phase one report is hot off the press


Click here to view the report and appendices A through F. Click here for appendices G through I. Thanks to Heather Bergman for sending them along in email. Here’s an excerpt from the report:

Recommendations

In the course of its work, the Committee has come to more fully understand and appreciate the gravity and risks of the status quo and the need to develop new supply1 solutions that balance the current and future consumptive and nonconsumptive needs of both slopes and all basins. The municipal gap on the Front Range is immediate, the dry-up of agriculture is real and certain, and the environmental and economic concerns are serious and numerous. In the process of becoming informed about and discussing the benefits and costs of a specific new supply project focused around Flaming Gorge, the Committee has identified a key threshold step that must happen in order to move beyond the status quo in developing any significant new supply solution: an immediate and focused conversation with each roundtable and state leaders at the table must begin, aimed at developing an agreement or agreements around how water supply needs around the state can be met. Our conclusion and consensus is that the conversation needs to be transparent and inclusive in order to arrive at consensus agreements that can lead to meaningful statewide-level water supply solutions. The immediate need for this robust, focused, transparent, and balanced conversation is at the heart of each of our recommendations.

The Committee has developed a consensus flow chart that identifies threshold steps and a process framework for moving forward with major new supply allocation from the Colorado River. The flow chart and the process it outlines suggests a pathway to achieving statewide consensus for a new supply project, based on roundtables defining the scope of a project, the IBCC and CWCB providing insight and approval, and project proponents or participants designing a project based on statewide consensus about the criteria of what characteristics and components are needed to be included into the design, implementation, and operation of a water project for that project to be considered a “good” project for Colorado. The flow chart is based on several assumptions:

  • The goal is to minimize the risk of a Compact call.
  • An M&I gap exists and needs to be filled. Some of the water needed to fill that gap may come from the Colorado River. That portion of the gap that is not satisfied by identified projects or processes, conservation, or new supply will likely come from the change of agricultural water to municipal and industrial use.
  • The current legal framework will apply.
  • All roundtables are affected by a new supply project.
  • This process would be voluntary. An inability to complete the process (all STOP signs in the complete framework) means that proponents revert to “business-as-usual” for building a new project.
  • More coverage from KUGR News:

    A task force studying issues related to proposals to divert water from the Flaming Gorge Reservoir in Wyoming to Colorado says state leaders first need to agree on how Colorado’s water needs can be met. In a report to be presented to the Colorado Water Conservation Board, the Basin Roundtable Exploration Committee says questions that should be addressed include how Colorado can maximize its entitlements to Colorado River water without overdeveloping the river and who would finance a new water supply project. It also lists characteristics of “good” water supply projects, which it says shouldn’t reduce supplies to existing water users, for one. The report, released Wednesday, says there is an immediate gap between the Front Range demand for water and the supply and mentions “risks of the status quo.”

    More Flaming Gorge Task Force coverage here.

    Parker: ‘They don’t go dry out there’ — Ken Wright


    Back when Governor Hickenlooper was first on the scene as Mayor Hickenlooper he hosted a series about water at the Museum of Nature and Science. Ken Wright was on hand to introduce Frank Jaeger, the General Manager of the Parker Water and Sanitation District.

    “They don’t go dry out there,” said Wright. That’s the ultimate compliment for a water provider.

    Mr. Jaeger is now officially retired. Here’s report the Parker Chronicle (Chris Michlewicz):

    “I’ve always understood that I had a reputation, a sort of toughness. It intimidated people, and I let it intimidate some people when it was necessary for the benefit of the district,” he says. “If people want to denigrate me for that fact, I don’t care.”

    Despite departing earlier than expected — Jaeger frequently pledged to retire when he died, but was forced out after a change in board leadership — the 67-year-old is leaving with his head held high. He said he never compromised the integrity of the position and has “done all I can do for Parker Water.”

    At the recommendation of a neighbor, Jaeger joined the board of directors for the fledgling, financially troubled PWSD in 1981. He soon became its manager and was instrumental in turning around a district that was headed in the wrong direction. Since that time, Jaeger has slowly built up the district’s infrastructure, received permission to divert excess flows from Cherry Creek, and got public authorization to build Rueter-Hess Reservoir, which at the time was the first federally approved off-stream reservoir in more than 20 years.

    Jaeger, of Elizabeth, plans to enjoy his retirement by golfing (without keeping score), hunting, fishing and taking vacations with his wife, but will continue to offer guidance on water issues that affect Colorado. He is a lifetime member of the Colorado Water Congress and will regularly visit the Capitol to review the merits of proposed legislation.

    “They know I won’t be silent and will give honest opinions,” he said.

    More Parker coverage here.

    The Flaming Gorge Task Force October meeting summary is hot off the press


    Click here to read a copy.

    More Flaming Gorge Task force coverage here.

    Castle Rock: Assistant utilities director Rick Wilkey will take over in the interim for Ron Redd


    From the Castle Rock News-Press (Rhonda Moore):

    The Town of Castle Rock has announced an interim utilities director to replace Ron Redd, who leaves the department after 11 years at the helm. Assistant utilities director Rick Wilkey will replace Redd when Redd leaves Castle Rock Dec. 12. Redd will replace Frank Jaeger as district manager of the Parker Water and Sanitation District.

    More South Platte River Basin coverage here.

    Ron Redd named as the new manager for the Parker Water and Sanitation District


    From the Parker Chronicle (Chris Michlewicz):

    Ron Redd, the longtime utilities director for Castle Rock, was named during a meeting Nov. 15 as the replacement for Frank Jaeger, who has served as district manager for more than 30 years. Redd was present for many of the water district’s most recent notable accomplishments, including the opening of Rueter-Hess Reservoir and Dam. Redd was among the main players in Castle Rock’s agreement to purchase $40 million worth of water storage space in Rueter-Hess, making the town the PWSD’s largest partner on the expansion of the reservoir…

    Wasserman pointed out that certain perks that have come with the district manager’s position in the past will no longer be in place, such as free gas. Jaeger drives a GMC Denali that’s owned by the district, one of the points of contention when the new board members were elected. Redd, who starts his job in early January, will get a $500-a-month auto allowance, along with his $150,500 annual salary.

    Will Mr. Redd take over Mr. Jaeger’s duties with the Colorado Wyoming Cooperative Water Supply Project?.

    More Parker coverage here and here.

    Salida: Flaming Gorge Task Force meeting Tuesday


    Click here for a copy of the agenda. Thanks to Heather Bergman for sending it along in email.

    More Flaming Gorge Task Force coverage here.

    The Sterling Ranch development signs up for WISE Project infrastructure and water supplies


    From the Castle Rock News (Rhonda Moore):

    Sterling Ranch managing director Harold Smethills announced a deal with Aurora Water that will deliver 88 million gallons of water already owned by the development’s provider, Dominion Water. The deal paves the way for Sterling Ranch to begin the plat process with Douglas County as the development moves forward, Smethills said.

    At the same time, Sterling Ranch signed a second deal with Aurora Water in a 15-year lease for 186 million gallons of water as a sub-agreement of the Water Infrastructure and Supply Efficiency agreement, said Greg Baker, manager of Aurora Water public relations…

    Sterling Ranch aims to begin its development process before year’s end and hopes to enter the market as quickly as possible, Smethills said. He hopes to debut Sterling Ranch, a planned development approved for more than 12,000 homes over its 20-year planned build-out, with as many as 2,000 homes in its early phases. “This gets us in the market years before we could have built our infrastructure because the demand is here now,” Smethills said.

    More Sterling Ranch coverage here.

    Parker Water and Sanitation: ‘To cut from the budget without understanding what they’re doing is short-sighted’ — Mary Spencer


    From the Parker Chronicle (Chris Michlewicz):

    Mary Spencer, who was elected to the board of directors in 2006, sent a resignation letter to district manager Frank Jaeger June 29 that highlighted her growing frustration with the board…

    When reached by phone July 16, Spencer said she became tired of her colleagues blaming past boards for a range of issues. Dissenters and “two sitting board members have made a disastrous decision to destroy not only the district but the reputations of past board members,” the letter said…

    During the interview, Spencer also sharply criticized a recent decision to fire the water provider’s longtime lobbyists, whom she says have helped kill legislation that would have cost the district, and therefore ratepayers, millions of dollars. Spencer said the $48,000 that was paid annually to the lobbyists was well worth it. She also bemoaned the recent firing of Floyd Ciruli, a public relations specialist and political analyst who was contracted by the PWSD…

    Spencer, whose term was set to expire in May 2014, said the decision to leave was difficult because she still believes in the district’s mission, but it was “not worth the stress” to deal with the fallout from the attempted board recall in 2009 and subsequent conduct that has had a “detrimental” affect on the water district.

    More Parker coverage here and here.

    Douglas County forms a water and wastewater enterprise to fund infrastructure for renewable supplies


    From the Castle Rock News Press (Rhonda Moore):

    The board of county commissioners on July 10 established the Douglas County water and wastewater enterprise, opening the door to bring money to the table for long-term water development. The enterprise allows the county to issue revenue bonds secured by future revenues from water providers who pass muster, said Lance Ingalls, county attorney. The enterprise, through state statute, allows the county to issue the revenue bonds to qualifying providers on a project-by-project basis, Ingalls said…

    The authority was focused primarily on advancing the water infrastructure and supply efficiency project that is pivotal to filling the Rueter-Hess reservoir, said Eric Hecox, authority spokesman…

    “This enterprise is opening the door for the county to be a catalyst for partnership to meet our renewable water needs,” Hecox said. “Having a partner as big a player as the county gives us the opportunity to meet our regional long term challenges.”

    The strength of the county’s borrowing power bumps the water game up a notch in Douglas County, said Jill Repella, commissioner, District 2. Repella was part of the conversations with providers who made it clear the county’s role is critical to the success of any effort toward bringing long-term water to Douglas County.

    More infrastructure coverage here.

    Flaming Gorge Task Force: Mixed views towards the feasibility of building the pipeline


    From the Fort Collins Coloradoan (Bobby Magill):

    On Friday, a task force of water interests from across Colorado charged to look into the feasibility of tapping the Green River met in Colorado Springs to discuss whether it’s possible or desirable to build a Flaming Gorge pipeline. While some on the task force said building a massive pipeline from western Wyoming to the Front Range would help restore the headwaters of the Colorado River while also preventing eastern Colorado farms from going dry, others were adamant that a Flaming Gorge pipeline is, at best, a project that could cause more strife than anything else…

    “There’s been no real analysis of the environmental impacts,” [Chuck Wanner of Colorado Trout Unlimited] said, adding that he doesn’t believe that it’s possible for the task force to fully assess the feasibility of a Flaming Gorge pipeline by the end of the year.

    Whatever project the state decides to build to bring more water to the Front Range, Colorado must tap all the Colorado River Basin water the state is entitled to, including Green River water, said Eric Wilkinson, general manager of Northern Water in Berthoud. That project, whether it’s a Flaming Gorge pipeline or something else, has to maximize currently-available infrastructure, and the proposed pipeline accomplishes that by using the Interstate 80 corridor in Wyoming, he said…

    “The most important issue in this is whether or not a project unites the state,” said T. Wright Dickinson, a Brown’s Park rancher and former Moffat County commissioner. He said a Flaming Gorge pipeline as it is being envisioned would be too divisive to be built, doesn’t address what happens when Western Slope farmers need more water and isn’t adequate to address the state’s long-term water needs. Dickinson suggested an even bigger project: Tapping the Mississippi or Missouri rivers with a massive westbound pipeline…

    The task force will meet once each month through December before making a final recommendation to state water regulators in January.

    More Flaming Gorge Task Force coverage here.

    IBCC: Next Flaming Gorge Task Force meeting Friday in Colorado Springs


    From email from Peak Facilitation Group (Heather Bergman):

    …please find the agenda for Friday’s meeting of the Basin Roundtable Project Exploration Committee: Flaming Gorge. The meeting will be held from 10 am to 3 pm at the Pikes Peak Regional Council of Governments offices in Colorado Springs (15 S. 7th St..).

    More Flaming Gorge Task Force coverage here.

    The Parker Water and Sanitation District board decides to keep Frank Jaeger on the payroll through the transition to his retirement this fall


    From the Parker Chronicle (Chris Michlewicz):

    Even before the Pledge of Allegiance was recited by the approximately 60 people in attendance at the Parker Water and Sanitation District meeting May 31, chairwoman Darcy Beard announced that the board would be retaining Jaeger indefinitely to ensure a smooth transition to new leadership.

    Just two weeks ago, Jaeger said he believed his days as district manager were numbered. Three new board members were elected May 8 after running on a platform that promised a change in spending habits, transparency and planning. At the five-member board’s first meeting May 17, they stripped management of their ability to sign checks, but stopped short of discontinuing Jaeger’s contract for fear of losing the person with the most intimate knowledge of district operations and plans. The tone early on at the May 31 meeting was conciliatory as Beard cited Jaeger’s “dedication and vision” for making the district one of the more respected water providers in the state. Beard also apologized because she was told that Jaeger “felt my criticism was directed to him personally” during comments she made at the May 17 meeting.

    Jaeger, who has been at the helm of the PWSD for 31 years, wrote a letter to the board that expressed his willingness to pass on his knowledge during an “orderly and well-thought-out” transition period. Jaeger said he wants to schedule a full-day learning session to catch the new board members up to speed on reasons behind water planning policies and update them on growing concerns about the cost of treating wastewater.

    More Parker coverage here.

    Flaming Gorge Pipeline: Protect the Flows asks Governor Hickenlooper to put the kibosh on the project


    Here’s the release from Protect the Flows.

    118 West Slope businesses sent a letter this morning to Colorado Governor John Hickenlooper, expressing their opposition to the proposed Flaming Gorge pipeline. The businesses are members of Protect the Flows, a coalition of over 500 small business owners in the seven state Colorado River region (AZ, CA, CO, NM, NM, UT, WY) who depend upon flows in the Colorado River and its tributaries that are adequate to support the recreation economy.

    In the letter…Protect the Flows asks that the administration cease devoting state resources to studying the Flaming Gorge pipeline upon conclusion of the state’s special task force examining the project’s feasibility. As the task force has deliberated, troubling facts about the pipeline have continued to emerge, opposition to the pipeline has continued to grow, and federal agencies have continued to deny all permit attempts for the pipeline. Protect the Flows indicated that they would welcome a dialogue on water that welcomes and fosters ideas beyond the proposed pipeline and adequately accounts for the economic interests of the recreation and tourism industry. The task force, known formally as the Basin Roundtable Project Exploration Committee, is funded by a state grant issued by the Colorado Water Conservation Board and is scheduled to continue discussions through the end of 2012.

    “The state’s task force is focused only on one increasingly controversial idea — the Flaming Gorge pipeline proposal,” said Molly Mugglestone, Coordinator for Protect the Flows. “But to come up with the most effective solutions on future water usage we must apply a broader, more inclusive framework, like the one that was applied in achieving the newly completed agreement between Denver Water and West Slope interests.”

    Protect the Flows recently released a report showing that the Colorado River and its tributaries support a quarter million American jobs and generates $26 billion annually in total economic output. In Colorado alone, the Colorado River supports about 80,000 jobs and about $9.6 billion in total economic output.

    The proposed Flaming Gorge pipeline puts that economy in harm’s way. The plan would siphon 80 billion gallons each year from the Green River (a Colorado River tributary), which was recently declared the second most endangered river in America by American Rivers, for shipment to the Front Range. Moreover, the State of Colorado estimates that construction costs for the pipeline could reach $9 billion. An economic study by Western Resource Advocates indicated that the pipeline would take nearly a quarter of the Green River’s flow, which would result in a $58.5 million dollar annual loss to the region’s recreation economy. That same study reported that the water delivered to the Front Range by the pipeline would have to be sold at a price that is the most expensive in Colorado’s history (up to 10 times more than any existing project) because of the pipeline’s steep construction and operation costs.

    “Construction of this pipeline would be devastating to the entire Colorado River System,” said Tom Kleinschnitz, President of Adventure Bound River Expeditions in Grand Junction, which employs 30 people. “The significant loss of flows in the Green River would dramatically impact the quality of river recreation and affect tourism for everyone downstream all the way to Mexico.”

    Protect the Flows has committed to spend 2012 reminding Governor Hickenlooper and state officials that public resources would be better spent on more affordable solutions that support recreation industry jobs, such as improving water conservation efforts, water reuse and recycling, and better land-use planning and growth management.

    More Flaming Gorge Pipeline coverage here and here.

    ‘The Flaming Gorge Pipeline has been rejected more often than a freshman before prom’ — Stacy Tellinghuisen (Western Resource Advocates)


    It looks like Aaron Million will have to pony up the big bucks for engineering and attorney’s fees to flesh out his application with the Federal Energy Regulatory Commission. Here’s a report from Ben Neary writing for the Associated Press via the Fremont County Ranger. From the article:

    The Federal Energy Regulatory Commission on Thursday refused a request from Aaron Million of Fort Collins, Colo., to reconsider its February denial of his permit. In denying Million’s application in February, FERC said it was premature and lacked specifics about the proposed pipeline…

    His plans have drawn opposition from Gov. Matt Mead as well as county and local governments in southwestern Wyoming and downstream states. “I continue to oppose this particular proposal and continue to believe that FERC is not the regulatory body to review Mr. Million’s proposal,” Mead said Thursday. “I am glad that FERC denied the request for a rehearing.”[…]

    “We anticipated that they would not change the direction from the original response, part of the request frankly had to do with a clarification of issues related to their original decision,” Million said. “And indeed, they did clarify several things, and we now understand the rationale, in essence. They said the application was too broad.”

    From The Denver Post (Bruce Finley):

    Million’s company, Wyco Power and Water Inc., “presented no information in its permit application or its request for rehearing to indicate that the planning, routing or authorizations for the water conveyance pipeline are in progress or reasonably foreseeable,” FERC’s order said. Until Wyco can do that, the order said, there’s no point in issuing a preliminary permit…

    Million said he expected this rejection and learned from the process. “They need some more specifics,” he said, estimating $5 million has been invested so far. “We’re pushing ahead. FERC will be involved at some point because they permit hydropower.”

    From the Colorado Independent (Troy Hooper):

    FERC deemed the application from Million’s company, Wyco Power and Water Inc., inadequate in February but Wyco returned the next month asking the agency to reconsider. “We are not persuaded by any of Wyco’s unsupported arguments that it should be issued a preliminary permit for its proposed Regional Watershed Supply Project,” the commissioners wrote in their decision. “Therefore, we affirm the February 23 Order and deny Wyco’s request for rehearing.”

    Here’s a release from Western Resource Advocates (Jason Bane):

    The Federal Energy Regulatory Commission (FERC) today re-affirmed its decision to deny a rehearing on a preliminary permit application for the Flaming Gorge Pipeline. This is now the third time (in less than a year) that a federal agency has rejected plans for the Flaming Gorge Pipeline.

    “The Flaming Gorge Pipeline has been rejected more often than a freshman before prom,” said Stacy Tellinghuisen, Water & Energy Policy Analyst at Western Resource Advocates. “It doesn’t matter how you try to alter the proposal, or whose name is on top. You can change the wording. You can change the font. You can print it on a different color paper. It’s still too expensive, too harmful to the environment, and just not necessary for meeting future water demands.”

    In July 2011, the U.S. Army Corps of Engineers terminated its review of the pipeline proposal, prompting Million to shift his application request to FERC. On February 23, 2012 FERC denied a preliminary permit application for the pipeline proposal, and on March 23 Million requested a “rehearing and clarification.” In a decision released this morning, FERC stated:

    We are not persuaded by any of Wyco’s unsupported arguments that it should be issued a preliminary permit for its proposed Regional Watershed Supply Project. Therefore, we affirm the February 23 Order and deny Wyco’s request for rehearing.

    Said Robert Harris, Staff Attorney with Western Resource Advocates: “Enough is enough. This is a strong signal to the State of Colorado to focus more time and attention on proposals that — unlike the Pipeline — are more ripe for serious consideration.”

    Million had been seeking a federal permit from FERC to review his ‘Flaming Gorge Pipeline’ (FGP) proposal to pump 81 billion gallons of water a year for more than five hundred (500) miles from the Green River in Wyoming to the Front Range of Colorado—all at a projected cost of $9 billion dollars (according to CWCB calculations). Western Resource Advocates (WRA) filed objections to the application in representing itself, the National Parks Conservation Association (NPCA) and the Colorado Environmental Coalition (CEC); in total, more than 5,000 objections were filed in December 2011 to Wyco’s proposal.

    Opposition to the Flaming Gorge Pipeline has continued to grow since December. Wyoming Gov. Matt Mead has formally objected to the proposal, as have numerous local governments in both Colorado and Wyoming (such as Grand Junction, CO and Laramie, WY).

    Here’s a release from Earth Justice (McChrystie Adams):

    Today, the Federal Energy Regulatory Commission (FERC) closed the door on what will hopefully be the last attempt to permit the Flaming Gorge Pipeline. FERC denied a request for rehearing from Aaron Million’s company, Wyco Power and Water, Inc.—an attempted “do-over” on FERC’s earlier denial of a preliminary permit. The Colorado developer has spent several years, and a claimed $5 million, attempting to launch this ill-conceived boondoggle. His proposal has been met with stiff opposition from conservation groups, individuals, and local communities and businesses. Now, FERC has provided a point-by-point refutation of Wyco’s application and rehearing request, and left no doubt that this pipeline remains a pipe dream.

    FERC’s order recognized that the Flaming Gorge Pipeline proposal is poorly defined, and the approval process would be “difficult and lengthy” due to the opposition and controversy surrounding the project. As a result, FERC states that it would be premature to issue the permit for the project at this time. Importantly, FERC also made clear that it would not license the entire 501-mile water conveyance project. FERC is now the second agency to reject Mr. Million’s attempts to review and approve the Pipeline, following the Army Corps of Engineers’ termination of its review of the project in 2011.

    McCrystie Adams, staff attorney for Earthjustice, had the following statement on FERC’s action:

    “The Flaming Gorge Pipeline would be one of the biggest, most expensive, most environmentally damaging water projects in the history of the western United States. FERC got it right when they dismissed the permit application, and got it right again today when they denied Mr. Million’s rehearing request. We hope this will finally put an end to Mr. Million’s attempt to profit at the expense of one of the West’s last great rivers and the fish and wildlife, as well as the local economies, which depend on it.

    “This project—and any similar, large-scale transbasin diversions—is the worst way to meet Colorado’s water challenges. Such a project is unnecessary and distracts us from the important work we must do to build a secure water future. Unfortunately, we cannot be confident that this project is dead until Mr. Million and those who might follow his path abandon this futile scheme. We will continue to work to ensure that the Green River is protected and that this and other assaults on the West’s rivers do not succeed.”

    The Flaming Gorge Pipeline is a massive transbasin water supply project that would annually take approximately 81 billion gallons (250,000 acre-feet) of water from the Flaming Gorge Reservoir and the Green River and pipe it more than 500 miles over the Continental Divide to Colorado’s Front Range and southeastern Wyoming. This diversion would have devastating impacts on the native fish and wildlife in the Green and Colorado Rivers, batter regional recreational opportunities and jobs that depend on river flows, and potentially be a fatal blow to one of the West’s last great rivers. The plight of the Green River and the impacts of the proposed Flaming Gorge Pipeline were highlighted this week when American Rivers declared it #2 on its list of “most endangered rivers” in the United States.

    After an attempt at permitting through the Army Corps of Engineers was rejected last year, Aaron Million’s new company Wyco Power and Water, Inc. turned to the FERC. In February, FERC, acting well within its discretion and following its governing regulations, dismissed Wyco’s preliminary permit application as “premature.”

    FERC, in its review of the preliminary permit application, rightly found that Wyco would be unable to gain the many authorizations and the design certainty necessary to file a license application within the three year permit term. Again failing to take “no” for an answer, Wyco then requested a rehearing, yet failed to provide any meaningful evidence or arguments that FERC got it wrong the first time. FERC’s ruling today upheld its earlier finding and left it clear that Wyco’s application is without merit.

    Earthjustice had intervened in FERC’s preliminary permit review and filed papers urging the agency to deny the rehearing request. Earthjustice represents a coalition of ten conservation groups with interests throughout the Colorado River Basin: Sierra Club, Center for Biological Diversity, Rocky Mountain Wild, Save the Poudre: Poudre Waterkeeper, Biodiversity Conservation Alliance, Wyoming Outdoor Council, Citizens for Dixie’s Future, Glen Canyon Institute, Living Rivers: Colorado Riverkeeper, and Utah Rivers Council.

    From the Summit County Citizens Voice (Bob Berwyn):

    The controversial Flaming Gorge pipeline (formally known as the regional water supply project) was initially under review by the U.S. Army Corps of Engineers, but partway through that process, proponent Aaron Million switched gears and asked the Federal Regulatory Energy Commission to review the proposal as an energy generating project.

    FERC rejected the application once and Million subsequently appealed that decision under an administrative procedure. This week’s FERC ruled denies his appeal and appears to put the project on hold, at least for now.
    The proposal garnered widespread opposition from businesses that rely on recreational flows in regional rivers and streams, collectively represented by Protect the Flows.

    “The thousands of people in our region whose jobs depend upon a strong Colorado River system dodged another bullet today, but it’s time to move beyond this threat once and for all,” said the group’s coordinator, Molly Mugglestone. “Enough time and public money has been spent fixating on this one controversial idea, it’s time to bring people together to come up with a smarter way forward.”

    From the Fort Collins Coloradoan (Bobby Magill):

    FERC spokeswoman Celeste Miller said in a statement Thursday that the order “confirms that it is premature to issue Wyco a preliminary permit for its seven proposed hydropower developments.”

    Miller said Wyco presented no information in its permit application or its appeal to show that Wyco has permission from landowners to build the pipeline across their property.

    “Until Wyco is able to do so, there is no point in issuing a preliminary permit for the hydropower developments because Wyco would be unable to study the feasibility of, and prepare a license application for, a project whose location has not been sufficiently narrowed,” the statement said.

    From KSL.com (Amy Joi O’Donoghue):

    The application for Wyco to study the feasibility of the pipeline — described officially as the Regional Watershed Supply Project — lacked concrete information such as the route or if any authorizations from land managers had been sought, according to the FERC decision. Also incomplete were details about the locations of its proposed hydropower stations. Aaron Million, a Fort Collins, Colo., entrepreneur who is pushing the project, said trying to provide that kind of detail this early in the process is premature — it needs more research…

    Wyco has 60 days to file an appeal of Thursday’s decision with the U.S. Circuit Court of Appeals.

    From the Northern Colorado Business Report (Steve Lynn):

    Million on Friday said the latest ruling has given his team a better understanding of what it must include in its formal application. “We’ll address the issues and keep heading through the permitting process,” he said.

    Large engineering construction firms involved in the project remain interested, he added. He declined to name them, citing confidentiality agreements. The pipeline would help meet the water needs of Colorado, which faces a water supply shortfall, Million said. It also would bolster flows in the Poudre River.

    Finally, Chris Woodka talked to Aaron Million. The entrepreneur remains focused, according to Mr. Woodka’s report. From the article:

    “We plan to move forward and will submit a more complete application,” Million said. He added that he is continuing to secure financing for the project.

    More Flaming Gorge Pipeline coverage here and here.

    Parker: Frank Jaeger retires, 9News exposé contributes to board angst over his continued employment


    From The Parker Chronicle (Chris Michlewicz):

    Frank Jaeger, the Parker Water and Sanitation District’s general manager for 31 years, announced his plans to retire at the end of his contract in December, but some of the newly elected directors proposed immediately terminating his contract, just hours after they were sworn in May 17.

    However, following a discussion about the advantages and disadvantages of losing the person with the most extensive knowledge of the water district’s history and operations, the board members decided to rescind the resolution to fire Jaeger.

    A special executive session, which enables the board to privately discuss sensitive matters, is tentatively scheduled for May 21. Jaeger, who was reached at his office by phone a day after the May 17 meeting, believes the board will likely terminate his contract…

    But Wasserman acknowledged that the board might have acted too hastily with the proposal to terminate Jaeger’s contract. He commended what he calls Jaeger’s “far-sighted” decision to build Rueter-Hess Reservoir, but says the project got too costly and out of control.

    Jaeger, who makes no apologies for his blunt manner of speaking, said he has been unfairly targeted by the new board, the media and members of the public, despite what he sees as 31 years of devotion to “doing what’s best for our customers.”

    Dozens of people attended the May 17 meeting, including Parker Water and Sanitation District employees, who were curious about what would happen to the man who has served as their general manager and been with the district longer than anyone else. Wasserman said it was “understandable” that they might be concerned and said they have no reason to fear losing their jobs.

    From 9News.com:

    Frank Jaeger has managed the Parker Water and Sanitation District since 1981. 9Wants to Know recently revealed that he and other managers were using government credit cards to pay for vehicle upgrades, numerous lunch meetings, and trips for conferences in places like Las Vegas and Florida. These expenses came as the district raised water rates for Parker residents.

    Thursday night, Jaeger announced his retirement, but the new board members still proposed to terminate his contract, effective on Friday…

    9Wants to Know found he and other managers had expenses like:

    • $892 spent on new rims for the District Manager’s Yukon Denali
    • Among dozens of car washes, sometimes several in a week, $560 was spent on a detail job for the District Manager’s Yukon Denali
    • $6,000 spent on 127 lunch meetings attended by water managers, consultants and lawmakers at places like the Brown Palace Hotel.
    • $20,000 spent on trips to Las Vegas, Florida and Washington D.C. for conferences
    • $1,925 paid to marketing consultants to write board member bios

    Jaeger defended those expenses as the cost of doing business and keeping up a clean image for the water utility.

    I wonder if Mr. Jaeger still plans to be the driving force behind the Colorado Wyoming Coalition’s version of the Flaming Gorge Pipeline?

    More Parker coverage here and here.

    Parker: The quest for a sustainable water supply leads to political fallout over Rueter-Hess Reservoir and water rights purchases


    From the Parker Chronicle (Chris Michlewicz):

    Tracy Hutchins, who served on Parker Town Council for eight years, has turned her attention to what she believes is negligence by the water district’s top authorities. She is decrying, among other dealings, the $7.7 million investment in farms and water rights in the Sterling area because she says the district has no way to transport the water back to Rueter-Hess Reservoir, a $105 million project that PWSD officials say is vital for storing water for Douglas County’s future. Instead of relying on underground aquifers that are rapidly being depleted, Parker Water planned Rueter-Hess as a mechanism to store water from wet years for use during times of drought. PWSD customers voted in 2004 to approve a bond issue that would use tap fees from ongoing development to pay for the reservoir construction. Hutchins says many Parker residents don’t know that when the real estate market crashed, the ratepayers were suddenly on the hook for the tab, which now stands at $97 million.

    “In the bond election, we said we would use all means and methods necessary, including a tax increase in the event we could not make payments,” said Jim Nikkel, project manager and assistant district manager for PWSD. The quasi-governmental agency raised its mill levy for the 2011 tax year. Nikkel says water rate increases offset rising utility costs and don’t pay for the reservoir debt.

    Hutchins says poor planning has saddled Parker’s water customers with debt, and the reservoir, which was officially opened in March, has only a puddle of water in it.

    More Parker coverage here and here.

    How would the State Engineer administer diversions with respect to the Flaming Gorge pipeline?


    From The Pueblo Chieftain (Chris Woodka):

    “I just laid out the options we have if either Flaming Gorge plan were to move forward,” State Engineer Dick Wolfe said following a meeting last week of the Flaming Gorge Task Force in Grand Junction. The options include special legislation to cover bringing water from outside the state, an agreement between the states or state rules on water imports…

    Wolfe is concerned that a pipeline could inadvertently injure Colorado water rights. Prompted by Million’s plan, Wolfe talked to the Colorado legislative interim committee on water resources last year about the possibility of legislation…

    Colorado already has agreements with Wyoming and Utah on how to administer specific rights that cross state lines. Those involve smaller quantities of water than Flaming Gorge would divert, and neither targets a specific water right. Under an agreement, Colorado would be able to ask Wyoming to curtail diversions if they threatened rights on the Colorado River within Colorado. There could also be impacts to the Colorado River Compact, among seven states, that could affect Flaming Gorge diversions. “We don’t want Wyoming making judgments on how much water we have left to develop under the compact,” Wolfe said…

    “It would involve a very public process, and would create the conditions for importing water,” Wolfe said. “Right now we have no venue to do that.”

    More Flaming Gorge Pipeline coverage here and here.

    Flaming Gorge pipeline: FERC is reviewing Wyco Water and Power’s request for a rehearing for the project’s preliminary permit


    From Chris Woodka writing for The Pueblo Chieftain. From the article:

    The Federal Energy Regulatory Commission filed a notice Monday saying it needs more time to study a request for a rehearing filed by Aaron Million’s Wyco Power and Water Co.
    While notice was titled “Order Granting Rehearing for Further Consideration,” it did not in fact approve a rehearing on the entire pipeline project, FERC spokeswoman Celeste Miller said [ed. emphasis mine]…

    “All the notice meant was that the commission needed additional time to consider the rehearing request. If there was no action, the request would have been denied,” Miller said. “The commission is still reviewing the request.”

    From the Northern Colorado Business Report (Mark Wilcox):

    The rehearing comes despite multiple protests from environmentalist groups, the Wyoming Game and Fish Department, the U.S. Forest Service, Sweetwater County, Colorado Springs Utilities and others. Opponents claim it would damage the ecosystem surrounding Flaming Gorge, thereby damaging the $118 million local outdoor economy.

    In his rehearing request, Million invoked the approved, 139-mile Lake Powell Pipeline, which will cost $1.064 billion and be finished in 2020. He said his preliminary proposal was similar to the Lake Powell Pipeline, but while Lake Powell got a green light, Million’s Wyco Power and Water Inc. was stopped on red.

    “The commission’s order implies that the final pipeline alignment, all authorizations to construct the pipeline and even the construction of the pipeline should be completed prior to filing an application for a preliminary permit” Million’s rehearing request said.

    More Flaming Gorge pipeline coverage here and here.

    Flaming Gorge pipeline: FERC grants a rehearing for the project’s preliminary permit


    Update: FERC did not grant a request for a rehearing. They need more time to review the request.

    From The Pueblo Chieftain (Chris Woodka):

    The Federal Energy Regulatory Commission announced Monday it will grant a rehearing for Aaron Million’s Wyco Power and Water Co., over the objections of environmental groups and Colorado Springs Utilities…

    Among those opposing the rehearing were the Colorado Environmental Coalition, the National Parks Conservation Association, Western Resource Advocates and the Sierra Club.

    Colorado Springs Utilities on April 6 filed a motion asking FERC to exclude consideration of a reservoir in El Paso County at the same site where it plans to build a reservoir for the Southern Delivery System. The Norris family, owners of T-Cross Ranches, are family friends of Million. They have filed an application with El Paso County for the Marlborough Metropolitan District with the intention of building a regional reservoir on Upper Williams Creek, southeast of Colorado Springs.

    Million also could have competition in building the pipeline from the Colorado-Wyoming Coalition, led by Frank Jaeger, manager of Parker Water, which is studying its own plan for a Flaming Gorge Pipeline.

    Meanwhile, a state task force continues to meet to identify issues that could arise if either project is built. Its next meeting is Wednesday in Grand Junction.

    Here’s the agenda for the next task force meeting via email from the IBCC facilitator.

    More Flaming Gorge pipeline coverage here and here.

    Flaming Gorge pipeline: The Garfield County Commissioners go on record opposing the project


    From the Glenwood Springs Post Independent (John Stroud):

    …the decision to oppose the proposed 560-mile-long Flaming Gorge pipeline was not a unanimous one. The Garfield Board of County Commissioners voted 2-1 Monday to take the position against the controversial project. Commissioner Tom Jankovsky said that, although philosophically opposed to Front Range water diversions, it’s too early in the process for the county to be taking a position on the controversial project…

    But Commissioners Mike Samson and John Martin disagreed.

    Samson has been pushing for the county to take a stance against the project, as other Western Slope governments, water users and conservation groups have done. “We can’t continue to give West Slope water to Eastern Slope entities,” Samson said. “Enough is enough.

    “I’m looking down the road to our future needs,” he said. “Western Colorado will grow and expand, and we will need that water. And once it’s over there, there’s no way to get it back.”[…]

    Garfield County’s resolution opposing the project questions the costs for the project, as well as the potential threats to the western Colorado and other downstream water users on the west side of the Continental Divide. “The Flaming Gorge pipeline is not feasible without subsidies, with some estimates suggesting that the project would need as much as $370 million in state or federal subsidies,” the resolution states.

    “Garfield County urges Colorado water leaders and policymakers to devote the state’s attention and financial resources on water projects and programs that are cost-effective and that do not pit one region of the state against the others,” it concludes.

    More Flaming Gorge pipeline coverage here and here.

    Parker: Rueter-Hess Reservoir is complete, just add water


    Here’s the announcement from the Parker Water and Sanitation District website:

    What does it take to construct a 72,000 acre-foot reservoir on Colorado’s crowded Front Range during years of belt-tightening and competition for scarce water resources? It takes 25 years of managing complex planning, permitting and construction projects, and more importantly, it takes the vision and tenacity of the water district managers in charge. In Parker, all these elements coalesced to complete Rueter-Hess Reservoir – the first major water storage facility on the Front Range in several decades.

    Parker Water celebrated the completion of the massive Rueter-Hess Reservoir project on March 21st with more than 100 contractors, metro water partners and government officials in attendance on the tower of the Frank Jaeger Dam.

    John Stulp, special policy advisor on water issues to Governor Hickenlooper, commended Parker Water and its partners in Douglas County for collaborating on a forward-looking project that will be needed as Colorado gains an estimated 4-5 million residents over the next 30-40 years.

    Colorado State Senator Ted Harvey read a resolution adopted unanimously by both houses of the legislature the previous day, congratulating Parker Water on its foresight and persistence in planning and constructing Rueter-Hess Reservoir. Senator Harvey said, “We can’t bring in good companies to Douglas County and create jobs if we don’t have the needed resources to serve them. Rueter-Hess is a key part of that.”

    The Douglas County Commission also adopted a resolution of congratulations for 50 years of service to customers in Douglas County. County commissioners Jack Hilbert and Jill Repella specifically cited the cooperation that led communities to work together on Rueter-Hess Reservoir.

    To culminate the ceremony, the PWSD Board Members in attendance: Mary Spencer, Sheppard Root, Mike Casey and Darcy Beard, activated the release of water stored in the nearby Cherry Creek diversion structure into the reservoir. The crowd applauded as a remote camera captured the water flowing from the outlet into the south side of the reservoir.

    Already, Rueter-Hess Reservoir holds some 4,000 acre-feet of water from flows captured in the reservoir beginning in May 2011 – enough water to serve 9,000 homes over the course of a year. The Douglas County water districts partnering in the reservoir, including the Town of Castle Rock, Castle Pines North, and Stonegate, will continue to capture storm runoff and reuse water, and plan to develop additional surface-water sources in the future.

    More coverage from Clayton Wouliard writing for YourHub.com. From the article:

    A completion ceremony was held March 21 by Parker Water and Sanitation, which paid for the construction of the reservoir that can hold 72,000 acre feet of water. The dam for it cost about $135 million, with a total cost of the project at about $200 million, including an environmental impact study, pumps and legal work, according to Jim Nikkel, assistant manager of Parker Water and Sanitation. The project was funded through a general obligation bond approved by voters in 2002.

    “It’s the first of a long process of ensuring the area of northern Douglas County has sustainable water for now and in the future,” Nikkel said.

    Nikkel said a water treatment plant is currently being built for $50 million that is slated to be finished by summer 2014 and will treat water from the reservoir. Currently, Parker gets its water from aquifers, which are not renewable. The treatment plant construction is being funded through revenue bonds and will process up to 10 million gallons per day, Nikkel said.

    More Rueter-Hess Reservoir coverage here and here.

    Flaming Gorge pipeline: Earthjustice, et al. to FERC — ‘No’ should mean no to do-over for preliminary permit


    From the Earthjustice blog (Doug Pflugh):

    Million is back at it again, asking the Federal Energy Regulatory Commission to reconsider his application for a preliminary permit. Million’s request comes on the heels of FERC’s dismissal of his preliminary permit. You may remember that Million turned to FERC after an earlier attempt to permit this project was terminated by the Army Corps of Engineers last summer. That’s two no’s in less than one year. Will a third do the trick?

    This week, Earthjustice, representing 10 environmental groups, filed papers with the Federal Energy Regulatory Commission (FERC) objecting to a do-over by FERC. FERC’s decision to deny the permit was right on the money and should have been the end of this scheme. But, with at least $1.4 billion at stake—according to Million—it’s easy to understand why he isn’t giving up easily…

    Earthjustice represents a coalition of ten conservation groups with interests throughout the Colorado River Basin: Sierra Club, Center for Biological Diversity, Rocky Mountain Wild, Save the Poudre: Poudre Waterkeeper, Biodiversity Conservation Alliance, Wyoming Outdoor Council, Citizens for Dixie’s Future, Glen Canyon Institute, Living Rivers: Colorado Riverkeeper, and Utah Rivers Council.

    More coverage from Mark Wilcox writing for the Wyoming Business Report. From the article:

    Aaron Million’s confidential business plan to annually pump about 81 billion gallons out of Flaming Gorge and the Green River that feeds it has been revealed to the Associated Press, and it is no small wonder he has not taken ‘no’ for an answer. The plan would bring in an estimated net profit of between $1.4 and $2.4 billion. And that’s after construction costs of somewhere between $2.8 billion and $3.2 billion. And end users of the water would pay up to $117 million in annual operating costs based on a “cost plus 20 percent” business model with estimated operating costs of between $70 million and $90 million…

    “Million’s plan is a blatant attempt to transform an important public good into billions of dollars of private profit,” said Earthjustice staff attorney McCrystie Adams in a statement urging the Federal Energy Regulatory Commission not to rehear Million’s request. Earthjustice represents various conservation clients on this issue. “We know from the developer’s public statements and documents that he’s looking for someone else to cover the millions of dollars of permitting costs that will undoubtedly be associated with what they describe as ‘the largest water infrastructure, pipeline, hydropower and storage project’ in the region.”

    Adams’ statement refers to portions of the plan showing that Million’s Wyco Power and Water Inc. is seeking to raise $15 million through 2015 to get through the permitting process. While the amount raised so far is confidential, $5 million has been spent on the permitting process.

    “It is clear that Million sees the Flaming Gorge Pipeline as his Mega-Millions jackpot and hopes someone else will pay for his tickets,” Adams wrote. “Fortunately, the odds of permitting this boondoggle are similar to winning the lottery.”

    More Flaming Gorge pipeline coverage here and here.

    Flaming Gorge Pipeline: Aaron Million estimates profits at $1.4 billion


    If you’ve wondered why Aaron Million has been so dogged in his pursuit of his pipeline dream facing while facing huge opposition across Wyoming, Colorado and Utah and from conservationists across the U.S., you need only to focus on the potential rewards from a for-profit operation in the middle of Colorado’s last remaining developable water in the Colorado River basin and the wealthy Denver southern suburbs. Here’s a report from Catharine Tsai writing for the Associated Press via The Colorado Springs Gazette. From the article:

    His team’s confidential business proposal, shown to potential contractors, estimates construction costs of $2.8 billion to $3.2 billion, with annual operating costs of between an estimated $70 million and $90 million per year being paid by water users.

    The project would initially deliver about 110,000 acre-feet of water to municipal and industrial users, with re-use available to farm and environmental interests, according to the business plan. The water would be sold under a “cost plus 20 percent” financial model, with 20 percent being added on top of costs for delivering the water. That would result in a one-time $360 million to $480 million profit to the contractor from water sales, according to the plan.

    The second stage of the project would deliver up to 140,000 acre-feet, with water sold at market rates. “Potential net profit is targeted in the $1.4 billion to $2.4 billion range,” the plan said.

    Though the business plan lays out staged development, Million said the project likely would be built all at once to avoid having infrastructure costs balloon over time. In any case, costs should be lower if it’s developed privately, not publicly, he said. “The project is financially sound. We think we can get it done for 30 to 40 percent less than a public sector project,” Million said.

    Million provided the business proposal to The Associated Press in response to questions about an earlier version of the plan obtained by the AP.

    The role of Million’s Wyco Power and Water Inc. would be to shepherd the project through the permitting process, Million said. It would earn a management fee, which could range from 0.25 percent to 3 percent of money raised for its work, he said. The plan said Wyco is seeking to raise $15 million through 2015 to get through the permitting process. Million said the amount he has raised so far is confidential, but he has said $5 million has been spent on the project during the four years since he proposed it.

    “We’ve finally learned what this proposal is about. It’s about people wanting to get extremely rich off of the natural wealth of the Colorado River and the communities up and down the basin that depend on it,” said Gary Wockner of Save the Colorado.

    More Flaming Gorge pipeline coverage here and here.

    IBCC: Wyco Water and Power, Inc. and the Colorado-Wyoming Cooperative Water Supply Project proponents briefed the state task force yesterday


    From The Pueblo Chieftain (Chris Woodka):

    A private developer and a public group who want to build major water supply pipelines from Flaming Gorge Reservoir in Wyoming to Colorado’s Front Range met Tuesday for the first time with a state task force. “Can both projects go? Folks, there should be collaboration. If this task force wants an additional task it could look at finding collaboration,” said Aaron Million, who first came up with the idea for the project about six years ago. “One of the outcomes of the task force has been a huge pushback from the environmental community.”

    Million’s Wyco Power and Water Inc. faces competition from the Colorado-Wyoming Coalition, led by Parker Water and Sanitation General Manager Frank Jaeger. The task force, formed at the request of the Arkansas and Metro basin roundtables, was formed to identify issues, interests and impacts associated with a Flaming Gorge project. It won’t recommend either project, and right now just has a growing list of questions and concerns…

    The Colorado-Wyoming Coalition still is investigating whether it even wants to pursue the project and is waiting on a Bureau of Reclamation determination of whether water is available, Jaeger said. “We don’t have all the answers,” Jaeger said. “We have to know what the Bureau of Reclamation plan says before we go any further.” The group has clearly identified it would serve a population of 569,000 in the next 60 years. The project would divert 100,000 acre-feet of water, which through re-use could provide about 200,000 acre-feet of need. About one-fourth of the water would go to communities in Wyoming.

    Million filed for water rights in 2007 on the Green River in Wyoming and has applied for a contract with Reclamation. He is using an earlier decision by Reclamation as the basis for his claim of 250,000 acre-feet. He has identified potential users, but does not have a specific list, unlike the coalition. So far, $5 million has been spent to develop his plan…

    While the project faces stiff opposition in Western Wyoming, there is a growing realization that the decision could be made without the area’s consensus. There is a spectrum of opinion heavily weighted toward stopping the project to those who realize control of the water is in someone else’s hands and the object is to reduce the impacts of diverting some of it. “I think our mission is to stay informed on the issues,” said Don Hartley, of the Rock Springs, (Wyo.,) Chamber Enterprise Committee. “We have to stay abreast of the issues with an eye to minimizing the impacts.”

    More Flaming Gorge Pipeline coverage here and here.

    The Norris Family plans to build the reservoir at the site eyed by both the Flaming Gorge Pipeline and the Southern Delivery System


    From The Pueblo Chieftain (Chris Woodka):

    The Norris family, owners of T-Cross Ranches, has filed a plan for the Marlboro Metropolitan Water District with El Paso County. “I’m going to build the reservoir,” said Steve Norris…“There has been lots of interest throughout the region for creating a regional storage reservoir.” Norris said it would hold nearly 30,000 acre-feet of water and would be built on land owned by the family and the State Land Board southeast of Colorado Springs. The application was filed earlier this month. The dam would be just south of the site targeted for the second phase of the Southern Delivery System. Colorado Springs Utilities, Security, Fountain and Pueblo West are building the SDS pipeline from Pueblo Dam, along with three pumping stations and a treatment plant. It is expected to be complete in 2016.

    The reservoir on Upper Williams Creek is contemplated several years after the first phase of SDS…

    The reservoir is also identified as terminal storage in Aaron Million’s plan to build a pipeline from Flaming Gorge Reservoir and the Green River in Wyoming. Million and Norris are longtime friends.

    More Arkansas River basin coverage here.

    Flaming Gorge pipeline: Aaron Million files a reconsideration request with FERC in response to their denial of the preliminary application


    From The Pueblo Chieftain (Chris Woodka):

    Environmental groups promise to fight the project at every turn, while a state task force will hear about Flaming Gorge pipeline proposals next week in Glenwood Springs. Fort Collins entrepreneur Aaron Million on Friday filed for a rehearing with the Federal Energy Regulatory Commission for his proposed 500-mile water pipeline from the Green River and Flaming Gorge Reservoir in Wyoming to Colorado’s Front Range. FERC rejected the application from Million’s Wyco Power and Water Inc. on Feb. 23.

    Million’s response states that FERC made errors in its determination that the application was filed prematurely. The basis was that the water pipeline associated with hydropower projects has not been constructed. “Wyco contends that sufficient information and maps associated with the pipeline alignment have been provided to the commission,” Million stated in an 11-page request for rehearing and clarification. “We’re asking for clarification of why the decision was made, other than political pressure. That shouldn’t be a factor,” he said.

    Million contends FERC has granted preliminary permits to other power projects in their infancy, including the Lake Powell pipeline project in Utah. He said Wyco plans to build the pipeline. Wyco already has issued requests for proposals to manage the project.

    On Tuesday, the Flaming Gorge task force, formed by the Colorado Water Conservation Board at the request of the Arkansas Basin and Metro roundtables, will hear presentations from Million and from Frank Jaeger, whose Colorado-Wyoming Coalition has proposed a similar, but competing project.

    More coverage from Electa Draper writing for The Denver Post. From the article:

    On Feb. 23, the Federal Energy Regulatory Commission dismissed Wyco Power and Water Inc.’s application for a preliminary permit on the basis it was premature. Officials said there was no purpose in issuing a hydropower permit without information on construction and operation of the pipeline, which Million couldn’t provide. Conservationists hailed the decision as a victory for the environment because, they said, Million’s project, which would divert water from the Upper Colorado River Basin to Front Range cities, would drastically lower the level of Flaming Gorge Reservoir, threaten four species of endangered fish, and further harm ecosystems, wildlife and recreation. “We hope that FERC will reject this appeal, and the project will die a much-deserved death,” wildlife biologist Erik Molvar said in a statement from the Biodiversity Conservation Alliance…

    Million, in a telephone interview from Fort Collins, said FERC had asked for some additional information when Wyco filed the application in September. If there were additional deficiencies in the application, he said, FERC should have told him before accepting the application. However, Million said, Wyco doesn’t need the FERC preliminary permit to keep moving forward with other elements of the project. “We already hold the water filings in the river and for federal water rights,” Million said. “We already hold the priority filings. We’re going to move through the process, regardless.”

    More coverage from Brandon Loomis writing for The Salt Lake Tribune. From the article:

    Utah has used the same rationale in seeking approval for a Lake Powell pipeline to St. George, and Million’s new application questions whether FERC imposed the same requirements in advancing that project. “Wyco contends that it will be counterproductive and cost-prohibitive to secure all necessary permits and authorizations to construct the pipeline without confirming the locations of the associated hydroelectric facilities,” the company said in its filing…

    “FERC certainly got it right the first time,” Earthjustice attorney Michael Hiatt said. “This project would clearly devastate the Green River.”

    More coverage from Troy Hooper writing for the Colorado Independent. Here’s an excerpt:

    Critics say the pipeline would drain 81 billion gallons of water each year from the Green River, a tributary of the already stressed Colorado River, and the state of Colorado projects the pipeline could cost as much as $9 billion to build. The Colorado River Water Conservation District, Wyoming Gov. Matt Mead, county and local governments in southwestern Wyoming and a multitude of conservation groups are opposing the potential pipeline that Million claims is needed for Colorado to meet its rising demand for water.

    “FERC made the right decision in February,” said Matt Rice, director of the Denver-based chapter of American Rivers. “It is clear this is nothing more than a speculative project that if ever built would severely harm the recreational, economic, agricultural and natural values of the Green River. Mr. Million is grasping for straws. It is highly unlikely that FERC will reverse their decision.”

    Gary Wockner of Save The Poudre added that “Mr. Million seems to think this process is like an Etch-A-Sketch, where he can just keep shaking and redrawing until he finally wears down the federal agencies and the opposition. The Flaming Gorge Pipeline is a fatally flawed concept that would devastate the Green and Colorado River ecosystems — we will fight it at every opportunity.”

    More coverage from Amy Joi O’Donoghue writing for the Deseret News. Here’s an excerpt:

    In a document filed Friday requesting a rehearing before the agency, Million argued that FERC should question if it erred by tossing his application for a permit in February on the basis that it was “premature” or incomplete…

    Million said the agency needs to consider if it let the amount of comments and objections on record by multiple agencies unduly sway the commission. Opponents like the Wyoming Game and Fish Department, the U.S. Forest Service, Sweetwater County and Colorado Springs Utilities — as well as numerous conservation organizations — have asked the commission to legally recognize objections raised.

    When the commission dismissed the preliminary permit application for Million’s Regional Watershed Supply Project, the agency said until the pipeline is built and authorizations are in place, it would be premature move the hydropower project forward. “The commission’s order implies that the final pipeline alignment, all authorizations to construct the pipeline and even the construction of the pipeline should be completed prior to filing an application for a preliminary permit” Million’s rehearing request said. Such a requirement, he added, is counterproductive and cost prohibitive absent knowing where the hydroelectric components would be sited…

    “The developer’s application for a rehearing is a waste of taxpayer dollars,” said Michael Hiatt, an attorney with Earthjustice.

    More coverage from Mark Wilcox writing for the Wyoming Business Report. From the article:

    Aaron Million and his company Wyco, first proposed the water project to the Army Corps of Engineers. The Corps rejected the application in July of 2011 after two years’s consideration because they said Million failed to provide sufficient information. Million then proposed the Flaming Gorge pipeline to FERC as a power-generating project that would simultaneously quench the Front Range’s thirst in Colorado, and received an initial dismissal Feb. 23. The multi-billion dollar pipeline would transport water more than 500 miles to a reservoir at its final destination in Pueblo, Colo. “As presented in Wyco’s application, these hydropower projects are exclusively dependent on water from the proposed water supply pipeline,” the dismissal stated. “However, this pipeline does not currently exist, and Wyco’s application does not provide any information about the timeline for seeking and obtaining the necessary authorizations for the construction and operation of such a pipeline.”

    Additionally, officials cited a lack of information on the route the pipeline would take through public and privately held lands. “Until…authorizations have been obtained for a specific route or the process to identify a specific route has been substantially completed, Wyco will be unable to prepare “[s]uch maps, plans, specifications, and estimates of cost as may be required for a full understanding of the proposed [hydropower] project,” the order read.

    While the initial government dismissal was based on technicalities, many environmentalist groups are pushing for a more permanent dismissal. “Anyone who tries to divert Wyoming’s Green River over the Continental Divide doesn’t appreciate the value that it provides for native fish and wildlife, local economies and the western way of life,” said Earthjustice attorney Michael Hiatt in a statement. “The Flaming Gorge Pipeline—one of the biggest, most environmentally damaging water projects in the history of the western United States—would irreparably damage the Green and the Colorado River downstream.”[…]

    Another group is now touring the region with a short film and presentation that reflect the damage the pipeline would do to Flaming Gorge and the Green River’s $118 million outdoor recreation economy. Studies indicate the lost water could raise salinity levels in the gorge and river to lethal levels for fish and other marine mammals. Opponents of the pipeline also indicate the potential downsides to mammals of building a 10-foot pipeline over the Continental Divide. “This thing is still on the rails,” said Walt Gasson, Trout Unlimited’s endorsed business director, “And still constitutes — to my way of thinking — to our way of thinking, a clear and present danger to wildlife conservation in Wyoming.”

    More coverage from Steve Lynn writing for the Northern Colorado Business Report. From the article:

    “[Wyco Power and Water Inc] respectfully requests that the commission grant re-hearing of the dismissal of preliminary permit application for the regional watershed supply project and to issue the preliminary permit for a term of 36 months,” the company stated in the document…

    The pipeline would help meet the water needs of Colorado, which faces a water supply shortfall of between 500,000 and 700,000 acre feet in the next two decades, Wyco principal Aaron Million has said. He contends the federal government will take steps to protect river flows for recreation as well as enhance fisheries.

    From the Denver Business Journal:

    The Associated Press reports that Aaron Million of Fort Collins filed the request Friday with the Federal Energy Regulatory Commission…

    FERC’s permission was needed for the pipeline’s water to be used to generate electricity.

    More Flaming Gorge pipeline coverage here and here.

    Parker: Rueter-Hess Reservoir celebration this week


    Parker and other South Metro communities will celebrate the opening of the largest Front Range reservoir since Aurora Reservoir this week. Here’s a report from Chris Woodka writing for The Pueblo Chieftain. From the article:

    Parker Water and Sanitation has completed Rueter-Hess Reservoir, a 72,000 acre-foot storage facility that will store water for Parker and surrounding communities in the South Denver area. “The project is a significant accomplishment for Parker Water and Sanitation District, its customers and the entire south metropolitan area. Congratulations is due all around,” said Frank Jaeger, manager of the district…

    Rueter-Hess has been in the planning stages for 25 years and under construction for the last eight. It cost $165 million to build, including $56 million from Castle Rock, Castle Pines North and Stonegate, which like Parker are located in Douglas County…

    The other Douglas County communities joined the project in 2008, expanding the capacity of Rueter-Hess by 56,000 acre-feet. The reservoir still must undergo state safety inspections before it can begin storing water. It will collect water flows from wet years for use during summer months and dry years. It is the largest Front Range reservoir to open since Aurora Reservoir with a capacity of 36,150 acre-feet, began filling in 1990.

    More Rueter-Hess Reservoir coverage here and here.

    Flaming Gorge Pipeline: The ‘Green with Envy’ tour hits Fort Collins March 22, Durango April 7


    From Westword (Alan Prendergast):

    Million’s plan, the subject of a 2009 feature by Joel Warner, calls for moving 81 billion gallons of water annually from the reservoir to municipalities in Colorado, including several in Douglas County. The costly project has hit a few snags, including a recent refusal by the Federal Energy Regulatory Commission to grant a preliminary permit. But the river’s defenders are keeping the pressure on with their own education campaign.

    “The fight is far from over,” the promoters of the film claim in a press release. “Aaron Million, the wealthy entrepreneur behind the project, has already announced he will resubmit a stronger proposal in the near future.”

    Green With Envy plays in Fort Collins on March 22 and in Durango on April 7. For more information, check out the It’s Our Dam Water website.

    More Flaming Gorge pipeline coverage here and here.
