Upper Thompson Sanitation District and the Town of Estes Park to turn dirt on sanitary sewer project

Estes Park

From The Estes Park Trail-Gazette (Tyler Pialet):

Through an Intergovernmental Agreement, the Upper Thompson Sanitation District (UTSD) and the Town of Estes Park (TEP) are partnering to complete a utility infrastructure project that will impact the Fish Creek Lift Station and Mall Road.

The work, which is expected to start on Jan. 28, will start with replacing a single, 45-year-old sanitary sewer force main with new, dual-force mains. These will extend from the Fish Creek Lift Station, located on Fish Creek Road next to Lake Estes, across U.S. 36 to UTSD’s gravity sewer main near Joel Estes Drive.

“UTSD recognized the lift station force main was a critical piece of infrastructure, had been in operation for 40 years, and due to its design features, had received minimal maintenance,” said UTSD District Manager Chris Bieker.

Bieker explained that force mains are pressurized sewer pipes that convey wastewater where gravity is not possible.

“Moving the flow uphill requires a pump,” he said. “Pumping facilities called lift stations may be required to transport the wastewater through the collection system.”

According to Bieker, “The Fish Creek Lift Station and approximately 1,000 linear feet of 14-inch diameter cast iron force main was constructed in the mid-1970s. The interior of the force main is cement mortar lined. Approximately 600 linear feet of force main is located south of Highway 36. The remaining 400 feet crosses north underneath HWY 36 and discharges to a manhole located in Mall Road. Wastewater then flows along Mall Road through approximately 1200 linear feet of gravity sewer main to the treatment facility…

In late 2016, the District televised the interior of the force main. The video indicated cracking and delamination of the cement mortar pipe lining within sections of the force main. The televising operation prematurely ceased when the camera could not proceed any further due to the internal conditions of the pipe.”

New piping and valves will be added to the Fish Creek Lift Station. Old, aging pipes and valves will be replaced to facilitate new parallel force mains. As the Fish Creek Lift Station manages over a third of all of the district’s water flows, these improvements are critical to UTSD operations and public health.

#Colorado-Big Thompson Project operations update: @USBR expects releases to the Big Thompson River to increase significantly

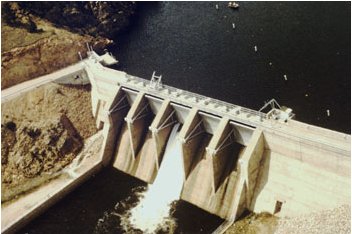

Olympus Dam releases June 2011.

Here’s the release from Reclamation (James Bishop):

The Bureau of Reclamation is forecasting a notable increase in releases from Olympus Dam to the Big Thompson River beginning on September 20, 2018.

As of today, September 18, releases from Olympus Dam into the Big Thompson River are at 26 cubic feet per second (cfs). Between September 20th and October 12, releases are expected to rise to approximately 225 cfs.

This forecast assumes native inflows into Lake Estes as well as irrigation demands will not change significantly from our current projections, but both are subject to unexpected fluctuations.

“I was at the #BigThompson disaster” — Allen Best

Here’s the Coyote Gulch 40th anniversary post from 2016. There’s a great passage from Allen Best who was part of the rescue effort back then. Click through for all the links to the Coloradoan and other online content.

If you live in Denver subscribe to The Denver Post. Their link for Allen’s article is still up. And since I”m pitching journalism here subscribe to Allen’s Newsletter.

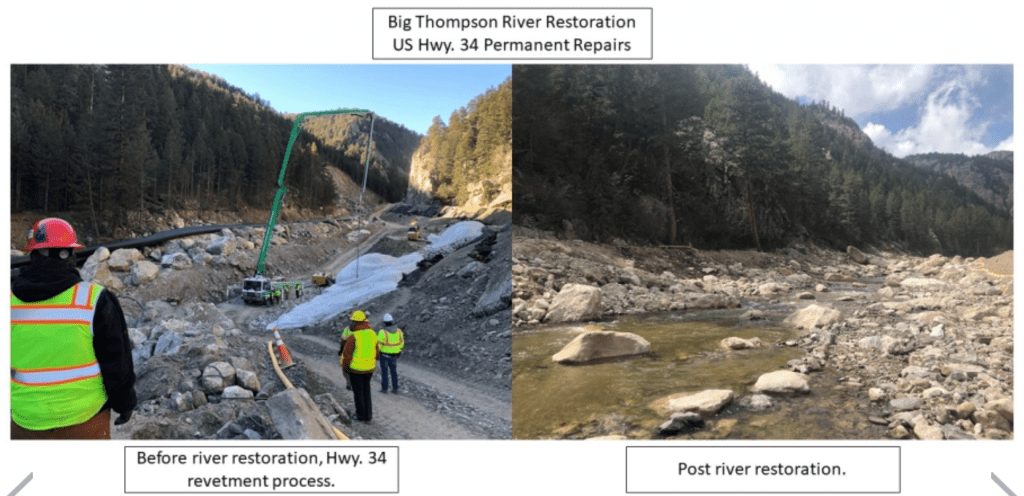

Larimer County and the Big Thompson Watershed Coalition score $175,342 for river restoration

From The Loveland Reporter-Herald (Pamela Johnson):

The county commissioners on Tuesday approved a contract to work with the nonprofit river coalition on continued revegetation in key areas of the flood-damaged canyon with a $175,342 grant from the Colorado Water Conservation Board. To match the grant, the county and watershed coalition will put in $175,386, part in cash and part in staff and volunteer resources.

Commissioners Donnelly and Steve Johnson voted 2-0 at their weekly administrative matters meeting to approve the contract, allowing county resources to be used for the project. Lew Gaiter, the third commissioner, was absent.

The county’s in-kind contribution will be worth $23,490, including work by weed specialist Casey Cisneros, and its cash share will be $94,797 from the Larimer County Disaster Fund. The watershed coalition will pitch in $7,250 in cash and $49,849 of in-kind help, including volunteer labor.

This project will focus on the Big Thompson River near Drake, Cedar Cove and Jasper Lake as well as the North Fork of the Big Thompson from Drake all the way to Glen Haven.

Restoration projects have focused heavily on both private and public land along these areas, but additional work is needed for continued weed management and erosion control, said Shayna Jones, coalition director.

“These are areas that received a lot of time and effort in the past,” said Jones. “This is about making sure those improvements are maintained and stay on the right trajectory. … We’ll be able to identify the key focal areas that need a little more attention.”

This work, Donnelly said, is important to the fishery of the river, which is an economic driver for the region, to recreation along the river and to the quality of water that the river delivers to residents, including those who live in Loveland. These projects, he said, help restore the ecosystem and all river functions.

#Snowpack news: @NorthernWater to set C-BT quota on April 12th

Westwide SNOTEL basin-filled map March 17, 2018 via the NRCS.

From The Fence Post (Nikki Work):

As of March 14, the state sits at about 67 percent of the average snowpack, according to the Natural Resources Conservation Service.

Things are looking slightly better in northern Colorado, with the two basins that impact Weld County — the Upper Colorado and the South Platte — at 77 percent and 81 percent of the average year, respectively…

Eric Brown, spokesperson for the Northern Colorado Water Conservancy District, said the dry weather is on Northern Water’s radar, just like it’s on farmers’, but there may be one saving grace — a healthy amount of water in reservoir storage.

Northern Water’s reservoirs are at one of their highest ever levels, with storage at 121 percent of average. Across Colorado, reservoir storage is at about 117 percent of the historic average. While Brown said the water district is optimistic that, in true Colorado fashion, there’s a big spring storm a’comin’, its prepared to use some of its reserves to combat an abnormally dry year.

“In general, farmers who have access to some sort of water in storage should be okay for 2018, as Northern Water’s C-BT Project and reservoirs across the South Platte Basin are sitting at solid levels for the most part,” Brown said. “But for the farmers who don’t have access to water that’s in storage, they really need snow and/or spring rains in the near future.”

But for everyone, use of the water in storage this year creates uncertainties down the road, as some of the current surplus will be used up. Plus, a good, wet snow would bring some much-needed moisture to the plains and help with soil quality, which plays an important role in crop health.

The Northern Water Board will set its quota for C-BT deliveries for the remainder of the 2018 water delivery season at its April 12 board meeting. Both snowpack and C-BT and local non-C-BT reservoir levels will factor into this decision. The board sets a quota each year to balance how much water can be used and how much water needs to stay in storage, and the historic average for the quota is 70 percent.

Colorado-Big Thompson Project Map via Northern Water

A look at the #Colorado-Big Thompson Project #ColoradoRiver #COriver

First water through the Adams Tunnel. Photo credit Northern Water.

From The Loveland Reporter-Herald (Kenneth Jessen):

The drought of the 1930s was the impetus for the Colorado-Big Thompson Project.

Work started in 1938 and would span nearly two decades to complete.

The first project was the Green Mountain Reservoir on the Blue River. The water stored ran north into the Colorado River and is used to compensate for water that would be diverted to the Eastern Slope.

A significant year for the project was 1944 when work ended on the Alva B. Adams Tunnel, just over 13 miles long. It carried water under the Continental Divide.

Lake Granby, the largest reservoir in the system, stores Colorado River water during the spring runoff. A second project was the nearby Shadow Mountain Reservoir connected to Grand Lake by a short canal. The two bodies of water are nearly 90 feet higher than Lake Granby.

The Alva B. Adams Tunnel’s west portal is on the east side of Grand Lake which, incidentally, is the largest natural water body in Colorado.

After the spring runoff and to keep Shadow Mountain Reservoir and Grand Lake filled, a pumping station brings Lake Granby water up to their level.

Added in 1951-52 and on the west side of the Continental Divide is the Willow Creek Reservoir. A pumping station elevates the water 175 feet to a canal flowing into Lake Granby.

The 9 ½ -foot in diameter Alva B. Adams Tunnel drops 109 feet in its 13 miles, ending at the East Portal.

From a small lake at the East Portal, the water is carried via a siphon under Aspen Brook to the Rams Horn Tunnel and via a penstock, down to the Marys Lake power plant. This is a drop of 205 feet.

Running directly under the summit of Prospect Mountain, yet another tunnel and penstock delivers water to the Lake Estes power plant, a drop of 482 feet.

From Lake Estes, water flows east first through the Olympus Tunnel to the 5 ½ -mile long Pole Hill Tunnel.

Water is delivered to the top of a canal then to a penstock. It drops 815 feet to the Pole Hill power plant. From there, the water enters the 1 ¾ -mile-long Rattlesnake Tunnel, ending on the west side of Pinewood Lake. An intake on the east end of Pinewood Reservoir takes water through the Bald Mountain Tunnel to the penstock visible from Loveland.

Water is delivered to the Flatiron power plant at Flatiron Reservoir over 1,000 feet below.

This is where things get complicated.

During times of excess water, it is pumped up to Carter Lake, 277 feet higher.

Water also flows through a short tunnel north to the Hansen Feeder Canal to Horsetooth Reservoir.

From the south end of Carter Lake, water is delivered into the South St. Vrain Supply Canal. This long canal takes water under part of Rabbit Mountain all the way the Boulder Reservoir.

In all, West Slope water drops nearly 3,000 feet during its journey to the East Slope.

The Colorado-Big Thompson Project has created a dozen reservoirs, uses 35 miles of tunnels and also generates a substantial amount of electric power. These are the power plants:

Marys Lake

Estes Park

Pole Hill

Flatiron

Green Mountain

Big Thompson

Trout

@USBR to Hold Public Meeting on Estes Valley Resource Management Plan for Lake Estes, Marys Lake and East Portal

Aerial view of Lake Estes and Olympus Dam looking west. Photo credit Northern Water.

Here’s the release from Reclamation (James Bishop):

The Bureau of Reclamation, in cooperation with Estes Valley Recreation and Park District (EVRPD), is seeking public input on a Resource Management Plan (RMP) for Lake Estes, Marys Lake and East Portal lands.

The agencies will host an open house where the public can learn and ask questions about the resource management planning process, the lands affected by the plan, and provide comments. The open house will be held on Wednesday, October 25, 2017, from 6 to 8 p.m. at Estes Park High School Commons, 1600 Manford Avenue, Estes Park, Colo. Public comments will be welcomed in writing at the open house and throughout the 30-day public comment period.

The 30-day public comment period will begin on Wednesday, October 18, 2017 and will end at close-of-business on Friday, November 17, 2017. Comments must be provided in writing and can be submitted by e-mail, fax, or regular mail. E-mail comments can be sent to EstesRMP@usbr.gov, and faxed comments can be sent to the attention of Ms. Justina Thorsen at (970) 663-3212. Regular mail comments should be sent to the attention of Ms. Thorsen at: Bureau of Reclamation, 11056 W. County Road 18E, Loveland, Colo. 80537.

Reclamation is preparing the Estes Valley RMP. The agency will also prepare an Environmental Assessment in compliance with the National Environmental Policy Act. Reclamation owns and operates the Colorado-Big Thompson project, which includes Lake Estes, Marys Lake, East Portal, and the surrounding federal lands. Through a management agreement with Reclamation, EVRPD is responsible for managing recreation at Lake Estes, Marys Lake, and East Portal. The RMP will guide future recreation development as well as the management of natural and cultural resources on federal lands.

Media inquiries or general questions about Reclamation should be directed to James Bishop at 970-962-4326 or jbishop@usbr.gov. Specific questions about the resource management planning process should be directed to Justina Thorsen at 970-962-4207 or EstesRMP@usbr.gov.
