Thornton Water Project update

From The Greeley Tribune (Cuyler Mead):

[Ted] Simmons is one of more than a hundred landowners — some who have been there for generations — who received a letter in recent weeks from an agent of the city of Thornton.

The letter offers Simmons and his neighbors a sum of money — Simmons reckoned the city is figuring about $7,500 per acre — for a permanent easement that would allow the city to build a jagged-lined water pipeline, north to south, across Weld County into Thornton.

“The current proposal makes that piece of land almost unusable,” Simmons said. “I can still put up hay, but for the future, if you want to do any plans in the future, it pretty much destroys the whole piece. You can’t build over it.”

[…]

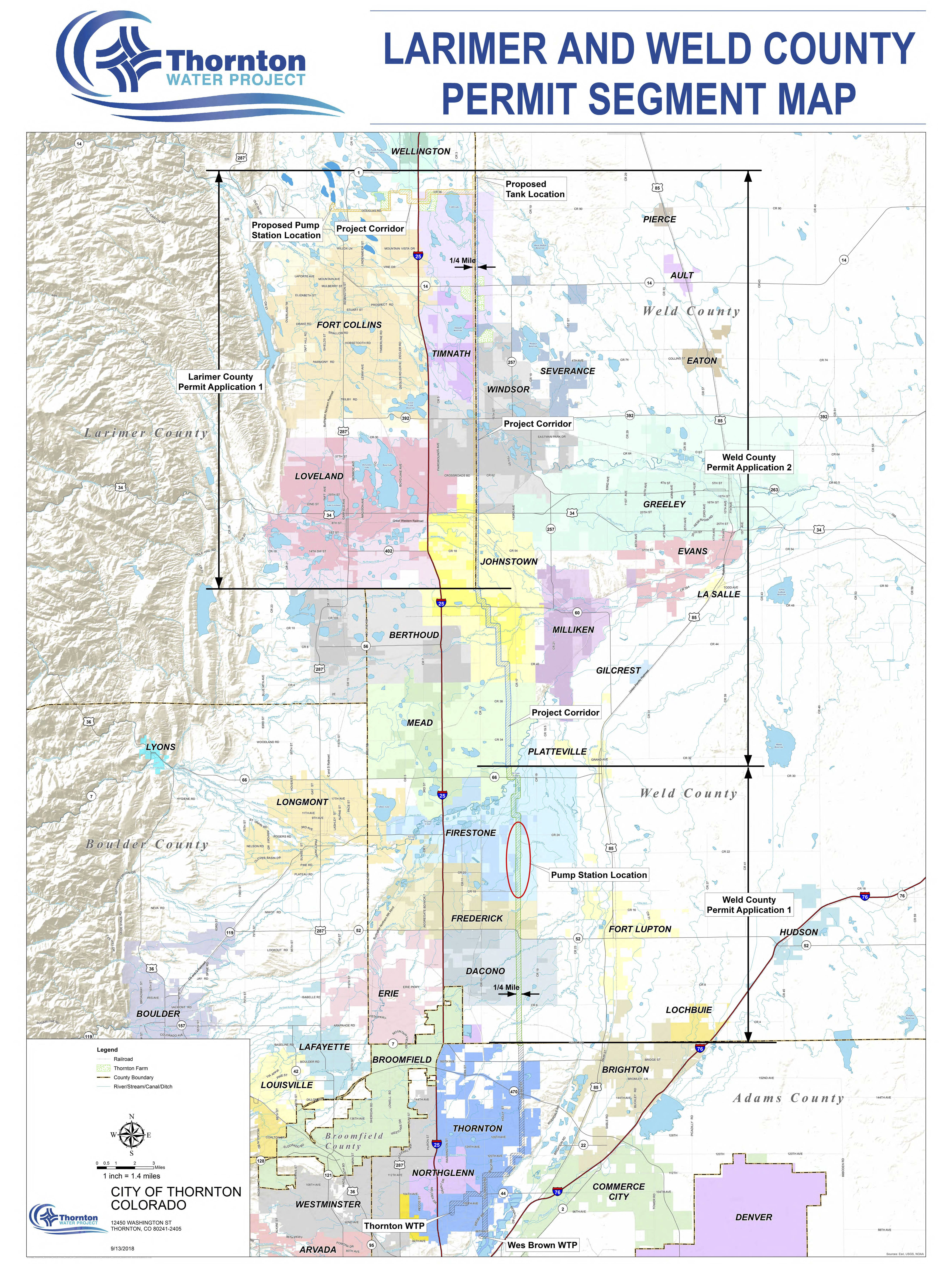

Thornton Water Project map via http://thorntonwaterproject.com

The permitting process has been a bit rocky. It involves both Larimer and Weld counties, and the commissioners of each county have thrown various hurdles in the way of the city which resides in neither of their jurisdictions.

Initially, the project proposed to take Weld County Road 13 much of the way south. But there was concern on the part of the Weld commissioners that that was unfair to the landowners along that stretch of highway.

“We said we were not willing to put the pipeline in our right of way,” Weld County commission chairman Mike Freeman said by phone this week. “The reason is, with farming, they farm up to the county road. So it still impacts the landowners as much. The landowners need to be paid for these easements. It’s going to impact them, so they need to be paid.”

About 160 parcels are crossed, Koleber said, as the hypothetical pipeline traverses Weld County. And the commissioners weren’t making things any easier on Thornton, either.

“Weld commissioners said, ‘We want you to acquire all of the easements that you need for the pipeline ahead of time,’ before they even look at the permit,” Koleber said. “That’s reverse of how a project normally goes. Permit-design-right of way-construction. They flipped that and continued our process for a year, from July 2019 to July 2020.”

That said, roadblocks or not, Weld has been substantially more accommodating than Larimer. There, the commissioners rejected the permit application and are on their way to court with the city of Thornton. Freeman said that that’s not the plan in Weld.

“We want to make sure they’re treating people fairly,” Freeman said. “We can’t get in the middle of negotiation, whether they’re paying enough, but we want to make sure they’re getting those easements secured, not coming in and saying, ‘We’ve got 30%.’ We’re not going to approve a pipeline if we don’t know where it’s at … but if they come in with an application demonstrating it’s complete, and it’s a good one, more than likely we’d approve it.”

But the landowners — at least some of them — aren’t thrilled with the idea of giving up a strip of their property to the underground pipeline, even if it can be farmed right over the top of it as Thornton claims.

That’s because, like Simmons, the value is less in agriculture now than it is in development potential. Houses or other municipal space are where the future is.

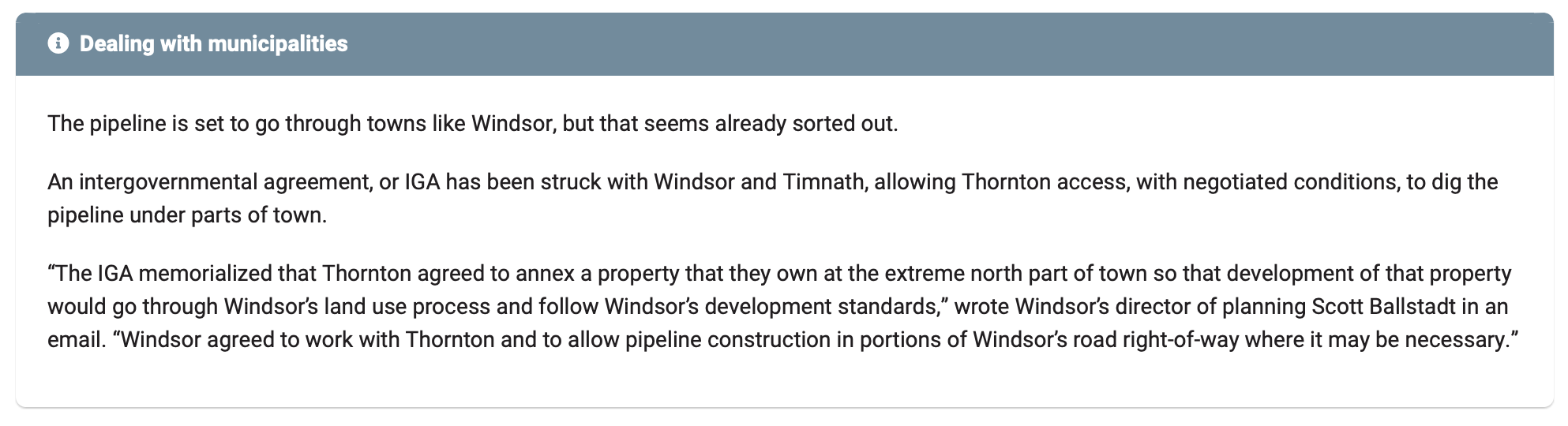

Simmons and his neighbors, including Ken and Sue Kerchenfaut, would much rather the pipeline go down Weld County Road 13, actually. But if that’s not an option, Simmons has another idea, too. Rather than jutting through the various properties in a zig-zagging line, why not take a straight shot parallel path with an existing Sinclair Energy pipeline that already stripes his and many of his neighbors’ land?

[…]

Like it or not, it seems they’ll probably have to give up the easement one way or another. Thornton feels comfortable its eminent domain powers will be backed up in court, should it get that far.

And they’re probably right.

Thornton is a home rule charter, and such entities are granted quite broad eminent domain power for the sake of a public good by the Colorado constitution. That’s what an expert on the subject, University of Colorado professor Richard Collins, said by phone this week.

“The home rule powers of the constitution explicitly authorize home rule charters to have eminent domain,” Collins said. “So there’s really not much doubt that a home rule city would have broad powers of eminent domain.”

Sedimentation problems necessitate diversion structure overhaul for Lake Nighthorse intakes

From The Farmington Daily Times (Hannah Grover):

No water will be pumped from the Animas River into Lake Nighthorse this year.

That is because the headgates at the dam southwest of Durango, Colorado, have to be destroyed and replaced, according to Animas-La Plata Project Operations, Maintenance and Repair Association General Manager Russ Howard.

Howard told the San Juan Water Commission on March 4 that the $6.5 million project is needed because the design was not appropriate for the location. This work is being done by the U.S. Bureau of Reclamation.

He said work was also done prior to choosing to replace the gate. Howard said $1.5 million was spent “over the years trying to put a Band-Aid on something that shouldn’t have been there in the first place.”

When asked about the gate, Howard said the design, known as an Obermeyer, gate is not a bad design, but it was not appropriate for the Animas River.

Lake Nighthorse and Durango March 2016 photo via Greg Hobbs.

U.S. Bureau of Reclamation spokeswoman Justyn Liff agreed with Howard that the design was a good design but was not compatible with the Animas River’s conditions. She said on another river it would have worked fine, but the bureau had not realized how muddy the Animas River is.

The amount of mud in the Animas River caused problems and filled the pipes with mud.

In addition to the $6.5 million replacement of the headgates, Liff said the the gate’s original construction, retrofits to keep them operational and engineering studies and design cost about $6.2 million.

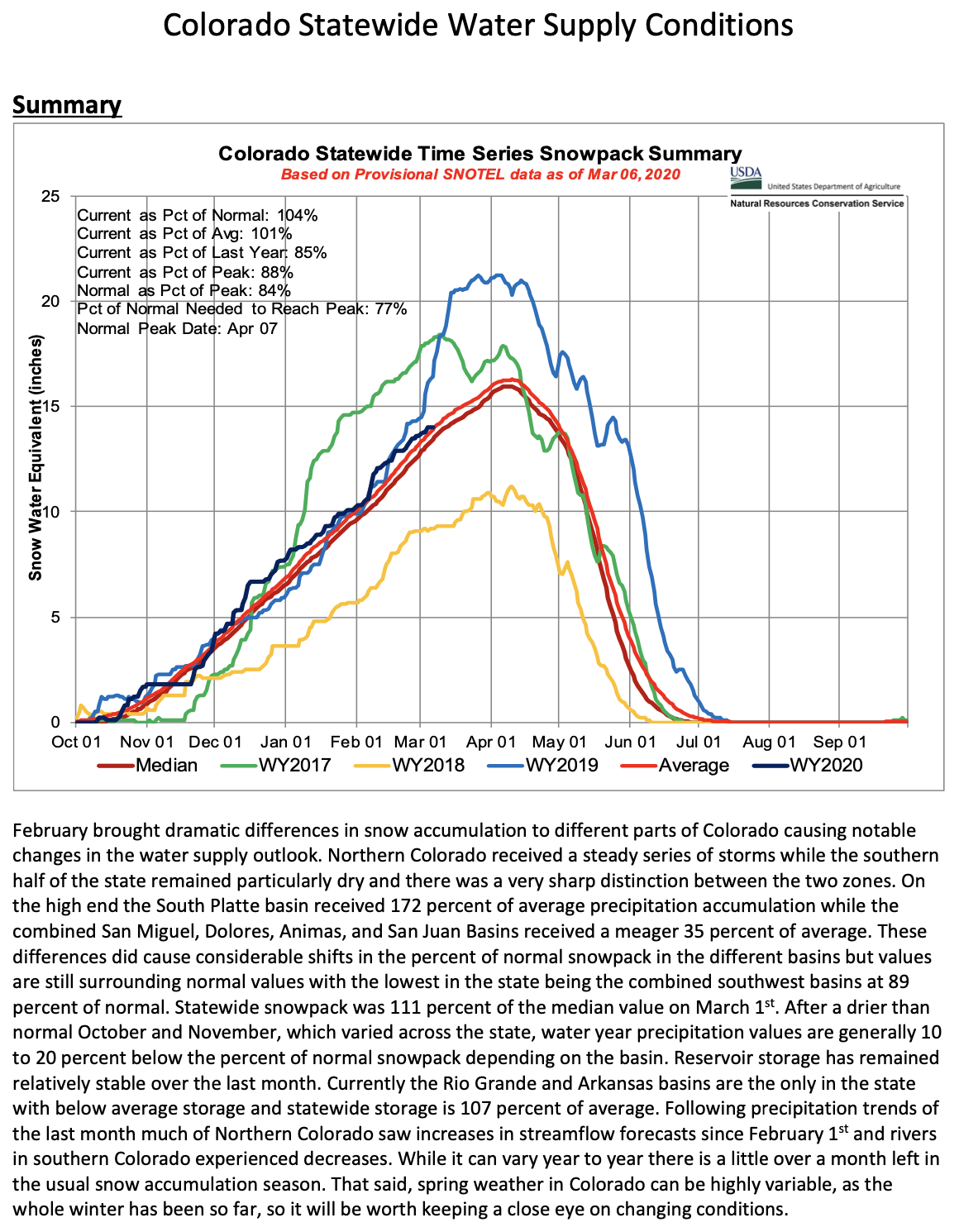

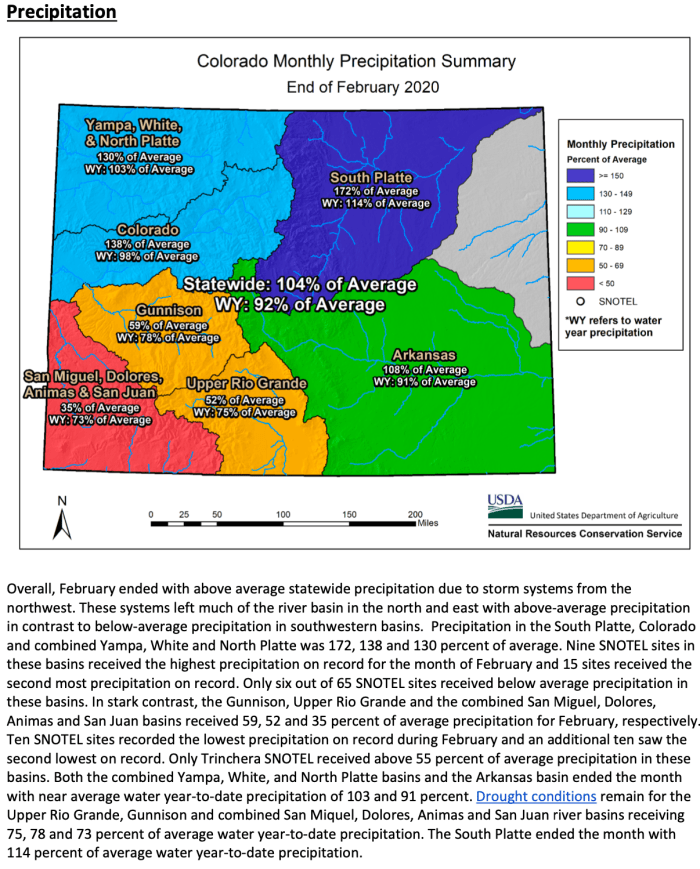

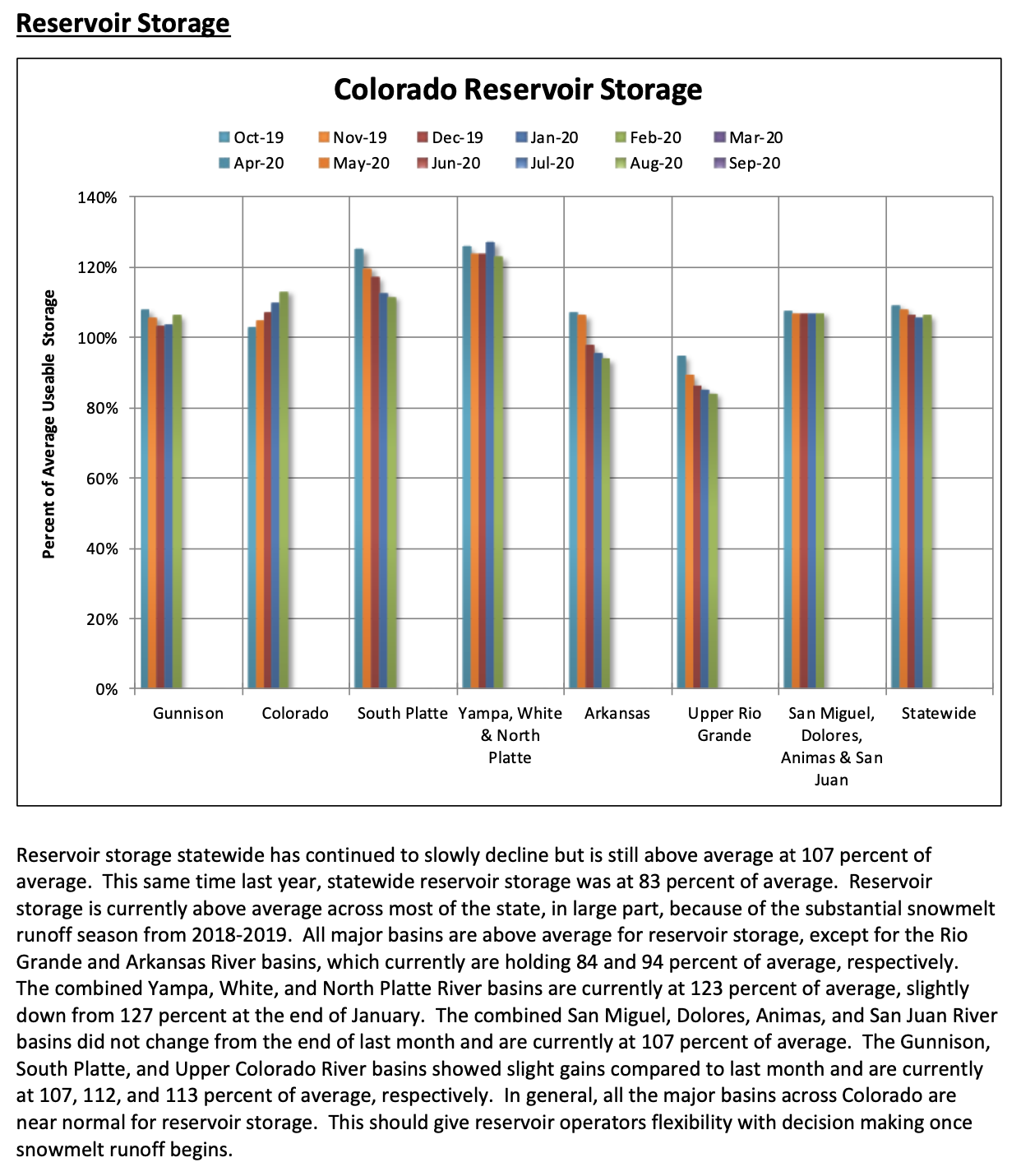

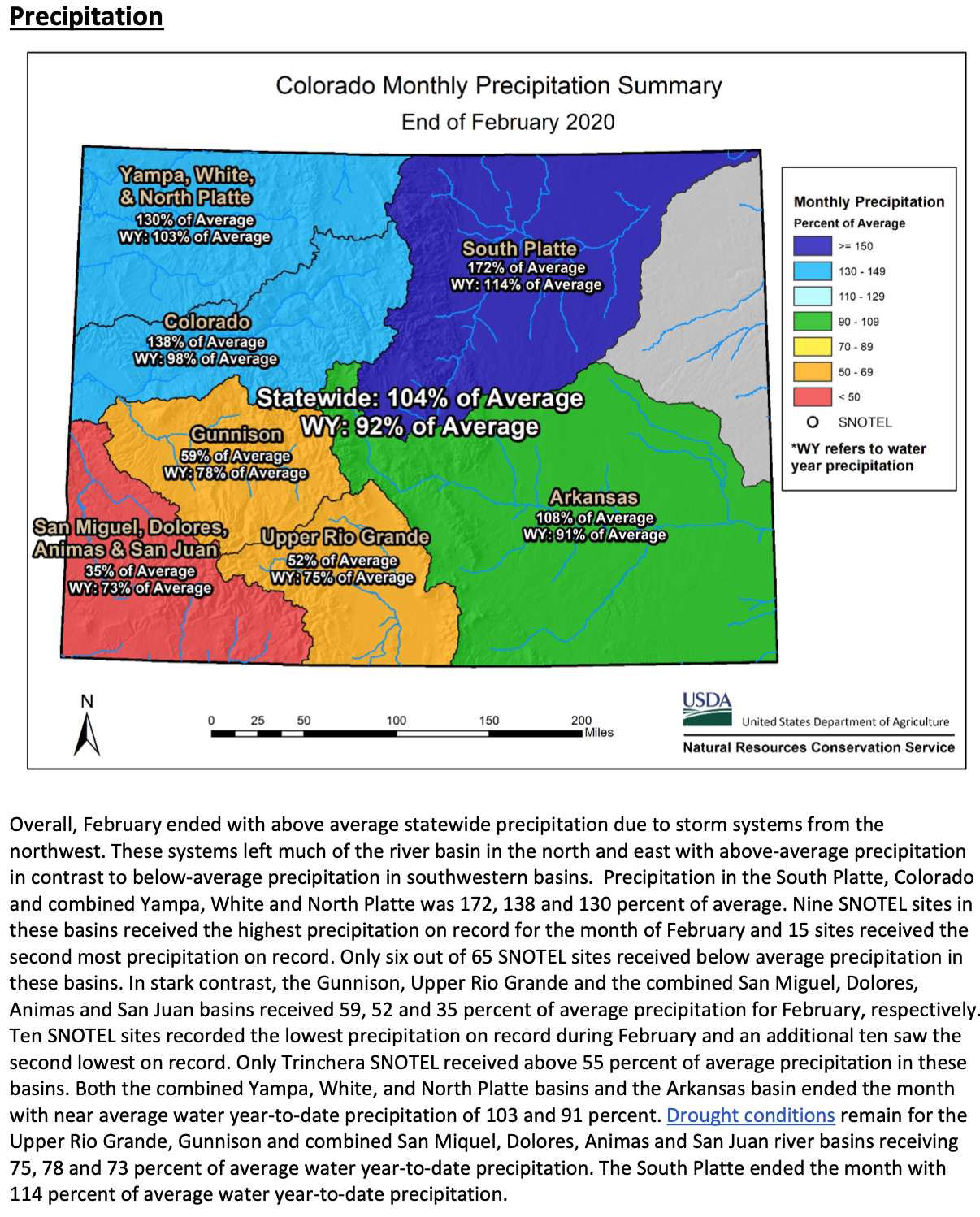

The March 2020 #Colorado #Water Supply Outlook Report is hot off the presses from the NRCS

Click here to read the report. Here’s the summary:
